Partial Kitchen Remodel Cost

Plan a medium-scope kitchen remodel by defining what stays, what changes, and how cabinets, counters, finishes, and hidden conditions affect the quote.

On this page

A partial kitchen remodel is a coordinated middle scope: more than paint and hardware, but less than removing and rebuilding nearly everything. Because “partial” is not a standardized contract term, define the retained and replaced components before discussing cost.

A practical definition

A typical partial project may replace cabinets and countertops, update backsplash and paint, and coordinate selected lighting or finish work while retaining the room footprint and many utility locations. Some projects add a pantry, island, or appliance coordination without moving the sink, cooking zone, or walls.

The same label can describe very different work. One contractor may include cabinet installation and disposal; another may leave them as allowances. One may include countertop cutouts and plumbing reconnection; another may exclude them.

Build the budget from retained conditions

Retained condition Potential saving Risk to check
Cabinet layout Less redesign and finish patching The existing arrangement may limit function or storage
Utility locations Less plumbing, electrical, gas, and ventilation routing Capacity, code, and compatibility still need review
Sound walls and floors Less preparation and restoration Old uneven surfaces can complicate installation
Existing appliances Less purchase scope Openings, clearances, connections, and future replacement fit

Replacing cabinets and counters without checking the supporting walls, floor, sink base, and appliance dimensions can turn a “partial” job into a change order.

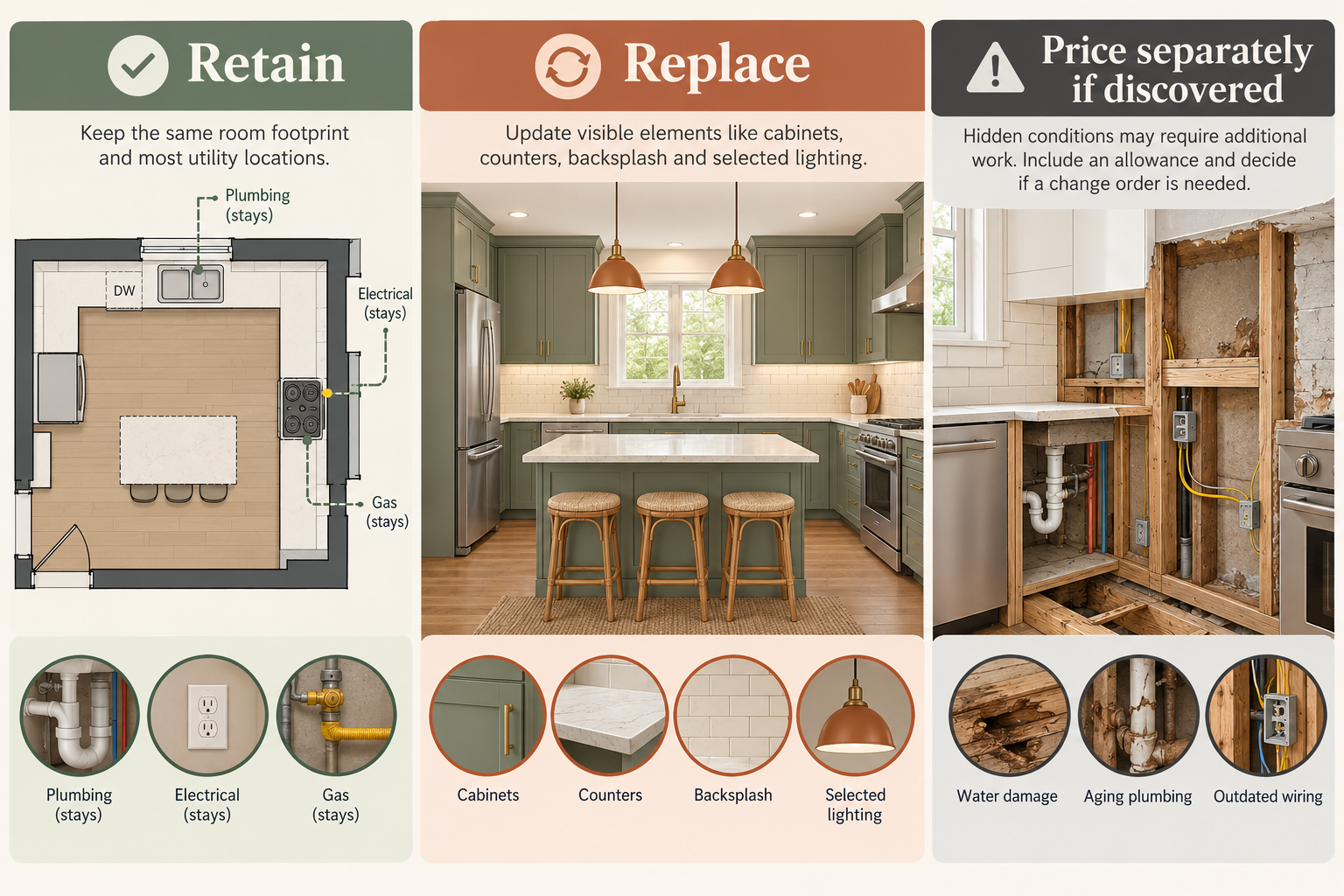

A partial kitchen remodel retains the room footprint and many utility locations, replaces selected components, and prices concealed-condition work separately if discovered.

Main cost components

  • Cabinet product class, fillers, end panels, trim, hardware, delivery, assembly, and installation.
  • Countertop material, templating, cutouts, seams, edges, supports, removal, and installation.
  • Backsplash removal and preparation, paint, flooring transitions, and protection.
  • Lighting or ventilation coordination while walls or cabinets are open.
  • Demolition, disposal, temporary protection, delivery, and cleanup.
  • Design, permits, inspections, and separate trade work where applicable.
  • Allowances for water damage, uneven surfaces, old wiring or plumbing, and incompatible retained components.

The 2026 U.S. Houzz study reported a $20,000 median for its minor-project group and $55,000 for its major-project group. Those source-defined groups show the scale difference but do not define a partial remodel. Canadian specialist guides use their own project classes and require local CAD validation.

The false-economy test

Partial work is strongest when the retained components are serviceable and the new work will not need to be removed to complete a likely next phase. It is weaker when a new countertop would later be removed for cabinet replacement, when a temporary backsplash blocks future utility access, or when an unsolved leak will damage new finishes.

Ask whether the current phase preserves a durable interface. If the answer depends on an uncertain cabinet box, future layout, or concealed utility condition, price the inspection and contingency before assuming the partial option is cheaper.

Three useful partial-remodel boundaries

Cabinets and counters, same layout. This can keep utility routes and the room footprint stable, but it still needs a measured cabinet schedule, a final countertop plan, removal, delivery, installation, plumbing disconnect/reconnect assumptions, and backsplash decisions. Confirm that the new units fit actual walls and appliances before treating the existing layout as a fixed constraint.

Cabinet retention with new surfaces. This reduces cabinet replacement scope only if the boxes are dry, stable, adequately mounted, and appropriate for the new counter and hardware. The cabinet installer or fabricator should state what condition they will accept and what happens if removal exposes damage or the surface is not level enough for templating.

A partial layout adjustment. Adding a pantry, changing an island, or moving one zone can appear limited on a plan, while the work may still involve counter seams, flooring patches, electrical or plumbing routes, ventilation, or approval checks. Price the route and restoration, not only the visible item being moved.

These boundaries are examples, not standard industry packages. Use them to describe your own scope in ordinary language. A useful bid states the quantities and finish assumptions, the components retained, and which conditions are allowances rather than confirmed work.

Separate known work from conditional work

Make the base estimate cover work that can be measured before demolition. List uncertain items in a separate allowance or unit-price schedule: for example, localized wall repair after backsplash removal, leveling discovered after cabinets are removed, or a utility correction found during rough-in. An allowance is not a promise that the amount will be enough. Ask what observation triggers its use, who documents it, what approval is needed, and whether unused funds are credited back.

Compare the same set of decisions in each bid. If one price assumes the old sink, appliances, and backsplash remain while another includes disconnects, removal, and replacement, the total alone says little. If a retained component is close to end of service or must be removed to complete the next likely phase, include that future work when comparing the partial option with a broader rebuild. The goal is a durable result for the chosen phase, not the smallest first invoice.

Decide which retained items deserve an inspection

Do not give every existing component the same level of scrutiny. Focus first on the parts that support or constrain new work: cabinet attachment and levelness before a new counter; wall and floor condition before new cabinets; the sink base before cosmetic covering; and utility capacity and routing before changing an appliance zone. Inspection does not guarantee there are no concealed issues, but a written condition check can reveal whether the proposed budget rests on a sensible assumption.

For each retained item, record whether it was inspected, what was observed, what remains uncertain, and who pays if the assumption proves wrong after removal. This is more useful than a single “existing conditions” allowance. Ask for a clear stop-and-approval point before an uncertain repair changes the price or schedule.

A sample bid comparison

Put the competing estimates into the same columns: cabinets and install; countertop and fabrication; backsplash and wall repair; electrical or lighting; plumbing disconnect/reconnect; demolition and disposal; protection and cleanup; permits and fees; allowance for concealed conditions; and excluded work. Leave a line blank when a quote omits it instead of assuming it is included. The worksheet will show whether a lower bid is a lower-cost version of the same result or simply a narrower project.

Compare with the other scopes

  • A cosmetic refresh is mainly visible finish work with sound underlying components.
  • A partial remodel replaces meaningful room components while retaining a workable structure and layout.
  • A gut remodel removes most of the room and coordinates a broad rebuild.

For each option, request the same measurement, retained-condition assumptions, and exclusions. The most useful comparison is not partial versus full by name; it is the resulting room, the work deferred, and the risk of paying twice.
