Keeping a kitchen layout usually means retaining the main cabinet runs, sink and dishwasher zone, cooking zone, refrigerator area, and circulation pattern. A new cabinet style alone does not change the layout. Moving one functional zone can trigger several other scopes at once.
What layout retention can avoid
With a workable existing arrangement, the project may avoid or reduce cabinet redesign, countertop redesign, plumbing and drain relocation, electrical and gas changes, duct rerouting, flooring patches, wall repairs, and permit or inspection coordination. It can also reduce schedule dependencies between cabinet installers, fabricators, and trades.
That is a potential saving, not a guarantee. Existing wiring, plumbing, ventilation, levelness, and clearances still need to be checked before they are reused.
In Houzz’s 2026 U.S. kitchen survey, 52% of respondents with completed, underway, or planned kitchen projects said they modified the layout. The survey is based on Houzz users and does not establish how common layout changes are among all homeowners or what they cost. It is a reminder to define the proposed layout clearly before comparing bids, not evidence of a standard layout-change premium.
Common changes and their consequences
| Change | Potentially affected work |
|---|---|
| Move the sink or dishwasher | Water supply, drain, cabinet, countertop cutout, flooring or wall access |
| Move the range or cooktop | Circuit or gas connection, ventilation, counter cutout, fire and clearance review |
| Move the refrigerator | Outlet, cabinet surround, floor path, and door-clearance planning |
| Add or enlarge an island | Cabinet, countertop support, circulation, flooring, and possibly plumbing/electrical |
| Remove or add an opening | Structural review, finishes, permits, and adjacent-room restoration |
The utility relocation guide covers these interfaces as a group. Independent plumbing, electrical, ventilation, or structural work belongs to the corresponding specialist scope.
The functional-value test
Changing the layout can be worth the added cost when it fixes a recurring problem: blocked circulation, unusable storage, poor work zones, insufficient landing space, or a cooking and cleanup arrangement that does not fit the household. The decision is weaker when the change mainly moves cabinets without improving use, or when it requires a costly utility path for a small visual benefit.
Ask the designer or contractor to show both options with the same cabinet, countertop, finish, and appliance assumptions. Then compare not only the initial price but also disruption, future flexibility, and the work that would otherwise be repeated.
Access is a major cost driver
Utility distance is only part of the problem. A framed floor over an accessible basement or crawl space may offer a different path from a slab, a finished ceiling below, or a floor that must be restored. A new duct route may require exterior penetration and cabinet changes. A new circuit may reveal capacity or panel constraints.
Do not use a universal “layout-change premium.” Ask each bidder to identify the access condition, route, finish repair, design, permit, and coordination assumptions behind the price.

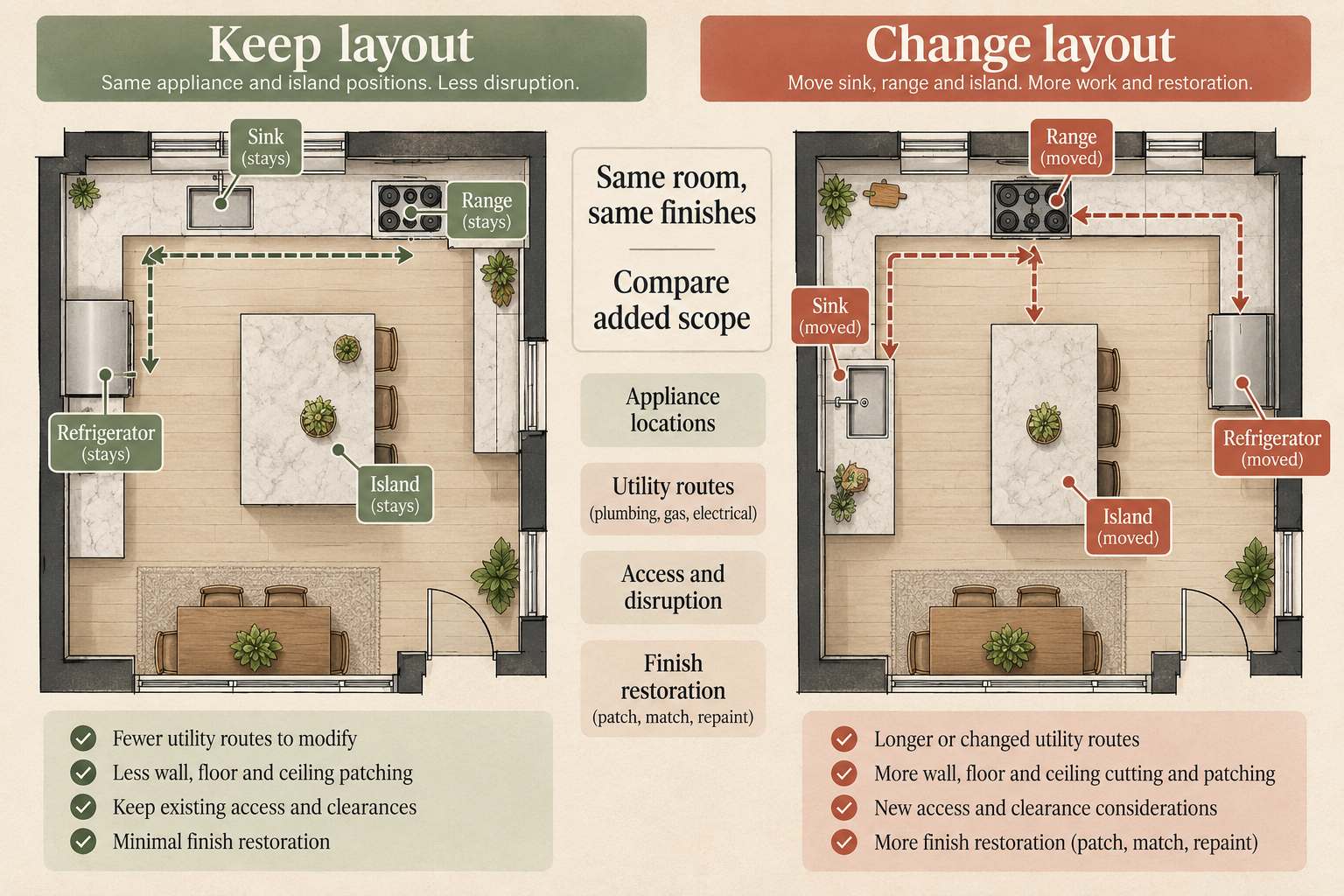

Compare the same room in two versions
Ask for one drawing and estimate with the current zones retained and another with the proposed changes. Hold cabinet quality, appliance assumptions, countertop material, finish level, and project boundary constant. Then ask the designer or contractor to label which added items exist only because of the new arrangement.
| Proposed change | Added planning question | Possible work beyond the new cabinet position |
|---|---|---|
| Improve storage without moving a zone | Can a pantry, pullout, or revised cabinet solve the problem? | New cabinets, fillers, finish match, delivery, and installation |
| Move sink or dishwasher | Is there a feasible water, drain, and vent route? | Cabinet changes, cutout, floor/wall access, and restoration |
| Move cooking zone | What are the power or gas and exhaust paths? | Circuit or gas work, hood/duct changes, clearances, and permits |
| Add or enlarge an island | Does the footprint preserve circulation and door swing? | Counter support, flooring, access, and possibly utilities |
| Change a wall or opening | Is the wall structural or part of a required path? | Professional assessment, approval, adjacent finishes, and restoration |
The exact work depends on the house and local rules. This table is a prompt for scope questions, not a permit determination or a construction instruction.
Test whether the benefit survives a simpler option
Describe the recurring problem before selecting a layout solution. If the issue is a hard-to-reach corner, compare an organizer or cabinet change with moving an entire run. If the issue is a blocked walkway, sketch the appliance doors and people moving through the room before adding an island. If the issue is a poor sink-to-cooking sequence, test the proposed work zones against the household’s actual use, not just the appearance of the plan.
For each alternative, state what gets better and how you would know. Examples include a clear route when the dishwasher is open, a landing area beside an appliance, accessible storage for daily items, or a usable work surface without crossing the main path. If the improvement is not specific, the added construction may be hard to justify. If it is specific, ask the estimator to price the smallest durable change that achieves it and a fuller alternative, with the same finish assumptions.
Check the hidden cost of a “small” move
Moving one cabinet run can affect more than the cabinet bid. A dishwasher change can alter the sink base, counter opening, water connections, and floor access. A refrigerator move can require a different opening, finished side panel, outlet position, or door-swing clearance. A range move can affect the hood route and nearby cabinet construction. These are prompts to expose the whole path; the relevant trades must determine the actual work.
Ask whether the proposed design changes flooring beneath cabinets, creates an unfinished wall where the old run was, or leaves an appliance opening that cannot accept a future replacement. A small plan change may trigger a large restoration if it crosses several finished surfaces. The contractor should identify those interfaces before the estimate is treated as complete.
Avoid comparing a premium layout with a stripped quote
The retained-layout alternative should include the same new finishes and product quality as the changed-layout option. The changed option should identify every added cabinet, surface, utility, access, and approval item. If an item is shown as “by owner” or “allowance,” keep it visible in both totals. This prevents the simpler plan from appearing cheaper only because it carries more exclusions, or the new layout from appearing unaffordable because a required trade scope was counted twice.
U.S. and Canadian verification
Permit, inspection, electrical, gas, plumbing, ventilation, and structural requirements vary by state, province, territory, municipality, adopted code, building, and equipment. The available evidence supports treating these as verification items, not one North American rule. Confirm them before ordering cabinets or cutting finished surfaces.
Bottom line
Keep the layout when it solves the homeowner’s problem and the existing system is suitable for retention. Change it when the functional improvement justifies new cabinet, surface, utility, access, finish, and approval work. Price both arrangements from a shared scope so the value of the change is visible.
