Understand the scope, hidden-condition risk, demolition interfaces, and cross-trade coordination that make a gut kitchen remodel more expensive.

On this page

A gut kitchen remodel removes most existing finishes, cabinets, and fixtures before rebuilding the room. “Gut” has no universal contractual definition, so the budget must describe what is being removed, what is being retained, and which infrastructure is only being exposed for inspection.

What the scope can include

  • Cabinet, countertop, backsplash, flooring, and finish removal.
  • Protection, staging, disposal, and temporary kitchen arrangements.
  • New cabinets, surfaces, hardware, lighting, and coordinated ventilation.
  • Plumbing, electrical, gas, and appliance connections that support the new layout.
  • Wall and floor preparation, patching, leveling, and finish restoration.
  • Design, permits, inspections, engineering, and trade coordination where applicable.
  • Allowances for concealed damage or obsolete work discovered after opening.

The demolition and construction logistics category covers independent logistics economics. A kitchen quote should still show how those costs enter the room project.

Why the total rises quickly

Removal reveals conditions that a surface refresh can leave untouched: water-damaged cabinet areas, uneven floors, out-of-plumb walls, old wiring or plumbing, damaged subfloor, and awkward existing openings. A layout change multiplies the effect because new cabinets and countertops must be designed around new utility paths, finish repairs, and clearances.

The 2026 U.S. Houzz study reported a $55,000 median for its source-defined major projects, compared with $20,000 for minor projects. That distinction is useful context, but “gut remodel” is not identical to Houzz’s definition. Canadian market guides use different project classes and should be read as separate CAD market signals.

Make hidden work controllable

Use a base scope for visible work and explicit allowances or unit prices for concealed conditions. Require photographs, quantities, a written change order, and an approval threshold before extra work proceeds. Keep elective upgrades separate from the contingency so a premium finish is not mistaken for hidden-condition risk.

Useful quote lines include:

  • cabinet and countertop removal;
  • disposal and protection;
  • subfloor, wall, and ceiling preparation;
  • cabinet, counter, backsplash, lighting, and ventilation scope;
  • utility rough-in and finish reconnection;
  • permit, inspection, design, and engineering responsibility;
  • concealed-condition unit prices and exclusions.

Older homes and hazardous materials

Demolition can disturb painted surfaces, floor and ceiling materials, plaster, insulation, or service materials. EPA guidance addresses paid work that disturbs lead paint in many pre-1978 U.S. homes. Health Canada recommends professional asbestos testing before major renovation or demolition and a qualified removal specialist when asbestos is found. These sources support screening and referral, not a DIY demolition method. U.S. and Canadian rules are not interchangeable.

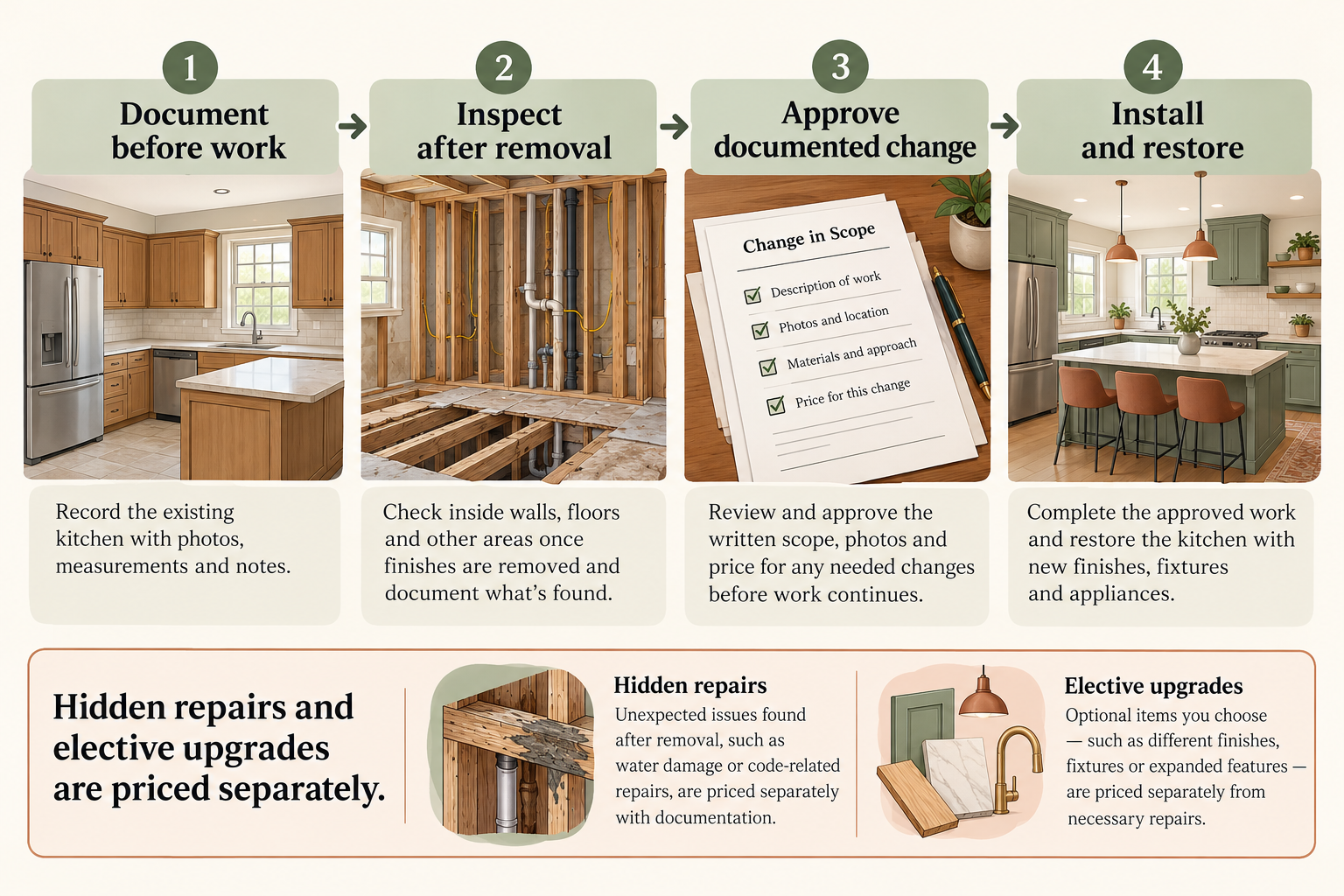

A gut kitchen remodel sequence: document conditions before work, inspect after removal, approve documented changes, then install and restore; hidden repairs and elective upgrades stay separate.

Demolition, reuse, and disposal are separate decisions

Some cabinets may be considered for reuse, resale, or donation before demolition. Treat that as a conditional option, not a built-in project saving. The receiving organization or buyer may limit what it accepts; a complete set, matching pieces, intact finish, or a specific removal method may be required. Arrange inspection and acceptance before the demolition date, and confirm who disconnects services, removes the units, protects the room, transports them, and disposes of anything rejected.

Ask the contractor to show the ordinary removal and disposal price first. Then request a separate credit only if a named reuse arrangement actually changes the contractor’s work or disposal charge. Do not assume that a donation avoids removal labor, creates a tax deduction, or pays for transport. If reuse delays demolition or requires careful removal, the labor and schedule effects may offset a disposal reduction. The current research does not support a general salvage savings amount.

Treat discovery as a controlled decision point

A gut project has a useful sequence for separating known scope from uncertain repairs:

  1. Before work, record visible conditions and identify the agreed room boundary.
  2. After removal exposes the wall, floor, cabinets, and service routes, pause for a documented inspection of the specific finding.
  3. Compare the proposed repair with the contract allowance or unit price and ask whether it affects code, safety, schedule, or adjacent rooms.
  4. Approve the change in writing before the concealed work is covered again.

This does not predict which hidden conditions will occur. It makes their financial treatment visible and helps separate necessary corrections from optional upgrades. Request that the estimate distinguish access and protection from repair itself; opening a wall, correcting what is found, and restoring the finish are different tasks.

Temporary kitchen needs also depend on the planned sequence. Ask when the sink, refrigerator, cooking equipment, and food storage will be unavailable, whether any can remain connected safely, and who protects retained appliances and finishes. If the contractor’s schedule assumes an empty room or a continuous work period, confirm where delivery, inspection, fabrication, and trade delays would leave the household. Temporary arrangements are part of the scope and disruption comparison, even when they are not included in a construction quote.

Price removal, correction, and replacement separately

Demolition and disposal are not one undifferentiated charge. Ask how the estimate treats removal of cabinets, counters, backsplash, flooring, and fixtures; room and adjacent-surface protection; container or haul-away; sorting; and cleanup. If the contractor expects to reuse an appliance or other component, identify who disconnects, protects, stores, and reinstalls it. A salvage plan should state which units are to remain intact and how that affects the removal method.

Then separate correction from replacement. If opening the room exposes a damaged wall or floor, the estimate should describe the affected location and the work required before the new cabinets, counter, or finish can be installed. If additional damage is possible but cannot be inspected yet, use a clearly defined allowance or unit price and an approval process. Do not treat every unexpected condition as a blank cheque, or every correction as an optional upgrade.

Use a kitchen-specific scope boundary

A broad remodel can include independent work in adjacent rooms, but a kitchen estimate should state whether its total stops at the room boundary or includes wall, ceiling, floor, and service restoration outside it. Ask whether the contract includes the design and coordination needed to complete the kitchen, and whether engineering, separate trade permits, testing, or hazardous-material investigation are excluded. Refer separate whole-home or structural work to the appropriate project scope rather than hiding it inside a kitchen allowance.

When the project crosses categories

The kitchen remains the dominant project when the work is a room renovation with coordinated trade interfaces. A structural wall removal, addition, relocation of the kitchen to another room, or whole-home reconfiguration may instead make major remodeling the primary scope. Independent plumbing, electrical, ventilation, appliance, permit, logistics, and hazard work keeps its own cost and professional boundary.

Bottom line

Budget a gut remodel as a sequence of removal, exposure, correction, installation, and finish stages. The most reliable quote states the room boundary, layout, retained components, trade responsibilities, hidden-condition controls, and exclusions. A broad range without those assumptions is not a complete gut-remodel budget.
