Kitchen Remodel in Phases: Cost and Sequencing Tradeoffs

Learn which kitchen remodel work can be phased, which pieces are tightly coupled, and how temporary conditions and repeat mobilization affect cost.

On this page

Phasing a kitchen remodel can protect cash flow and let you live in the home, but it can also create repeat mobilization, temporary conditions, storage problems, compatibility risk, and rework. The right question is not simply whether work can be split; it is whether the split preserves a durable next step.

Work that is often easier to separate

Condition assessment, design, measurements, cabinet selection, and some infrastructure planning can happen before visible renovation. A cabinet organizer retrofit, a limited finish refresh, or a pantry addition may also be a coherent small project when the surrounding cabinet and countertop conditions are sound.

Work is harder to separate when the first phase would be removed or damaged by the second. Cabinets and countertops, countertops and backsplash, sink cutouts and plumbing reconnection, and an island and its utilities are common coupled groups.

Coupled work to plan together

  • Countertops depend on final cabinet dimensions, levelness, overhangs, cutouts, seams, and supports.
  • A sink change can couple cabinet, counter, plumbing, faucet, disposal, and backsplash work.
  • Backsplash installation may depend on the final countertop and cabinet elevations.
  • Under-cabinet lighting is easier to coordinate before cabinets and wall finishes are closed.
  • An island with a sink, cooktop, or other service needs a route, access plan, and cabinet/counter design before installation.

Caesarstone’s quartz fabrication guidance describes templating around appliances, overhangs, edges, slab quantity, seams, supports, fabrication, and installation. Those details illustrate why a countertop should not be ordered before the supporting scope is settled. Requirements differ by material and fabricator.

The cost of splitting the work

Each phase may repeat travel, setup, protection, delivery, cleanup, minimum charges, and project management. A temporary sink or countertop may require purchase, installation, removal, and disposal. Early work can also damage retained finishes or make later matching harder.

No reliable general percentage premium or saving applies to every phased kitchen. Ask the contractor to price the full project and the proposed phase boundary separately, showing duplicated work and temporary conditions.

A safer phase architecture

  1. Confirm the layout, measurements, retained components, and required approvals.
  2. Resolve concealed-condition, utility, hazard, and access questions before ordering finish materials.
  3. Complete infrastructure that would otherwise require reopening finished work.
  4. Install the cabinet and countertop system as one coordinated sequence where possible.
  5. Complete backsplash, lighting trim, paint, and other finishes after the surfaces they depend on are fixed.

This is a planning pattern, not a universal construction sequence. Cabinet manufacturer, fabricator, trade, and local requirements control the actual order.

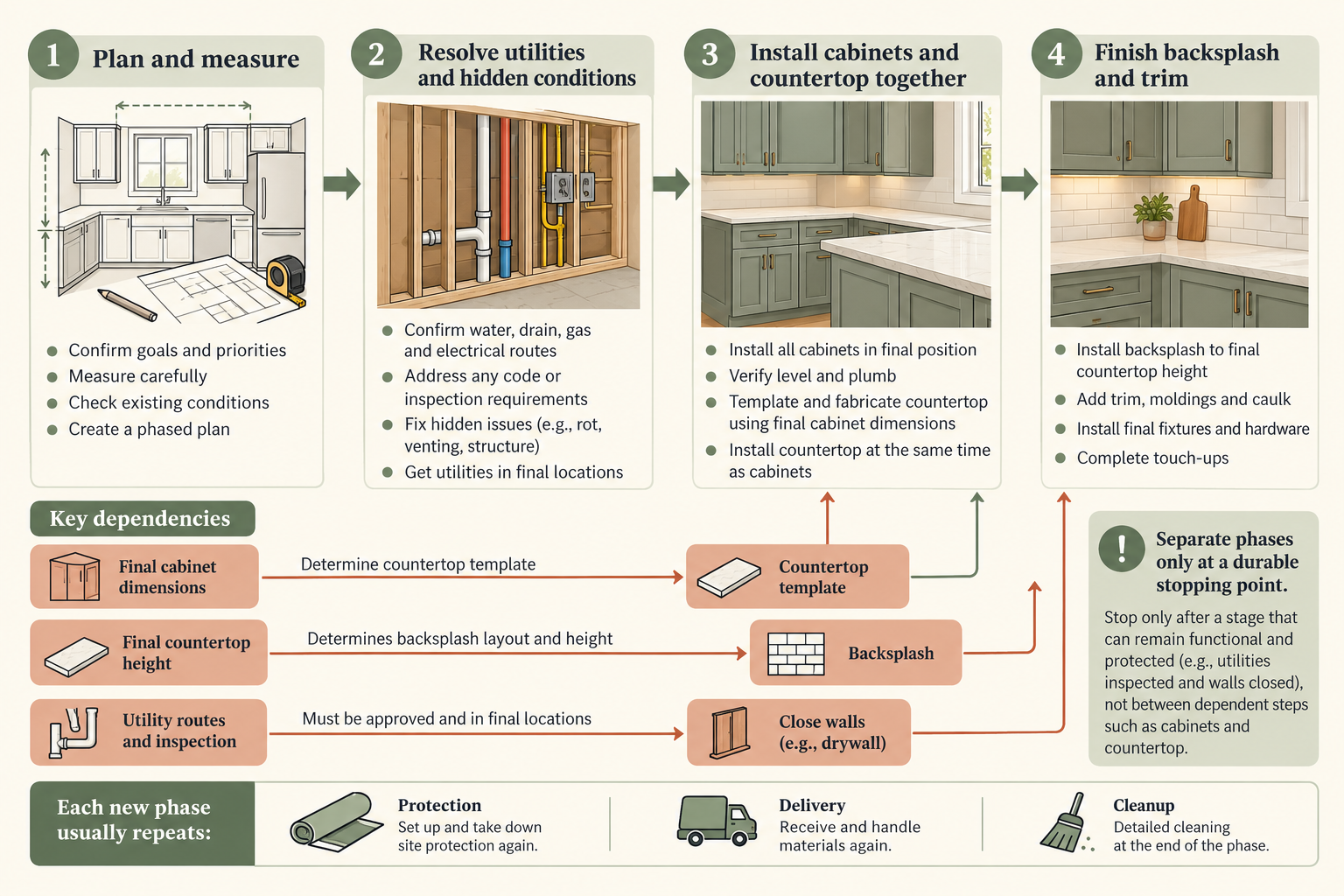

Kitchen remodel phases depend on settled measurements, utility routes, cabinet dimensions, countertop templating, and final backsplash height; separate work only at a durable stopping point.

Compare phase plans by the work each one repeats

One coordinated installation phase can be appropriate when cabinets, counters, sink, and backsplash depend on the same final dimensions. It concentrates disruption and requires more cash at once, but makes it easier to settle the interfaces in a single sequence.

Infrastructure first, finishes later can work when a known circuit, plumbing route, or ventilation path must be addressed before cabinets close the access. The first phase should leave capped, tested, documented connections and a clear final plan. Ask which temporary finish or protection is required and whether later work must reopen the same surface.

A finish-only phase followed by replacement is riskier when the first finish will be removed by the later project. Cabinet painting may have value if the cabinets will remain for a meaningful period and the structure is sound; it is less compelling if replacement is already planned. A temporary countertop can also add purchase, fit, sink, and disposal tasks that a combined counter installation avoids.

The right sequence depends on product lead times, installer and fabricator requirements, site access, and local inspections. Treat any generic sequence as a planning model. Confirm the actual order with the cabinet supplier, countertop fabricator, and qualified trades before committing to dates.

Use hold points before spending on finishes

Agree on a few decisions that must be complete before the next phase starts: final cabinet dimensions before templating; utility routes and required inspections before closing walls or floors; sink and cooktop models before cutouts; and countertop elevation before backsplash layout. Record the product identifiers, measurements, finish names, exclusions, and who has approved the next step.

When comparing bids, request a full-project estimate and a phased estimate. Ask the contractor to mark work that occurs twice, such as protection, delivery, disconnect/reconnect, temporary sink installation, surface repair, or cleanup. A separate mobilization fee is a known repeat cost; an uncertain future repair is not. Keep both visible instead of assuming that phasing either saves money or always costs more.

Three phase boundaries that can work

Planning and procurement before demolition. Measurements, appliance selection, cabinet schedule, countertop material, and permit questions can be resolved before the kitchen is removed. This reduces the chance of ordering a cabinet or counter from an incomplete plan, though a site verification may still be needed after demolition.

A localized storage or finish project now, larger renovation later. This can make sense when it solves an immediate problem and the selected work will remain useful after the future remodel. Avoid a new organizer, counter, or finish that is likely to be discarded to reach the next planned phase.

Open the room once, complete infrastructure, defer selected finishes. This may preserve cash for later finish choices while completing electrical, plumbing, or ventilation work before access closes. It only works if temporary protection, safe connections, inspections, and a durable stopping point are identified with the responsible professionals.

These patterns do not predict cost savings. A phase that repeats protection, travel, delivery, cleanup, or countertop/sink work may cost more in total; a phase that avoids financing a larger project or keeps sound components in use may have practical value. Request the total cost of all proposed phases, not just the first contract.

Protect later choices

Record cabinet dimensions, finish names, countertop material, appliance clearances, outlet locations, and retained conditions. Keep spare finish material where practical. Do not assume a future product will match a discontinued cabinet, slab, hardware line, or color.

Generic financing, contractor payment schedules, and project administration belong in the broader project-economics categories. This article focuses on kitchen-specific coupling and rework.

Bottom line

Phase work when each phase has a stable result and the boundary avoids repeat access or removal. Complete tightly coupled cabinet, countertop, sink, backsplash, and utility decisions together when splitting them would shift risk into temporary work or future change orders.
