Roof Ventilation Work During Reroofing: Cost and Scope
Replacing existing roof vents during a reroof may add only hundreds of dollars. Cutting a new ridge vent, adding intake paths, rebuilding blocked soffit connections, or redesigning a complex attic can add hundreds to several thousand and may involve envelope work outside the roofer’s base scope.
The key question is what problem the ventilation change is intended to solve.
Why ventilation appears in a roof quote
Reroofing exposes ridge, deck, and penetration details, making it efficient to renew vents or change roof-side exhaust. A contractor may find damaged box vents, mixed systems, blocked intake, poorly terminated exhaust ducts, or evidence of attic moisture.
That does not mean “more vents” is always correct. Ventilation works with intake, exhaust, air sealing, insulation, vapor behavior, roof geometry, and climate. Some assemblies are intentionally unvented.
Roof-side components

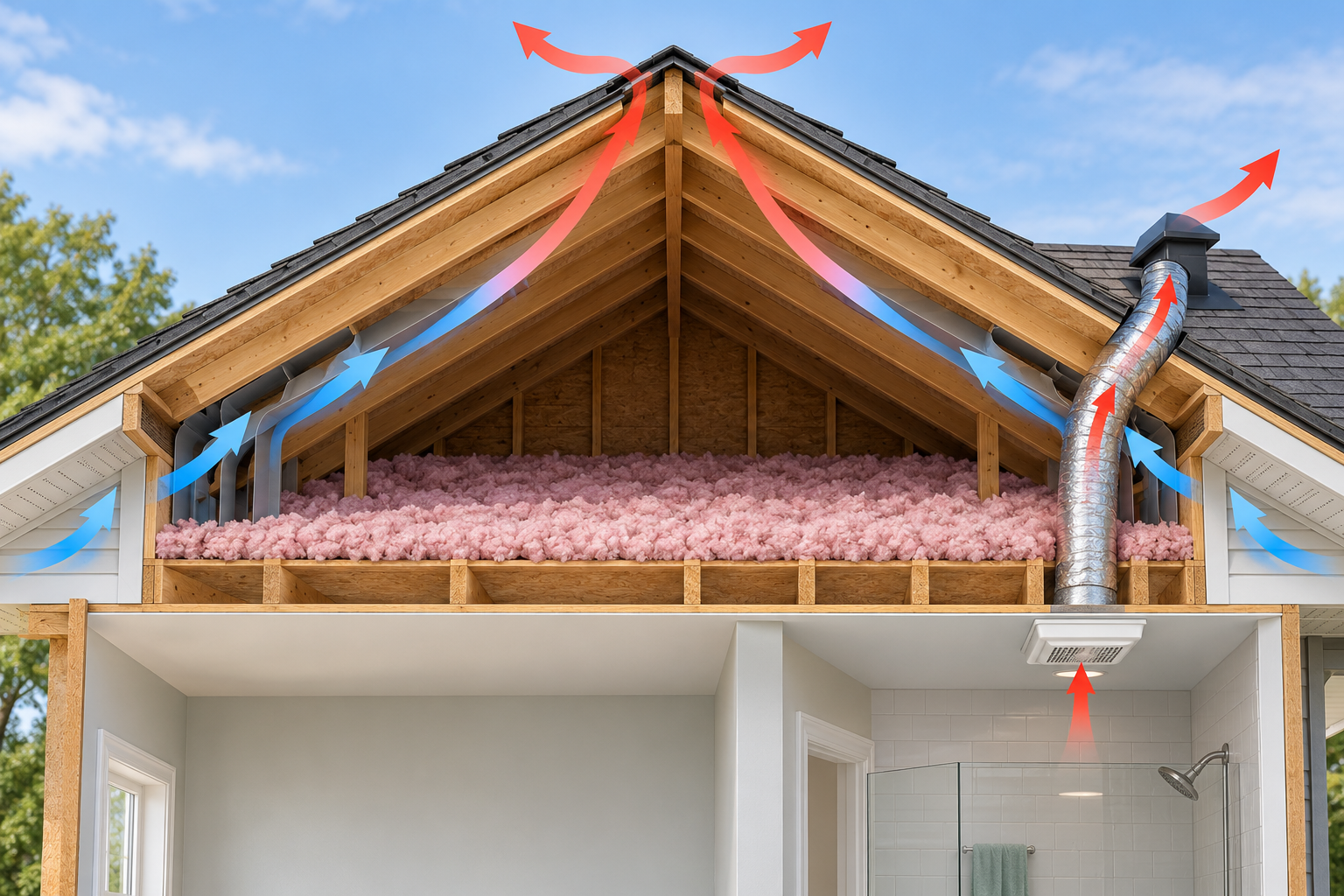

Common components include ridge vents, box or static vents, gable vents, soffit-connected intake paths, and powered ventilators. The roofing scope can include deck openings, vent products, flashing, insect/weather protection, and closure of obsolete openings.
Soffit reconstruction, attic baffles, duct correction, electrical work, and whole-attic air sealing may require other trades.
Incremental cost drivers
- linear ridge length or number of roof vents;
- cutting and reinforcing openings;
- removal and closure of incompatible old vents;
- access to blocked or absent intake;
- complex separated attic zones;
- electrical work for powered equipment;
- interior attic access and contaminated or hazardous conditions;
- engineering or enclosure consultation for unusual assemblies.
Changing vents while covering is off is usually cheaper than opening a finished roof later, but only if the design is appropriate.
Moisture and ice-dam boundary
Natural Resources Canada emphasizes attic air sealing because warm moist indoor air can leak through plumbing, wiring, lights, chimneys, and other penetrations. Ventilation alone may not overcome large air leaks. Increased insulation without effective air sealing can also change condensation conditions.
Ice dams likewise can result from heat loss, air leakage, thermal bridges, complex geometry, and weather. Adding ridge vent or powered exhaust without diagnosing the heat path may fail to correct recurrence.
Powered vent caution
A powered attic ventilator is not a universal upgrade. It can alter pressure relationships and may draw conditioned air through ceiling leaks when intake is inadequate. Product, fuel-burning equipment, climate, and assembly conditions matter. Require a clear design basis rather than accepting “more airflow” as sufficient evidence.
Scenarios
Like-for-like vent renewal: Old static vents and flashing are replaced as part of reroof. This is a modest, efficient incremental scope.
Ridge conversion with adequate intake: Contractor closes old openings, cuts ridge, installs compatible system, and confirms connected intake path. Price reflects roof work plus verification.
Condensation in a complex attic: Frost, wet sheathing, blocked zones, and ceiling air leakage are present. The roof quote alone cannot resolve the enclosure; coordinate diagnosis before cutting more openings.
Intentional unvented assembly: Generic vent additions may undermine design. Obtain assembly-specific professional guidance.
Quote checklist
Ask what condition supports the change, how intake and exhaust paths connect, which attic zones are served, which openings are closed, what product is installed, and which interior or electrical tasks are excluded. Exact ventilation ratios and requirements must be verified for the local assembly and jurisdiction.
Ventilation work is worth adding during reroofing when it implements a coherent roof-and-attic strategy. It is poor value when vent count substitutes for diagnosis.
Diagnose before pricing a redesign
Useful observations can include attic configuration, blocked intake, existing vent types, frost or staining, bathroom/kitchen exhaust termination, insulation coverage, ceiling air leaks, and whether roof zones communicate. A roofer can document roof-side conditions; a building-envelope professional may be needed for complex moisture or unvented assemblies.
The cost of this assessment may avoid cutting openings that later must be closed.
Alternatives to adding vents
Correcting a disconnected exhaust duct, clearing existing intake, air sealing ceiling penetrations, insulating consistently, or repairing a roof leak may address the actual problem. These are not interchangeable and may involve different trades.
If the existing vent system is coherent and no defect is established, like-for-like replacement can be better than redesign during a sales visit.
Quote comparison
Request a vent map, net opening or product data where applicable, intake/exhaust relationship, deck cuts, closures, baffles or soffit boundary, electrical work, and warranty. Verify code claims locally and avoid universal ratios detached from assembly context.
Cost and scheduling scenarios
A modest reroof add-on may replace damaged box vents. A ridge conversion requires continuous cutting and compatible ridge covering. New intake can become an exterior/attic project. Separate attic zones can multiply products and diagnostic time. Powered equipment adds electrical and future maintenance.
Post-work verification
Keep photos of openings and product records. If moisture or ice symptoms motivated the project, define how performance will be observed afterward. Continuing symptoms do not automatically prove the vents were installed incorrectly; they may reveal the unresolved air, insulation, or moisture source that should have been part of the original decision.
Normalize a ventilation allowance
Map every attic or roof zone, existing intake and exhaust location, obstructions, disconnected ducts, and areas that are not part of the vented attic. Then compare removal, new openings, exact vent products, baffles or intake work, closures of abandoned openings, ridge or field-roof reconstruction, electrical work, screens, weather detailing, and interior access.
A line that says “add ridge vent” is incomplete if intake remains restricted or separate attic sections do not connect. A powered-vent quote is incomplete if it omits electrical supply, controls, replacement access, and the reason passive measures do not resolve the stated objective. Require the calculation or manufacturer/local basis appropriate to the assembly without relying on a universal rule here.
Three cost paths
In a low-complexity reroof add-on, damaged existing vents are replaced like for like and their openings are integrated while covering is already removed. Incremental mobilization is limited.
In a typical redesign, ridge or other exhaust is added, older openings are closed, intake is verified or improved, and attic obstructions are addressed. Roofing, soffit/carpentry, and attic labor may be separate even though the system must be coordinated.
In a complex case, multiple attic zones, cathedral ceilings, inaccessible eaves, bath exhaust defects, air leakage, uneven insulation, or moisture sources make “more vents” an unreliable solution. Diagnosis and envelope or mechanical work may dominate the project.
Decide whether reroofing is the right moment
Reroofing lowers the incremental cost of roof-side cuts, closures, and compatible ridge work because the covering is open. It does not automatically make an unneeded redesign valuable. If no performance issue or requirement is established and the existing system is coherent, like-for-like work may be rational.
When ice, condensation, mold-like staining, high cooling load, or comfort drives the request, separate the hypotheses. Air sealing, insulation, duct repair, moisture control, shading, or HVAC work may address different mechanisms. Price the roof-side ventilation option only after the intended airflow path and expected observation are defined.
For ownership economics, include electrical energy and equipment replacement for powered devices, safe inspection access, pest/screen maintenance, and future reroof disturbance. Passive components also require clear unobstructed paths and weather detailing. No option is maintenance-free merely because it has no motor.
Decision threshold and verification
Approve a change when it corrects a documented deficiency, satisfies an applicable requirement, or supports a coherent assembly plan. Defer a sales-driven redesign when the provider cannot map intake/exhaust, distinguish attic zones, or explain why the proposed component addresses the symptom.
After work, retain photographs of deck cuts, baffles, closures, and ducts before concealment. Establish what will be checked through the next relevant seasons. A measured follow-up turns a ventilation expense into a testable building decision rather than a collection of roof accessories.
Cost boundaries to keep visible
Roof vents and cuts belong to the roofing scope; soffit/intake carpentry may not. Baffles, air sealing, insulation, exhaust-duct correction, mold/moisture evaluation, and electrical work can involve different providers. Coordinate sequence but preserve separate prices and outcomes. This lets the homeowner see whether a modest reroof add-on has become a larger envelope project—and whether that larger scope is supported by diagnosis.
Final decision checklist
Confirm the problem being solved, attic-zone map, existing and proposed airflow path, intake/exhaust relationship, required roof and non-roof work, current product/local basis, and post-work observation. Approve the integrated scope that resolves a documented deficiency; do not buy the largest vent count as a substitute for that analysis.
Ownership and future intervention
For a long holding period, value inspectable paths, replaceable components, duct and baffle records, and a design that survives ordinary roof repair. For a short horizon, correct verified defects without assuming a redesign adds equivalent resale value. Powered equipment should have a service and replacement path; passive openings should remain clear and weather-tight. Both belong in maintenance records.
Ownership decision in one sentence
Renew or redesign roof ventilation when the mapped assembly, applicable requirements, and diagnosed airflow or moisture condition support it; coordinate non-roof source work separately. A reroof creates an efficient opening, but efficiency is not evidence that every attic needs additional vents.
