Restoration, Remediation & Insurance-Driven Recovery

Project cost and decision guide

Plan for lodging, food, storage, commuting, and other displacement costs while a damaged home is unsafe or unavailable.

On this page

Additional Living Expenses During Home Restoration

When a loss makes a home unsafe or unavailable, the recovery budget includes more than construction. Temporary lodging, incremental food, storage, laundry, commuting, pet arrangements, and other day-to-day differences can continue while mitigation and reconstruction proceed.

Separate household planning from claim accounting

The household must pay or arrange for a place to live whether a coverage decision is finished or not. The insurer may later classify only some of those costs as additional living expense. Build the practical budget first, then compare it with the policy’s definition, limits, conditions, and documentation rules.

This distinction is especially important when a household chooses a more expensive location, needs accessibility features, has pets, or must remain near work or school. Explain the need and keep the receipts, but do not assume the policy will accept every difference.

U.S. insurance guidance generally describes additional living expense (ALE) as the increase above normal living costs when a covered loss displaces the household, subject to policy limits and time conditions. Mortgage payments and ordinary costs do not automatically become additional living expenses. The actual policy controls.

Canadian coverage can use different wording and may treat flood, earthquake, evacuation, and other events differently. Do not assume that a U.S. ALE explanation is a Canadian coverage rule.

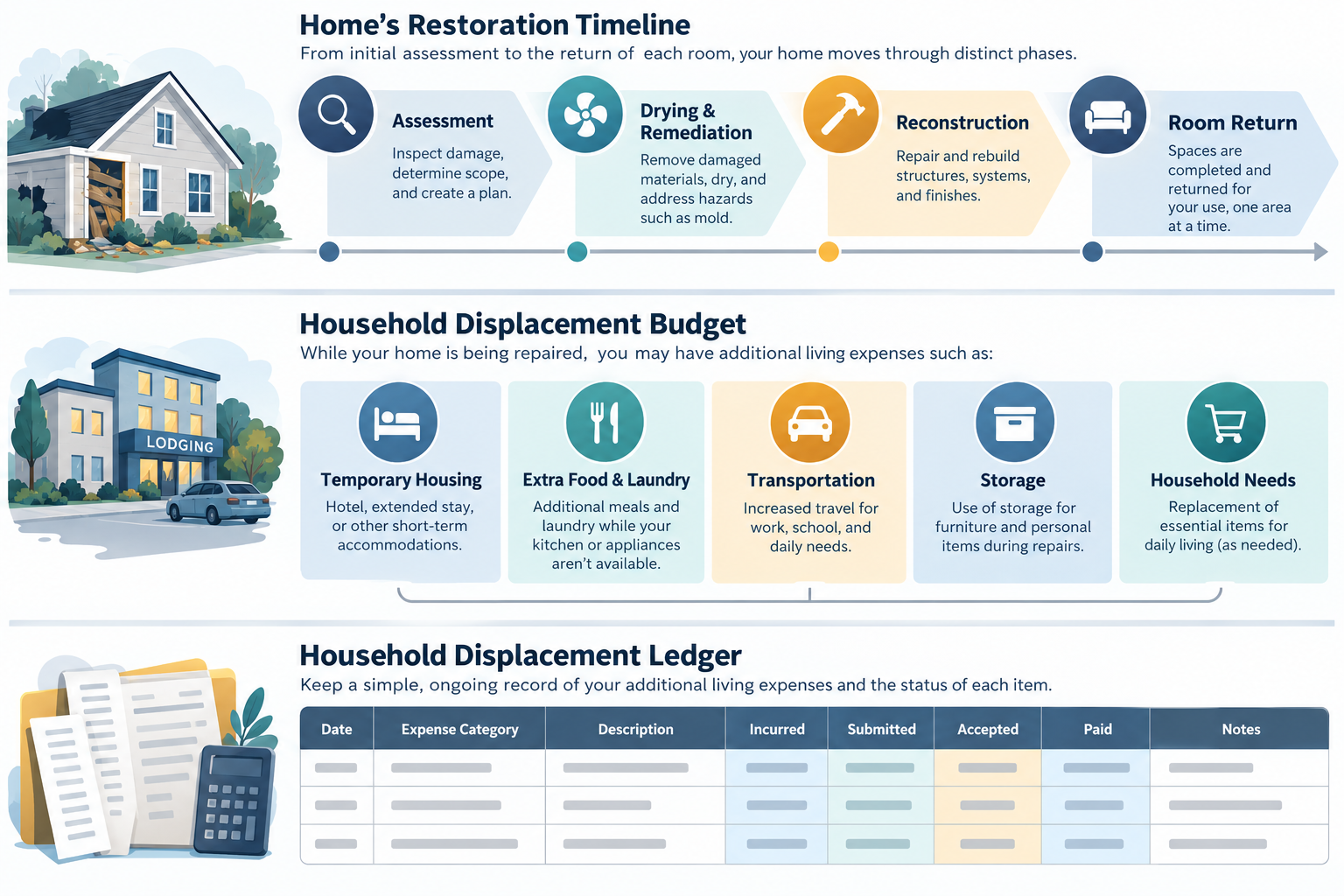

Build a displacement budget

List the normal cost and the temporary cost separately for:

  • lodging or a short-term rental;
  • food and kitchen access;
  • storage, pack-out, and pack-back;
  • laundry and transportation;
  • pet, accessibility, or work-related needs;
  • deposits, utilities, and schedule-related extensions.

The difference is the planning signal. It is not a prediction of what the insurer will reimburse.

Duration is a cost driver

Temporary living costs may continue while the property is assessed, dried, remediated, permitted, rebuilt, inspected, or waiting for materials. Hidden damage, supplements, code requirements, contractor scheduling, and contents storage can extend the timeline. Ask the contractor for a schedule range and what conditions could extend it, then ask the insurer about time and dollar limits.

Keep receipts and a running record. Ask before committing to an unusual or long-term expense, but do not assume a lack of preapproval means an urgent safe lodging decision must wait.

What to ask the insurer

Ask which events and household members are covered, what normal-cost baseline is used, whether storage and moving are treated separately, what receipts are required, what limits and deadlines apply, and what happens when the rebuild takes longer than expected.

Keep ALE separate from the physical restoration estimate. A contractor may help establish the repair timeline, but the policy determines the coverage question.

What belongs in the household budget

Start with the household’s normal monthly pattern, then list the incremental costs created by the loss. A short-term rental may replace a mortgage-free home but add rent, utilities, deposits, parking, or internet. Cooking without a kitchen can increase meal costs. Living farther from work or school can change fuel, transit, or childcare needs. Laundry, pet care, accessibility needs, and storage may be material for some households and irrelevant for others.

The comparison is for planning, not a claim formula. Keep ordinary expenses visible so an insurer’s “additional” calculation can be compared with the household’s actual cash flow. Do not assume that a policy pays the full cost of a more expensive choice made for convenience or preference.

The timeline is a cost model

Displacement may begin with emergency stabilization and continue through assessment, drying, remediation, permitting, contents treatment, reconstruction, inspections, and final handoff. A schedule can extend because hidden damage is found, materials are unavailable, a code decision is unresolved, a contractor is waiting for an approval, or the home cannot be safely occupied while a system is assessed.

Ask the contractor for a best-case and risk-based schedule, including the assumptions behind each. Ask what work can proceed in parallel and what must wait. Each additional week can affect lodging, storage, transportation, meals, work arrangements, and the timing of pack-back, so record changes as the project develops.

Build a displacement budget before choosing a temporary arrangement

Start with the household’s actual needs: number of occupants, bedrooms, cooking, laundry, work or school access, pets, accessibility, medical equipment, commuting, storage, and the distance that keeps daily life workable. Then compare the incremental cost of living away from home with the costs that would have existed there anyway.

For example, a temporary rental may replace a mortgage or normal rent rather than add it, while increased utilities, laundry, meals, transportation, storage, pet care, and accessibility needs may be additional. A hotel may include some services but cost more per night and make cooking or storage difficult. The cheapest nightly rate is not necessarily the lowest household cost over a long project.

Common cost categories

Potential categories include temporary lodging, increased food expense, laundry, transportation, storage, pet-related costs, accessibility accommodations, utilities, parking, and additional distance to work or school. Whether any category is eligible or reimbursable depends on the policy and claim circumstances. Keep ordinary spending and additional spending visible rather than assuming every expense belongs in the same bucket.

Pack-out and storage can interact with displacement. Contents may need to leave the building before reconstruction, while the household may still need access to clothing, documents, medication, work equipment, and essential furniture. Ask the contents provider how to retrieve items and the insurer how storage and temporary living are treated.

Duration and delays

The schedule can expand when demolition reveals hidden damage, drying or remediation takes longer, materials are delayed, permits or inspections are pending, a code decision is unresolved, or a system cannot be safely used. Ask for the assumptions behind the completion date and the events that would change it.

Track actual dates: when the home became unavailable, when each room is returned, when contents can come back, and when the household can reasonably resume normal use. A contractor’s target date is useful for planning but does not by itself establish policy eligibility or a guaranteed payment period.

Coverage and documentation questions

NAIC guidance describes additional living expenses as increased temporary living costs subject to policy terms, limits, and conditions. Canadian guidance likewise emphasizes policy-specific coverage and limits. Do not assume that the same category, duration, or limit applies in every U.S. or Canadian policy.

Ask the insurer:

  • What coverage or endorsement applies?
  • What expenses are considered additional?
  • Are there dollar, time, household, or property limits?
  • What receipts, comparisons, or approvals are required?
  • How are delays, storage, pets, accessibility, and meals treated?

Keep receipts, invoices, mileage or transportation records, lodging agreements, storage records, and communications. Documentation supports the conversation but does not guarantee reimbursement.

When costs exceed the expected allowance

If the restoration is delayed, ask the contractor for the cause, revised schedule, and work that can proceed in parallel. Ask the insurer how to handle a projected limit, changed accommodation, or continuing expense. If the household chooses a more expensive arrangement for convenience, space, or preference, keep that choice separate from the baseline additional-cost calculation.

The practical goal is a rolling budget that connects the physical schedule to household cash flow. It should show what the home project costs, what living elsewhere adds, what the policy may address, and what remains the homeowner’s choice.

Build the displacement timeline

Start with the dates that are known: the loss, emergency stabilization, inspection, demolition, drying or cleaning, reconstruction start, expected substantial completion, and the earliest realistic return. Then mark the dependencies. A delayed permit, unavailable material, failed inspection, unresolved moisture, or contents still in storage can extend the period even when the main estimate has not changed.

Separate a necessary extension from a household preference. If the property is physically ready but the household chooses a larger renovation, that may not have the same coverage treatment as a delay caused by covered restoration work. Ask the insurer or claims representative how extensions are requested and what documentation is needed before the original limit is reached.

The practical record can be simple: daily lodging, meals above the normal home baseline, laundry, transportation, pet or dependent-care effects when relevant, receipts, approvals, and the reason for each unusual cost. Tie larger charges to the project timeline. That record helps the household manage cash flow while giving the claim reviewer a way to distinguish ordinary living costs from loss-related displacement.

Review the budget whenever a room or essential utility returns to service.
