Manufactured Home Site Preparation and Setup Cost: What Happens Before Move-In

Plan the full site-side budget for a manufactured home, including access, grading, support, anchoring, utilities, close-up work, permits, and inspections.

On this page

The price of a manufactured home is only one part of a new installation. The site must be accessible and prepared, the home supported and anchored, sections joined, services connected, and the finished work inspected under the applicable program or local rules. Site conditions can make the setup far more expensive than a simple delivery-and-blocking quote suggests.

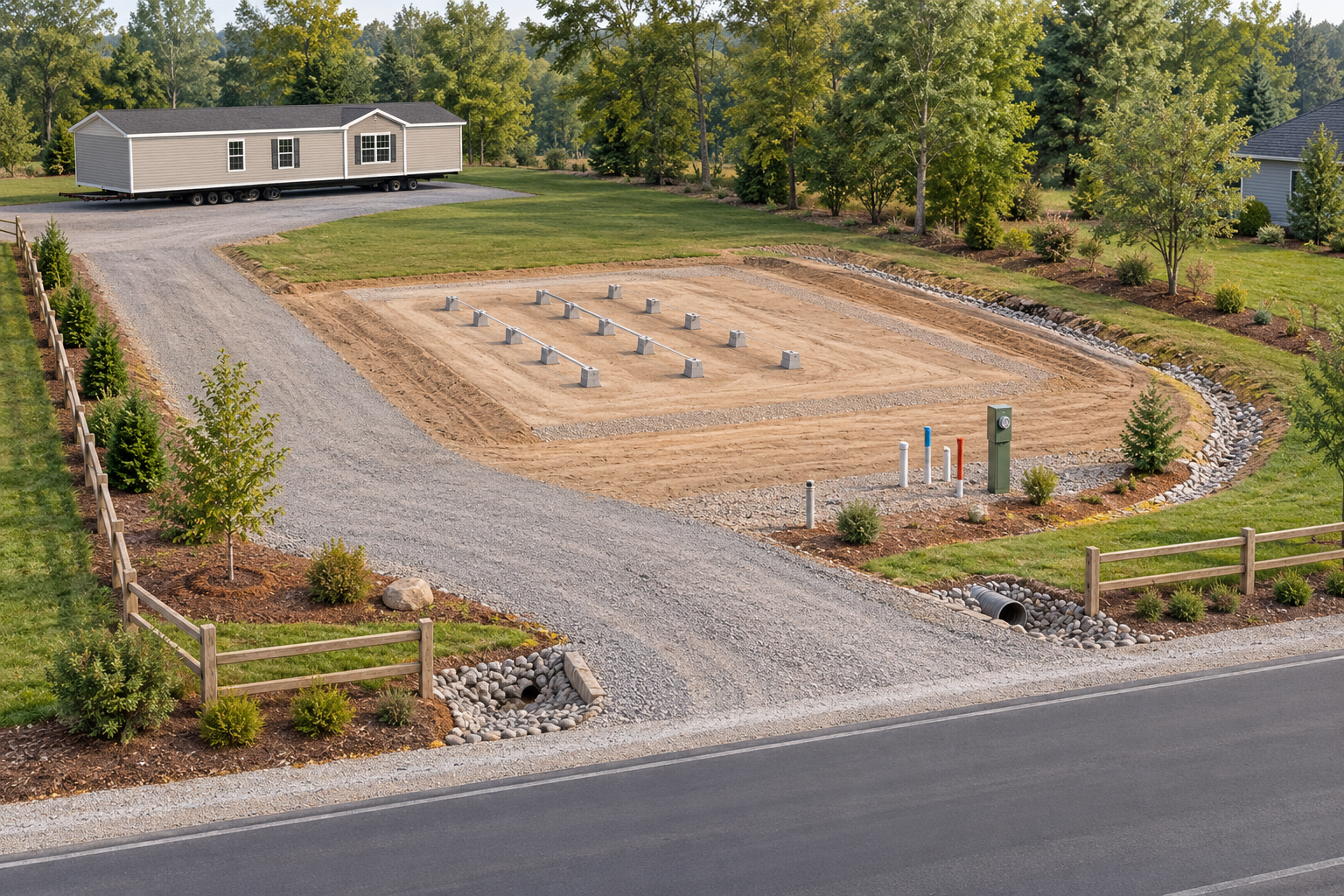

Illustration of a prepared home site with access, grading, support locations, utility points, and drainage.

What setup may include

Ask the installer to separate these scopes:

  1. clearing, excavation, grading, drainage, and access for delivery equipment;
  2. soil evaluation, footings, piers, foundation, or another support system;
  3. delivery, setting, blocking or leveling, and anchoring;
  4. marriage-line or multi-section close-up where applicable;
  5. water, sewer or septic, electrical, gas, and other field connections;
  6. skirting or another perimeter enclosure, stairs, landings, and exterior finish work;
  7. permits, tests, inspections, and correction of failed work.

The federal model installation standard organizes U.S. installation around site preparation, drainage and ground moisture, foundations and piers, anchoring, utilities, close-up, and multi-section interconnection. It applies to its defined U.S. installation scope and does not establish Canadian requirements.

The site usually controls the budget

A level, serviced lot with generous access is a different job from a wooded, sloped, wet, remote, or constrained site. Cost can rise when the delivery route needs clearing, the soil cannot support the planned system, drainage must be corrected, utilities are far away, rock or groundwater changes excavation, or a crane or specialized equipment is needed. Weather delays and temporary access can also affect the quote.

Have the installer identify what the price assumes about soil bearing, frost, grading, utility distance, section count, home size, access, and weather. Ask whether the quote includes testing, traffic control, restoration, disposal, and temporary protection.

Utilities and inspection are separate work

The factory may provide internal systems or connection points, but the site still needs service work, trenches, meters, valves, disconnects, tests, and authority approvals. HUD’s installation FAQ describes retesting the complete water-supply and drainage systems after field piping is connected in its U.S. context. B.C. guidance likewise places site preparation, service connections, and appliance installation within the site/code boundary for the scope it addresses.

Do not use those statements as a national code checklist. Confirm the authority having jurisdiction, utility-owner requirements, installer qualifications, and current permits for the actual property.

Make quotes comparable

Request a base scope plus alternates for difficult access, upgraded foundation, drainage, utility extensions, skirting, stairs, and restoration. Confirm whether home transport, crane/set work, sales tax, engineering, soil testing, permits, inspections, and post-inspection corrections are included. Keep U.S. and Canadian quotes in their own currency and market; no conversion produces a reliable setup price.

There is no durable national range established for this category. A useful setup budget has a site-specific scope, visible exclusions, a contingency for concealed conditions, and a written answer to who pays when the lot or home differs from the assumptions.

Use a layered planning scenario

For a simple U.S. illustration, assume a prepared lot, short utility runs, ordinary support work, and no rock or drainage correction: $8,000 for site work, $12,000 for foundation and support, $7,000 for utility connections, and $5,000 for permits, stairs, skirting, and close-up. That produces a $32,000 site-side scenario before transport and the home itself. A separate Canadian illustration might use CAD 10,000 + CAD 15,000 + CAD 9,000 + CAD 6,000 = CAD 40,000 under similarly simple assumptions. These figures are models, not quotations or national averages.

Change one assumption at a time. A long utility trench, unsuitable soil, engineered foundation, difficult delivery route, or post-inspection correction can move the result more than a small material choice. Ask each bidder to identify which layer owns that risk and whether the allowance is fixed, measured, or subject to change order.

Divide responsibility before the site work begins

A new-home contract can include a unit, delivery, some blocking or leveling, and a limited utility connection while excluding the work that makes the site ready. Ask the retailer, transporter, installer, civil contractor, utility, engineer, and local authority to identify their boundaries. Put each item under one owner: clearing, survey, soil information, grading, drainage, foundation or supports, anchors, crane or setting, utility route, field connection, inspection, skirting, stairs, and restoration. Where two contractors touch the same interface, name who schedules and verifies the handoff.

The site visit should check route and staging as well as the home pad. A truck or crane may need turning radius, overhead clearance, temporary access, a firm setup area, and a place to store equipment. A site that is clear at the pad can still require tree work, road protection, traffic control, or a longer crane reach. Ask the delivery team to confirm measurements and assumptions in writing, and clarify what weather or soil conditions would stop work or trigger equipment standby charges.

Soil, slope, drainage, groundwater, frost, rock, and local hazard conditions can change the design before any permanent work starts. Do not treat a generic foundation detail or a neighboring home’s setup as proof that it fits this parcel. Ask whether the price includes testing, design, excavation, backfill, drainage outlet, inspection, and rework if the conditions differ from what was visible. A site contractor can price earthwork, but the support system may require a separate professional design or authority acceptance.

Compare site-readiness milestones

Break the project into a sequence with a completion document or sign-off at each handoff. One milestone can be “access and pad ready”; another “foundation/support and anchors accepted”; then “home delivered and set”; then “utilities connected and tested”; then “close-up, stairs, enclosure, and final inspection complete.” The exact sequence depends on the jurisdiction and home type. The point is to know when the next trade can safely begin and who pays if a preceding scope is incomplete.

A setup bid should state when measurement is taken, what level or bearing assumptions are used, how utilities are protected during delivery, who reconnects multi-section systems, and whether final testing is included. Require separate lines for permanent work and provisional allowances. If a connection requires a utility owner or separate permit, do not assume it is included because the sales contract says “hookups.” Ask for the connection point, distance, owner, capacity, meter, trench, test, inspection, and restoration.

Think through simple, constrained, and remote sites

An uncomplicated case might have a serviced lot, clear access, soil information, a prepared foundation, and known utility points. A constrained case can add slope, wet ground, a narrow approach, an existing driveway, trees, or longer runs. A remote or undeveloped parcel may require service extension, private well or septic, substantial access work, engineered drainage, and multiple authority approvals. These are scope cases, not market-price bands; local quotes are needed to assign dollars.

The least expensive land purchase can have the highest setup total. Compare parcels with a site checklist before committing: route feasibility, utility availability and distance, permitted occupancy, required foundations, drainage outlet, access for future repair, and any impact fee or utility-owned extension. Ask each relevant party for written confirmation and expected timing. If an answer is pending, leave the cost and schedule as an open risk rather than treating it as zero.

Make the first quote useful

Provide bidders with the same site plan, home dimensions and sections, utility locations, available soil reports, delivery method, and requested occupancy date. Ask them to identify exclusions, taxes or utility charges, allowances, tests, and the process for approving extra work. A low bid may be complete for a prepared pad but not for raw land; compare the scope with your actual parcel. Keep Canadian provincial and municipal requirements distinct from U.S. installation standards, and do not use one country’s setup quote to budget in the other.

Before signing, total the home contract, land work, delivery and setting, foundation, utilities, permits, inspection, finish work, temporary services, and contingency. Keep a separate line for interest, insurance, or lot charges during delays. This is the cash needed to reach a usable, approved home at the site, not a national estimate. If the retailer cannot say who owns an essential interface, ask for that decision before the work is scheduled.

Check occupancy and readiness, not only physical setup

A delivered and connected home may still need final inspection, a certificate or utility release, stairs or access, address or mailbox work, and restoration before the owner can use it as intended. Ask the authority and insurer which conditions must be met before occupancy. Add temporary power, water, portable facilities, storage, or lodging to the project cash flow if the schedule could stretch. Financing draws may also depend on milestones, so confirm with the lender what evidence it needs before each release.

Keep a readiness list with responsible party and sign-off date. This prevents “installed” from being mistaken for “ready to live in” and gives the owner a clear basis for the final payment.

Tie payments to completed milestones

A payment schedule should follow visible progress: approved plan, site ready, foundation accepted, home delivered and set, connections tested, and final closeout. Ask what proof is supplied at each stage and what happens if an inspection fails or a trade does not arrive. Avoid paying the full amount for future site work at delivery if the retailer or contractor has not completed it. The contract should identify how deposits are protected, how change orders are approved, and whether a dispute or delay affects the next draw.

This does not replace lender advice. For a financed installation, ask the lender which completed work qualifies for each advance and what invoices or inspection documents must be submitted. Aligning the contractor schedule with the funding schedule can prevent a cash gap during setup.
