Bathrooms & Wet Areas

Project cost and decision guide

Estimate a shower remodel by separating surface work, prefab or tile construction, pan and waterproofing, doors, fixtures, plumbing, access, and concealed moisture damage.

On this page

Shower Remodel Cost

“Shower remodel” can mean replacing a control and door, installing a new prefab unit, retiling a sound assembly, or demolishing the area to rebuild the pan and waterproofing. Those scopes do not belong in one undifferentiated price. Define the work before using a cost guide or comparing quotes.

Bounded planning example

For a U.S. shower in an existing footprint, a limited surface case might use $8,000, a component remodel $14,000, and a full rebuild $18,000 as worked planning assumptions. A separate Canadian comparison could use C$10,000, C$18,000, and C$24,000. Each example assumes different inclusions; none is a market average, quote, or currency conversion. A failed substrate or waterproofing assembly belongs in the full-rebuild case only after diagnosis.

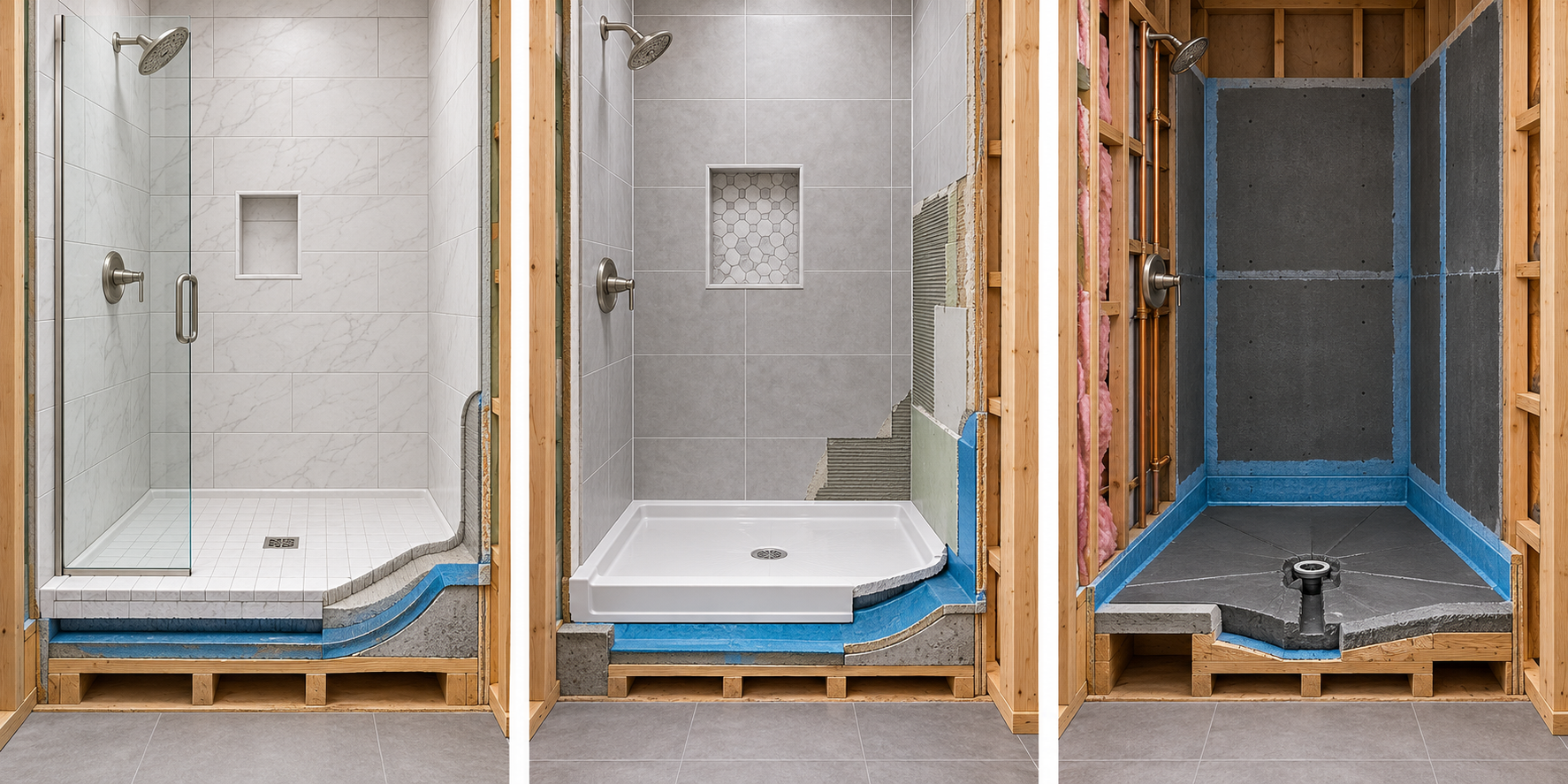

Three shower-remodel cases

Case Scope Main uncertainty
Surface update Fixtures, door, sealant, or selected finish work while the assembly remains credible Whether retained tile, substrate, pan, and waterproofing are actually sound
Component remodel New pan, surround, tile, door, or fixture package with targeted demolition Interfaces and the condition behind removed finishes
Full shower rebuild Demolition to suitable substrate, new waterproofing assembly, drain, finishes, and enclosure Access, concealed damage, layout, and restoration

Market sources distinguish shower remodeling and installation, but their definitions and local samples differ. US and Canadian observations should be treated in their own market context and not mechanically converted.

What drives the quote

Ask for separate lines for protection, demolition, disposal, pan or base, drain work, substrate, waterproofing, tile or panels, niches and benches, fixtures, door or enclosure, plumbing, electrical, ventilation, access, and restoration. Custom dimensions, difficult material handling, and work over a finished room can change labor substantially.

The product price is only one layer. A prefab base may reduce custom finish work but still require careful substrate, drain, wall, and enclosure coordination. A tiled shower allows more design flexibility but brings more detailing and an assembly-specific waterproofing decision.

Do not infer waterproofing from the finish

A manufacturer installation handbook describes membranes, seams, corners, penetrations, drains, and transitions as connected parts of a shower system. New tile or grout does not prove that those layers are sound. If the quote retains the waterproofing, ask why that is appropriate and what condition would trigger additional removal.

Hidden moisture and plumbing

A leak at the floor, wall, door, or ceiling below does not identify its source. Plumbing connections, drains, pan edges, seals, waterproofing, and wet framing may all create different scopes. Independent pipe or valve work belongs to the plumbing category when it is the dominant job. Localized wet-area reconstruction remains part of the shower decision when rebuilding the room is the main purpose.

Compare the whole decision

Request a base scope, a likely concealed-work allowance, and options for prefab, tile, door, fixture, and layout choices. Include the temporary loss of the shower and any alternate bathing arrangement. If a repair leaves a known failed assembly in place, compare its residual risk with the cost of a rebuild.

The useful output is not a single shower average. It is a quote that states whether the project is a surface update, component remodel, or complete assembly rebuild.
