Project cost and decision guide

Budget a shower-pan replacement by separating diagnosis, demolition, drain connection, surrounding finishes, waterproofing, subfloor condition, access, and full-rebuild risk.

On this page

Shower Pan Replacement Cost

A shower pan or base replacement can be narrower than a full bathroom remodel, but the pan cannot be priced as an isolated object. Removal may disturb tile, walls, drain connections, waterproofing, subfloor, and the shower door. The first question is whether the pan is actually the failed layer.

Bounded planning example

If diagnosis confirms a pan-only scope in a U.S. bathroom, a worked planning case might use $7,000 for protection, removal, pan, drain connection, limited wall repair, and finish restoration. If the same opening requires a waterproofing and substrate rebuild, use a separate $18,000 case. A Canadian comparison could use C$9,000 and C$24,000. These are rounded assumptions, not market averages or currency conversions, and do not identify which layer has failed.

Diagnose before selecting a pan

Water at the ceiling below, a damp edge, staining, cracking, or a soft floor can have more than one source. Plumbing connections, drain fittings, enclosure seals, wall waterproofing, and the pan are separate possibilities. A visible leak location does not establish the source. Avoid a quote that promises a pan replacement without describing the diagnostic basis.

What the scope may include

Work package Why it matters
Protection and demolition Access, dust, disposal, tile or surround removal, and what is retained
Pan or base Prefabricated or site-built dimensions, material, threshold, and fit
Drain Connection, access from below, height, and interface with the waterproofing system
Surround Wall and floor finish removal, replacement, trim, and enclosure coordination
Substrate Subfloor, framing, backer, leveling, and concealed damage
Waterproofing How pan, walls, corners, penetrations, and transitions connect

Why the surrounding area may open

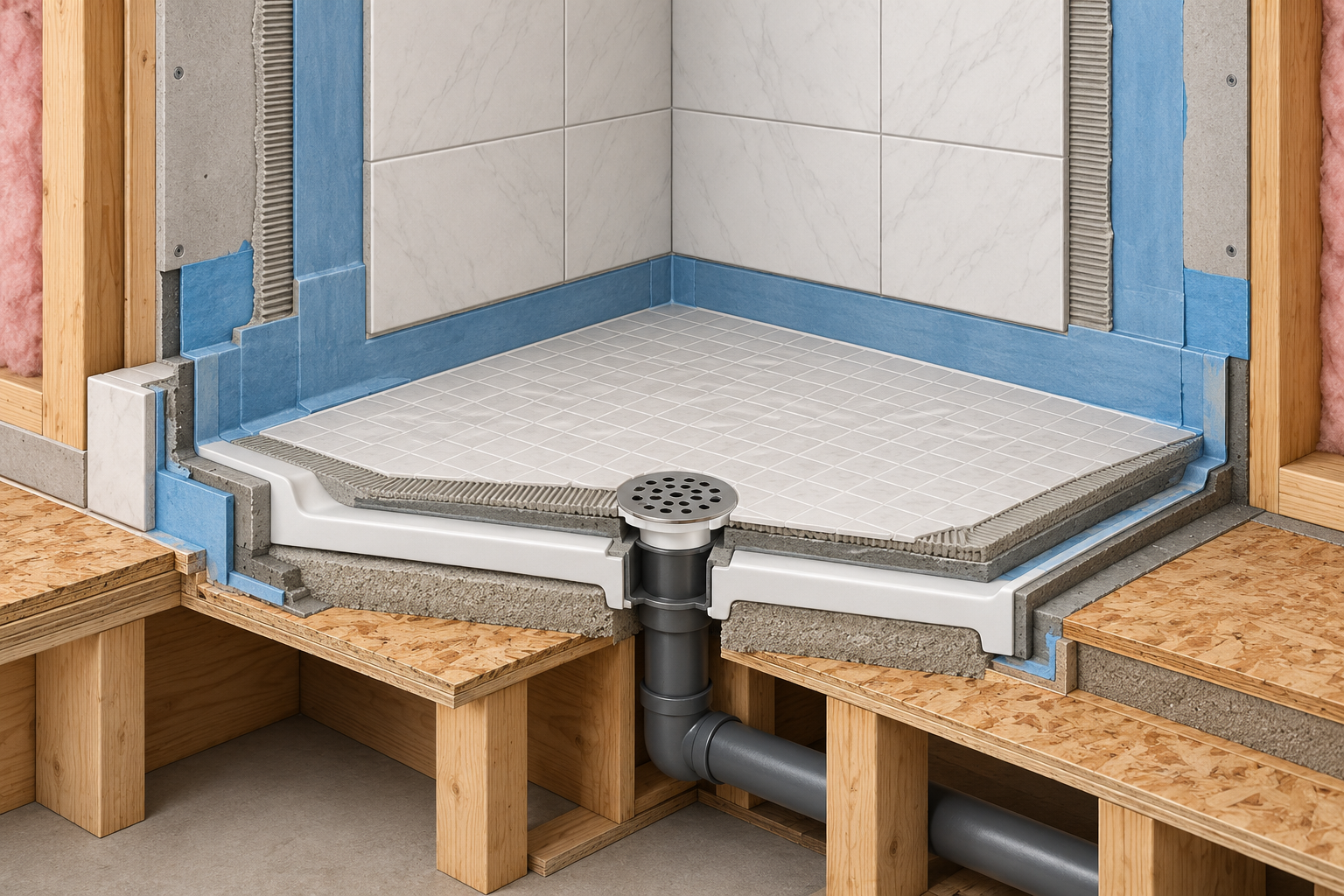

The pan usually meets the walls, drain, and waterproofing. A manufacturer system treats those details as an assembly, not a tray placed beneath tile. The existing finish may need removal to make the new connection credible. Ask what minimum removal the proposed system requires and what happens if the substrate is damaged.

Compare repair paths

Price a bounded seal or drain repair only when the source is established and the assembly remains sound. Price pan replacement when the pan is the defined failure and surrounding interfaces can be rebuilt. Price a full shower rebuild when waterproofing, substrate, multiple walls, or concealed damage are involved.

Use a base scope plus an allowance for defined additional removal. The allowance should have quantities, unit prices, photographs, and an approval rule. If the contractor cannot state what is being corrected, the right first purchase may be a diagnostic assessment rather than a new pan.

The strongest pan budget explains source, assembly, access, retained finishes, and the condition that would move the project into a complete rebuild.
