Understand the cost layers of a gut bathroom renovation, including deep demolition, substrate, waterproofing, rough-ins, access, discoveries, and contingency.

On this page

Gut Bathroom Renovation Cost: When a Complete Rebuild Is Necessary

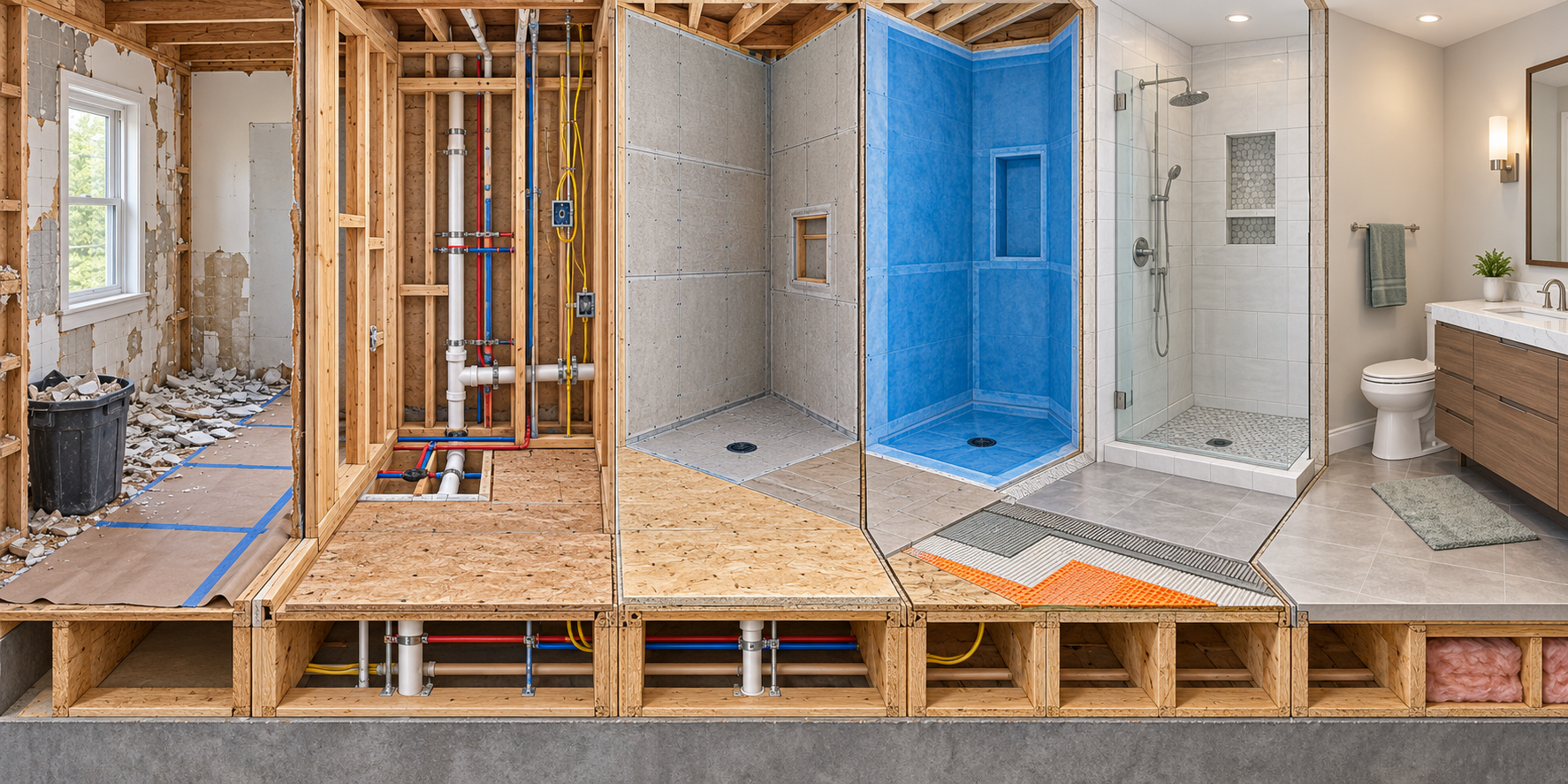

A gut renovation removes finishes and assemblies deeply enough to expose framing, subfloor, rough plumbing, wiring, or ventilation paths. It is a different economic class from replacing a vanity and repainting the room. There is no universal demolition line that defines “gut,” so the proposal should describe the actual depth of opening and rebuilding.

Bounded planning example

For a hypothetical existing bathroom opened to framing and subfloor but kept in its current footprint, use a U.S. planning case of $28,000: protection and demolition ($6,000), rough infrastructure and repairs ($6,000), waterproofing and wet-area rebuild ($8,000), finishes and fixtures ($6,000), and closeout ($2,000). A separate Canadian case could use C$36,000 for the same defined scope. These are rounded worked assumptions, not surveyed prices or a USD-to-CAD conversion; hazardous-material, structural, or multi-room work is outside the example.

Why bathrooms get gutted

Homeowners may choose a deep rebuild because the room has repeated moisture damage, obsolete or poorly arranged infrastructure, several failing systems, or a layout that cannot be corrected selectively. A known waterproofing failure can also make removal behind the visible tile more economical than repeated surface repairs.

The reason matters. Opening a room for a layout change creates a different budget from removing it because wet framing or subfloor must be replaced. Ask the contractor to state the problem being corrected and the outcome that will show the correction is complete.

Cost structure

Layer What to identify in the proposal
Protection and access Occupied-home protection, path to the work area, temporary facilities, and staging
Deep demolition Removal depth, disposal, dust control, and what is intentionally retained
Investigation Openings, condition checks, measurements, and any design or trade coordination
Rough work Plumbing, electrical, ventilation, framing, blocking, and insulation where the project requires them
Wet-area rebuild Substrate, membrane or system, seams, corners, penetrations, drain, and finish restoration
Closeout Fixtures, flooring, paint, cleanup, inspections where applicable, and documentation

Do not compare a gut-renovation quote with a finish-only quote. The cheaper proposal may assume sound framing, a usable subfloor, an unchanged layout, or retained waterproofing.

What demolition can reveal

Opening walls or floors can expose damaged sheathing, wet framing, poor prior repairs, unsealed penetrations, incompatible transitions, or a drain and supply arrangement that does not match the new fixture. A shower waterproofing system is an assembly rather than a visible tile finish; manufacturer documentation for one system treats membranes, seams, corners, drains, and penetrations as connected work.

Use a contingency process instead of a vague promise that discoveries are “included.” Set an assumed quantity, a unit price where practical, a photo requirement, and an approval threshold. If the condition affects safety, structural support, hazardous materials, or a fuel-burning appliance, stop ordinary remodeling decisions and obtain the appropriate qualified assessment.

Sequencing and scope control

Confirm the final layout before rough work. Then identify which openings are needed, how the wet-area assembly will tie into the floor and walls, when water testing or other checks occur, and who owns restoration outside the room. A short project schedule can still involve multiple trade dependencies; price access and temporary loss of the bathroom explicitly.

Boundaries

Localized bathroom reconstruction belongs here when the dominant decision is rebuilding the existing wet area. Standalone demolition and disposal, environmental-hazard remediation, disaster restoration, structural engineering, and a new-bathroom addition have separate economic owners. A gut remodel can coordinate those services without silently absorbing their complete scope.

The right gut-renovation budget is a defined opening depth, a complete rebuild sequence, and a controlled discovery allowance. “Everything new” is not enough information to compare bids.
