Bathroom Layout Change Cost: The Price of Moving Fixtures and Reworking the Room
Changing a bathroom layout is a coordinated construction decision. Moving a vanity a short distance may affect only alignment and finish repair; moving a toilet or shower can open floors, alter drains, change venting, and require restoration outside the fixture footprint. There is no reliable flat premium for “moving plumbing.”
Bounded planning example
Suppose a U.S. bathroom remodel that retains its layout is budgeted at $20,000, while the proposed layout change adds $10,000 for floor access, drain and vent changes, finish restoration, and added coordination, producing a $30,000 planning case. A separate Canadian case might use C$26,000 and C$38,000. These are rounded, scope-bound arithmetic examples—not universal relocation premiums or currency conversions. Verify the proposed route and local requirements before treating the difference as a quote expectation.
Use the existing layout as the baseline

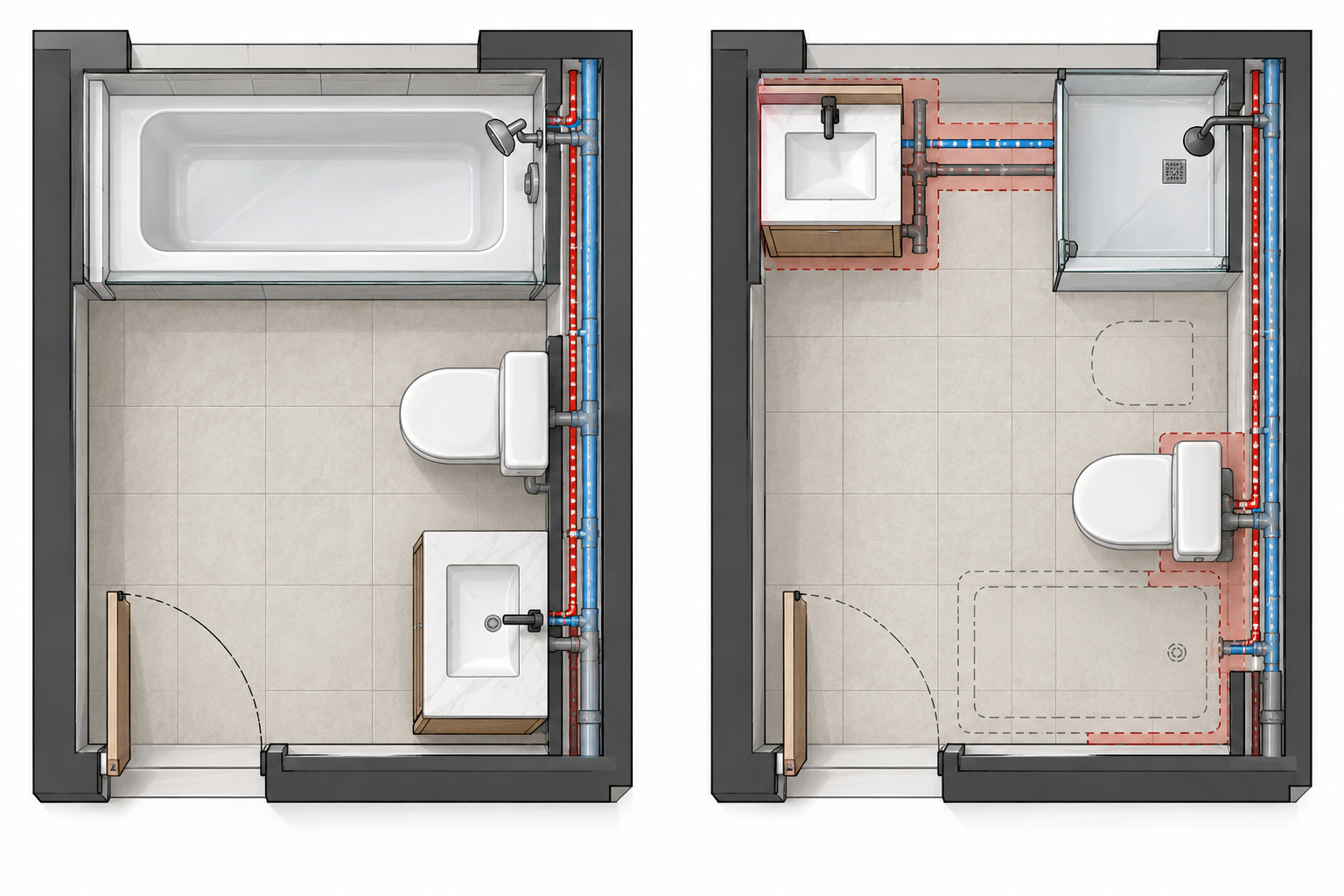

Price two scopes: a layout-retaining design and the proposed reconfiguration. The baseline shows the cost of the remodel itself. The difference shows what the new arrangement requires. This makes it easier to decide whether better circulation, accessibility, storage, or appearance justifies the additional work.
What changes the scope
| Proposed move | Questions that change the budget |
|---|---|
| Vanity or sink | Will supply, drain, backsplash, wall finish, floor, and cabinet width still align? |
| Toilet | Can the drain, vent, floor opening, finished height, and access be resolved in the existing structure? |
| Tub or shower | Can the new footprint connect to drainage, waterproofing, enclosure, and wall finishes without a larger rebuild? |
| Door or partition | Is framing moving, and will lighting, ventilation, privacy, or accessible circulation change? |
| Multiple fixtures | Are several rough-ins being coordinated while the floor and walls are open? |
The exact feasibility and requirements depend on the existing building and local rules. Treat a contractor’s early concept as a scope hypothesis until the relevant trades and, where necessary, design professionals verify it.
Where costs accumulate
Fixture movement can create demolition, access openings, rough plumbing, electrical relocation, framing, floor or subfloor repair, waterproofing transitions, new trim, patching, and cleanup. A slab and a framed floor create different access choices. A fixture over a finished room may require ceiling restoration below. A move near an exterior wall can also affect insulation or ventilation paths.
The proposal should identify every affected surface, not only the new fixture location. Ask whether flooring is being removed to the room boundary, whether the wet-area system is rebuilt, and whether the old connection is capped or removed under the applicable trade scope.
Accessibility-driven layout changes
More turning space, a wider approach, a curbless shower, a seat, or better control placement can make layout change worthwhile. NAHB guidance identifies these as common bathroom planning features, but it is not a universal private-home code or a guarantee that one arrangement meets an individual’s needs. Price the user’s actual transfer, reach, caregiving, and mobility requirements.
Compare the decision, not just the move
Ask each bidder for a layout-retaining base, a proposed layout, and the assumptions behind both. Separate fixed work from allowances for floor opening, substrate damage, access below, permits or inspections where applicable, and restoration. If the reconfiguration creates a new bathroom or expands substantially beyond the existing room, the major-remodel or addition boundary may apply.
The most credible layout budget explains why each fixture moves, what structure and utilities it touches, and which uncertainty could change the total. A drawing and a flat relocation fee are not substitutes for that scope.
