Accessible Bathroom Remodel Cost: Scope, Layout, and Price Drivers
An accessible bathroom can be a small adaptation or a full room reconstruction. The budget changes when the project adds clear route space, changes the shower or tub, moves plumbing, reinforces walls, replaces flooring, improves lighting, or restores finishes after demolition. A fixture-only price rarely represents the complete accessibility decision.
What makes this remodel different?
The project begins with how the bathroom is used: entering, turning, transferring, bathing, toileting, washing, dressing, and receiving assistance. A person using a walker, a wheelchair, or a caregiver may need a different arrangement. Reach, strength, balance, vision, and fatigue can change controls, support, lighting, and storage priorities.
The room also depends on the route leading to it. A wider bathroom doorway does not help if the hall has a pinch point or a step. A new shower does not solve a slippery approach or a door that cannot be operated. Map the route before selecting a fixture.
Bathroom cost levels
Limited adaptation may include lighting, hardware, selected supports, a floor transition, a handheld shower, or a carefully chosen bathing accessory. The scope is smaller when the existing layout and surfaces are sound.
Moderate remodeling may replace a tub or shower, improve the doorway, change flooring, add support preparation, and restore finishes. Plumbing may or may not move, but waterproofing and the floor condition still matter.
Major reconstruction can relocate fixtures, create a curbless or roll-in shower, change the room footprint, rebuild the floor, move supply or waste lines, add electrical work, and coordinate structural or professional review. This can become a multi-trade project even in a small bathroom.
Specialist-market evidence supports broad, directional U.S. cost framing for accessible bathrooms but not a universal national price. Canadian costs must be based on local Canadian quotes. Show whether a number includes demolition, finishes, fixtures, trades, design, permits, and inspection.
Layout and circulation

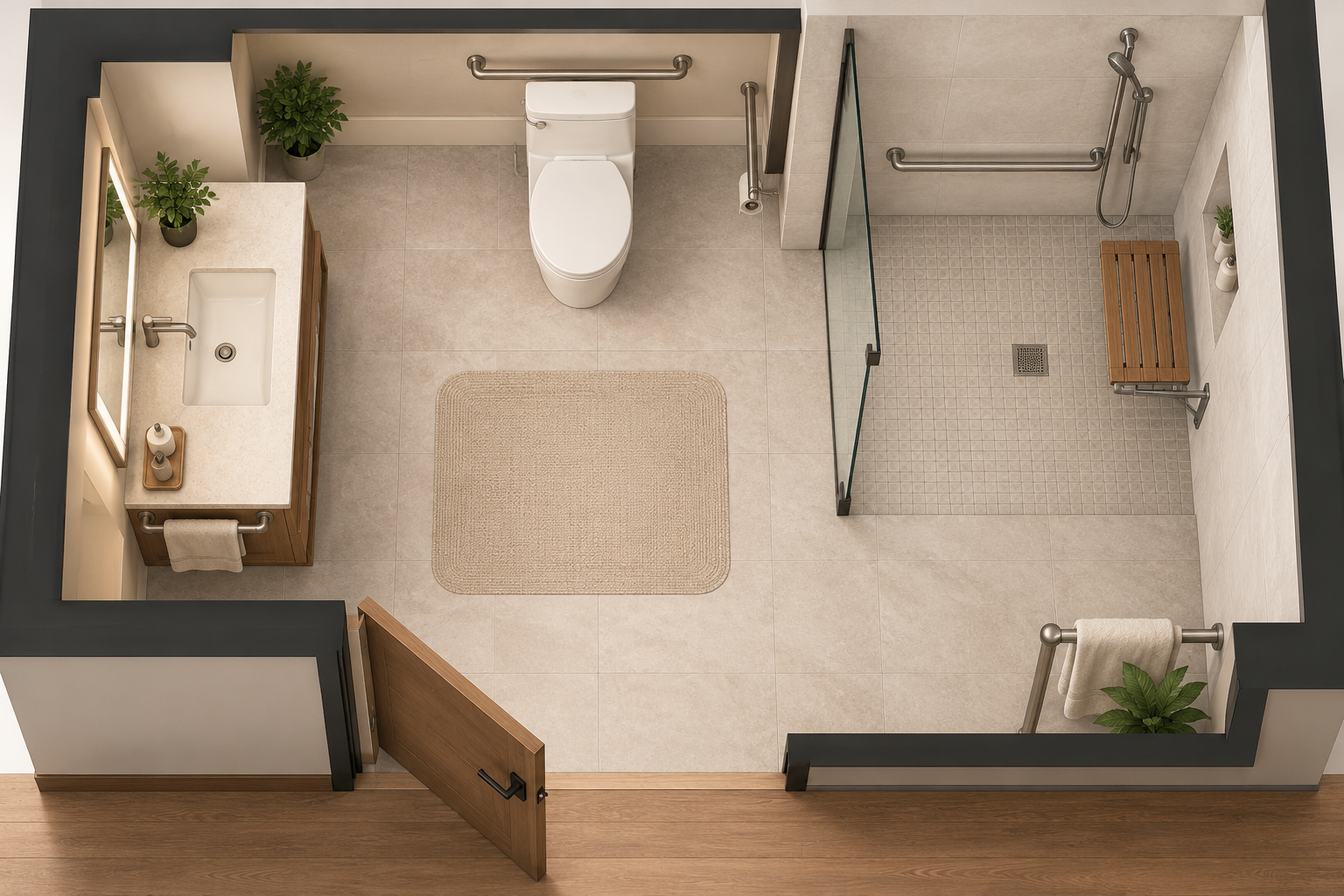

The route through the room should match the actual device, transfer, and caregiver needs. Consider the door swing, clear opening, turning area, toilet approach, sink position, shower entry, storage, and the ability to close or open the door without blocking the route. A door change may affect the wall, trim, floor, and privacy.
Published accessibility dimensions can be useful references in the right setting. They are not automatically a private-home code. The Access Board explains that the ADA Standards apply to covered facilities and specified residential settings; an ordinary individually owned home not used as a public accommodation is generally outside that federal coverage. Local building and plumbing requirements still need confirmation.
Bathing options
A standard shower conversion may be less disruptive than a curbless shower if the floor and drain already work. A curbless or roll-in shower can require floor recessing, a different drain, waterproofing, slope, splash management, and more room. A walk-in tub uses a different transfer and bathing routine and may require fill, drain, plumbing, electrical, and maintenance considerations.
No option is universally safer or suitable. The user’s transfer, balance, strength, bathing preference, caregiver access, and time in the room should guide the choice. Use the detailed tub-to-shower, curbless shower, and walk-in tub comparison guides for those decisions.
Support, flooring, and lighting
Support planning may require blocking behind finished walls, appropriate products, and installation matched to the substrate and manufacturer requirements. A towel bar is not a support bar merely because it looks similar. Where blocking is absent, opening tile or wall finishes can increase labor and restoration.
Flooring should be considered with water, cleaning, transitions, visual contrast, and the user’s stability. Lighting may include ambient, task, mirror, and night lighting with controls that are easy to reach and use. Electrical work belongs to qualified professionals.
Plumbing and electrical changes
Relocating a toilet, sink, drain, water supply, shower valve, or ventilation can change the project from a surface remodel to a coordinated plumbing and wall or floor job. A heated seat, pump, lift, or other equipment may create electrical requirements. Do not assume a product can be added to an existing circuit or waterproofing assembly without professional review.
Quote checklist
Ask for separate scope and allowances for:
- assessment, design, and measurements;
- demolition, disposal, and temporary bathroom access;
- doorway, wall, and structural work;
- floor preparation, slope, drain, waterproofing, and testing;
- plumbing, electrical, ventilation, and fixtures;
- supports, controls, storage, lighting, and flooring;
- tile, drywall, trim, paint, and finish restoration;
- permits, inspections, cleanup, warranty, and exclusions.
Ask what happens if framing, joists, slab, plumbing, or moisture damage differs from assumptions. A low bid that excludes waterproofing or finish restoration is not comparable with a complete remodel.
When to hire more than a remodeler
An accessibility-informed designer or functional assessor can help define the room before demolition. Engineering may be appropriate when structure or floor framing changes. Qualified plumbers, electricians, waterproofing installers, and equipment providers should handle their parts of the work. Safety-sensitive installation should not be improvised.
The right bathroom budget is the cost of a usable daily routine: route, entry, transfer, bathing, support, surfaces, utilities, and restoration. Start from that routine, then compare the smallest intervention that solves the real barrier with the full remodel that preserves better future options.
Price the room around the wet zone
Begin with the approach from the hall and the sequence of entering, undressing, transferring, bathing, drying, toileting, and leaving. A shower may be the visible priority, but the user may also need a clear route to the toilet, a place for a caregiver, stable support while turning, reachable controls, and a dry landing for clothing or a device. A larger shower does not solve a door swing or a crowded path.
Ask the design or remodeling team to show the proposed layout with fixtures, clear floor areas, support locations, storage, lighting, ventilation, and water containment. Explain whether the user stands, transfers, rolls, or needs help. If the method may change, preserve reasonable options rather than fixing every dimension around an unverified product.
Allow for the opened-up room
Bathroom budgets can move when demolition reveals damaged framing, inadequate subfloor, old plumbing, poor ventilation, or a slab and drain arrangement that cannot accept the desired slope. Include demolition, disposal, substrate repair, waterproofing, plumbing, electrical, ventilation, framing or blocking, fixtures, surfaces, accessories, doors, glass or curtains, permits, inspections, and finish restoration.
Separate base scope from alternates. For example, price a targeted fixture or support change, a wet-area conversion, and a complete layout change if all are plausible. Make the concealed-condition allowance explicit and state who may approve a change before work proceeds. This prevents a low initial number from becoming a sequence of unplanned decisions while the bathroom is unusable.
Plan for the household during construction
Ask how long the primary bathroom will be unavailable, whether temporary bathing or toileting is needed, how dust and water will be controlled, and how the route will remain safe. Include relocation, storage, temporary fixtures, cleanup, and reinstallation of accessories. A bathroom remodel may be financially reasonable but impossible to schedule safely if the household has no usable alternative.
After completion, test the whole routine with the intended user and helper. Check entry, transfers, support, controls, water containment, drying, storage, and exit. The final cost is defensible when the room performs the required work and the household understands its maintenance and remaining limits.
