Solar, Storage & Backup Power

Project cost and decision guide

Understand the combined solar-and-storage scope, including generation, usable capacity, backup controls, electrical work, approvals, and lifecycle tradeoffs.

On this page

How Much Does Solar Plus Battery Storage Cost?

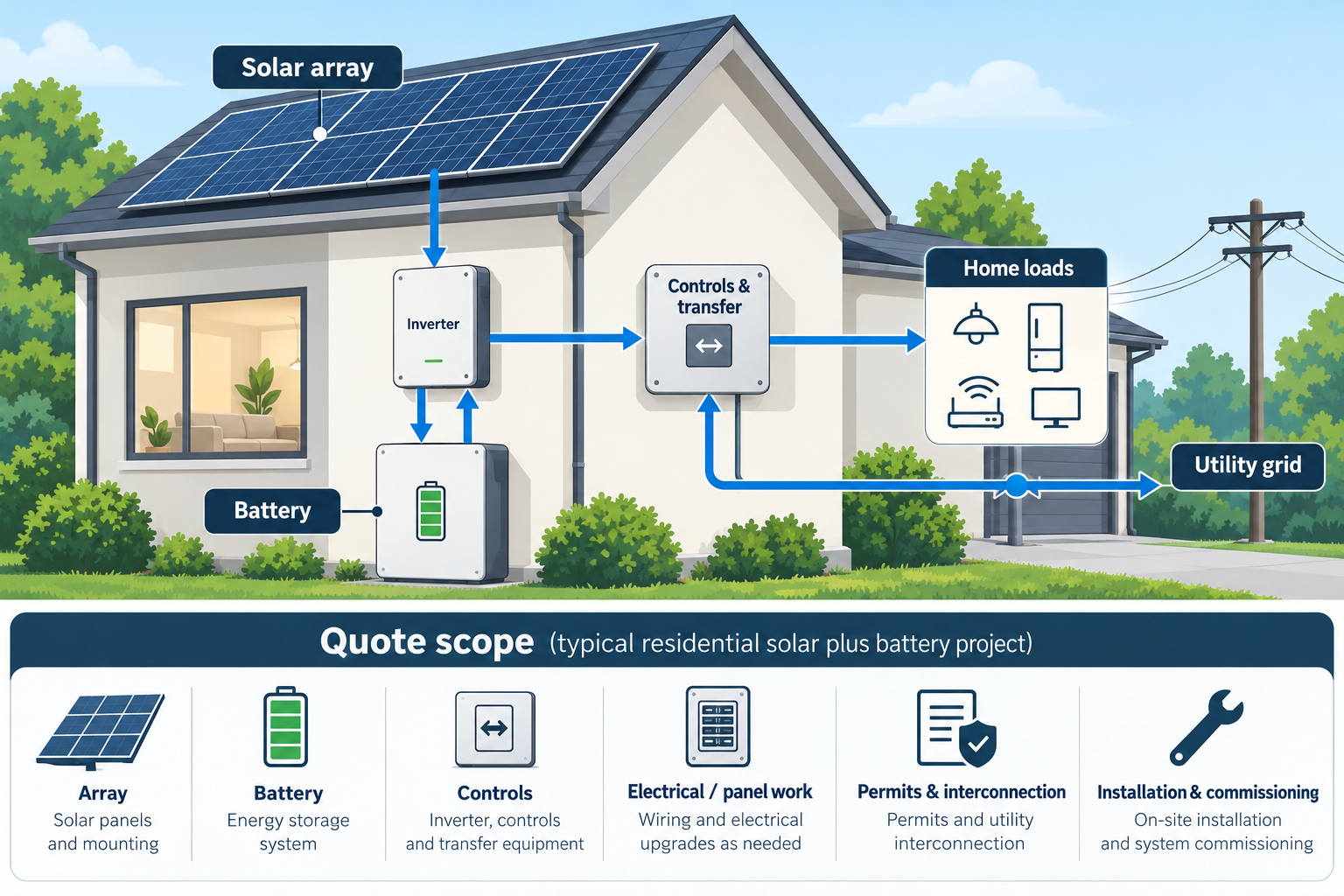

Solar plus battery storage combines two related but different purchases. Solar generates energy; the battery stores and controls energy for later use and may support outage loads. The combined quote can include the array, racking, inverters, battery units, gateway, transfer controls, wiring, roof work, permits, interconnection, commissioning, and monitoring. The cost cannot be reduced to solar price plus a retail battery price.

Define the purpose first

Decide whether the battery is primarily for evening self-consumption, rate management, outage backup, or a hybrid objective. The solar system’s production profile, the home’s loads, utility export treatment, desired backup circuits, and recharge expectations should be explicit. Solar panels alone generally do not operate a grid-dependent system during an outage; outage capability requires a properly configured inverter and storage architecture.

New combined installation

A new installation can coordinate the array and battery topology from the beginning. That may reduce duplicated design and wiring, but it does not guarantee the cheapest result. The battery may need a larger or different inverter, separate controls, a critical-load panel, or additional utility review. Installation location and access can add structural, enclosure, or electrical work.

Ask for separate solar-only, battery-only, and combined line items. Then identify savings that are genuinely avoided by doing the work together. Shared mobilization or design may be real; a generic “package discount” is not a scope explanation.

Cost drivers

Battery usable kWh and power output drive equipment. Whole-home coverage usually requires more power and transfer capacity than a small critical-load set. Roof planes, shading, future loads, service capacity, and inverter architecture drive solar. Distance between array, battery, and service drives wiring and equipment.

Approvals and utility treatment remain local. A battery can change interconnection, export behavior, and operating modes. Incentives or rebates can have product, installer, timing, and approval conditions. Verify before including them in net cost.

Three scenarios

Solar with modest storage: The battery shifts a portion of generation and supports limited circuits. The design may be economically attractive when export value is low or evening consumption is high.

Solar with critical-load resilience: The battery keeps selected refrigeration, communications, lighting, and pumps available. The load list and runtime matter more than the home’s total square footage.

Solar with broad outage coverage: Higher simultaneous loads require more power, controls, and possibly load management. Electric heat, central air, ranges, dryers, and EV charging can make whole-home operation a fundamentally different budget.

Ownership economics

Compare energy savings, export value, outage value, maintenance, inverter replacement, capacity retention, and eventual battery replacement. Storage can have value beyond payback, but state that value separately. If the battery is sized for rare outages, its financial case may rely on resilience rather than bill savings.

Reliable comparable current installed-price coverage is limited for U.S. and Canadian solar-plus-storage projects. Use local quotes, separate USD and CAD market references, and ask for an equipment and control schedule. The best comparison is a transparent system that delivers the intended services with a credible service and replacement path.

Do not hide the battery’s second job

A battery used for daily energy management may be operated differently from one reserved for outages. A reserve setting that protects outage capacity can reduce daily bill-shifting value. A system optimized for daily cycling may not provide the duration the homeowner expects. Require the proposal to state its operating priority and the value assigned to each service.

Roof, service, and approval dependencies

The solar portion may require roof assessment, attachments, structural review, and a utility application. The storage portion may require different controls, a critical-load panel, service capacity, and an approval or rebate application. A shared installation date does not make the scopes interchangeable. Identify which costs disappear if the battery is deferred and which must be done for solar regardless.

Compare staged options

Request solar-only, solar-plus-storage, and storage-ready alternatives where the design genuinely supports them. A staged option can preserve capital but may later require a new inverter, gateway, or approval. A combined option can coordinate equipment but may increase initial capital. The best choice depends on the homeowner’s load, outage risk, export value, and ownership horizon.

Storage can solve a different problem from solar

If exports have low value, storage may increase self-consumption. If outages are the concern, the battery may be held in reserve and cycle less for bill savings. If production is insufficient, adding storage cannot create energy that the array never generates. Ask the proposal to show which benefit comes from solar, which comes from storage, and which depends on the utility program.

Test a deferred battery

If capital is limited, compare installing solar with a documented future battery path against installing both now. Include the risk that future equipment will require an inverter or gateway change, a new approval, or different wiring. A staged plan is valid only when the current architecture genuinely preserves that option.

Use a service-by-service comparison

For each proposal, identify solar production, direct household use, export, stored energy, outage circuits, transfer behavior, and recharge. A battery can be expensive if it is sized for an outage but used only for a small daily load, or if it is sized for bill management but does not deliver the expected outage service. Keep the functions separate so one benefit does not conceal a missing one.

Future replacement matters

Solar modules, inverters, controls, and batteries may have different replacement timing. Ask which components are expected to be replaced together and which can be serviced independently. Include access, downtime, compatibility, and disposal in the ownership model. Coordinated new installation is valuable only when it leaves a credible future service path.

Separate the two jobs in one proposal

Solar and storage can share design, permitting, wiring, and commissioning, but they deliver different services. Solar primarily changes the source of energy; storage changes when energy is used and may support selected loads during an outage. Ask the installer to show the price and performance of the solar-only case, the battery-only or deferred-battery case where practical, and the combined case. This reveals which work is genuinely shared and which cost exists only because the second system was added.

The combined design may need a different inverter topology, controls, service capacity, critical-load panel, monitoring path, or utility approval. A lower combined price can be real when a single design avoids rework, but it should not erase the future replacement cost of two different equipment families. Record the operating mode when the grid is present and absent; a grid-tied array is not automatically backup power.

Decide whether staging preserves value

Defer storage when the household needs bill reduction but has no clear outage load list, when the roof or service is unresolved, or when the storage platform is not yet supported locally. Install together when outage architecture, controls, approval, and location are already defined and a second mobilization would create substantial rework. In either case, ask what must be installed now to keep the alternative feasible and what will become more expensive if postponed.

The strongest quote makes those choices visible instead of presenting combined equipment as an inevitable package. It should state usable capacity at commissioning, backed-up circuits, recharge assumptions, export behavior, replacement responsibilities, and the conditions under which the system will not provide the promised service.
