Security, Low-Voltage, Networking & Smart Home

Project cost and decision guide

Budget new-construction low-voltage prewire for Ethernet, cameras, access points, alarms, doorbells, intercoms, controls, conduit, central equipment, labels, and testing.

On this page

New-Construction Low-Voltage Prewire Cost

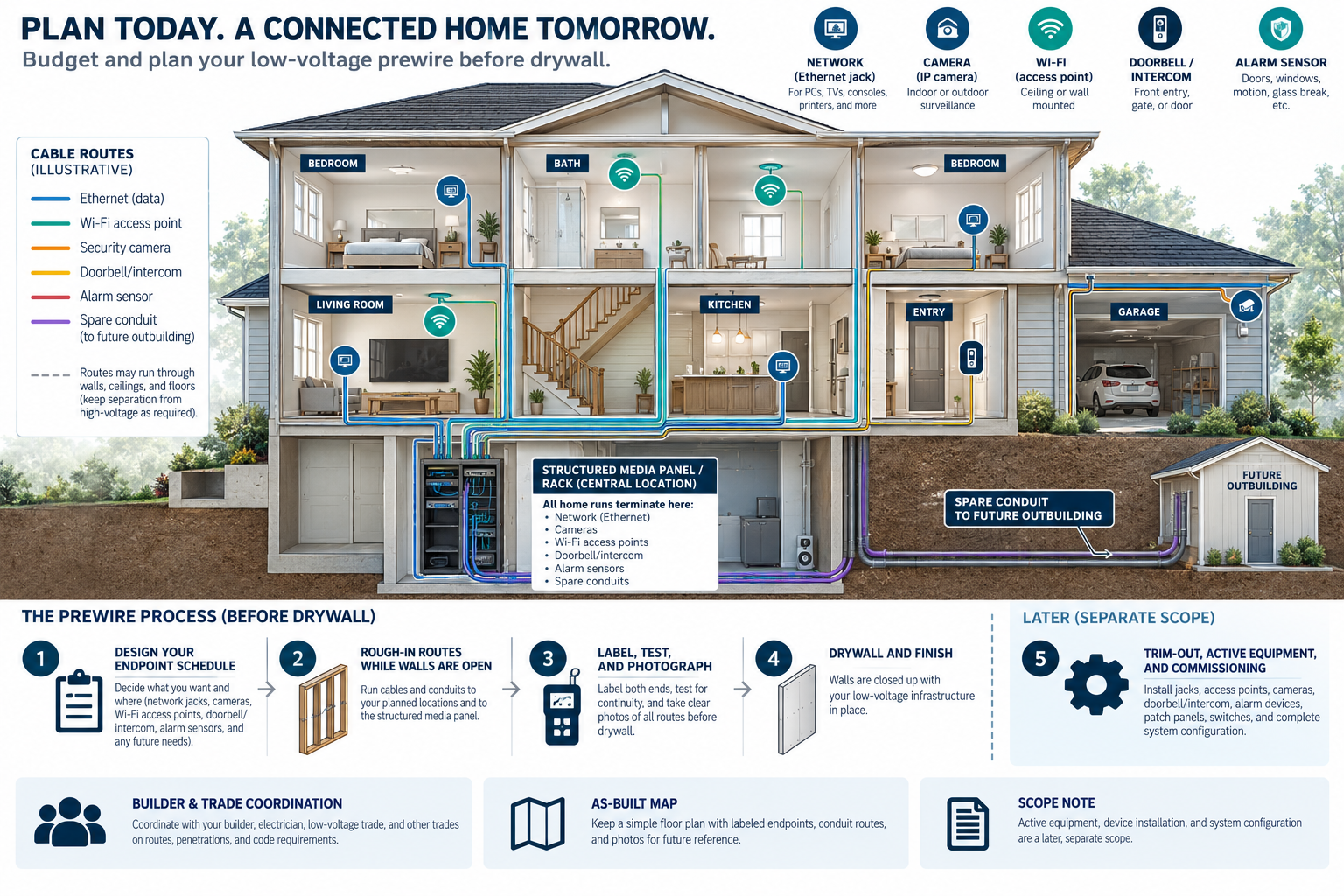

New-construction low-voltage prewire may cost about $1,500–$6,000 in the U.S. or C$2,000–C$8,000 in Canada for a modest home with planned data, camera, doorbell, alarm, and access-point pathways. A broad whole-home integration prewire can reach $6,000–$20,000 or more or C$8,000–C$28,000 or more when it includes extensive drops, conduit, fiber, a central rack, control wiring, documentation, and coordination.

The key advantage is access. Cable pathways can be installed before drywall, paint, trim, and cabinetry make the same work disruptive. Prewire is not a complete smart-home installation; it is infrastructure that makes later equipment and commissioning more economical.

Why prewire is a distinct project phase

Open walls allow an installer to plan routes, centralize terminations, add conduit or spare pathways, and label runs before finishes conceal them. Residential telecommunications infrastructure can support data, video, security, audio, and control functions, so a prewire plan should coordinate the systems that may share paths or central equipment.

The cost is often paid before the homeowner has selected every device. That makes scope clarity important. A useful plan describes endpoints and pathways without making unsupported promises that every future product will use them.

Systems commonly included

A prewire may include pathways for:

  • Ethernet room drops and wired access points;
  • PoE cameras and video doorbells;
  • alarm sensors, keypads, and sirens;
  • intercom and door-entry stations;
  • access-control readers and gate communications;
  • leak, freeze, or environmental sensors;
  • automation controllers and low-voltage interfaces;
  • fiber or conduit for future backbone use.

High-end entertainment or distributed audio is not automatically part of this category. If a project includes those systems, identify them as separate scopes rather than hiding them in a generic low-voltage allowance.

Cost drivers

The largest variables are:

  1. number and type of endpoints;
  2. distance and route complexity;
  3. central panel or rack location;
  4. conduit and spare pathways;
  5. exterior and outbuilding routes;
  6. cable type, terminations, and equipment;
  7. design, labeling, testing, and documentation;
  8. builder and trade coordination;
  9. changes made after the prewire plan is approved.

Do not prescribe a universal number of drops per room. A home office, camera location, bedroom, utility room, garage, and access-point location have different purposes. Plan around the homeowner’s expected decisions and future flexibility.

Cabling and conduit

Cable material is only part of the budget. Include cable, supports, boxes, terminations, patch panels, exterior protection, and central organization. Conduit or accessible pathway can be valuable where future technology, long runs, or difficult replacement conditions matter, but it adds material and labor.

Fiber may be useful for a specialized backbone or a long outbuilding connection, while ordinary copper Ethernet may be sufficient for room drops. The selected cable type should match the route, equipment, and future objective. A higher category does not automatically deliver value if terminations, pathway, or network equipment are not designed for it.

Ask whether empty conduit has a pull string, accessible endpoints, route documentation, and a clear termination plan. A hidden empty tube with no map may not save much future labor.

Central equipment location

A structured media panel or rack may hold patch panels, switches, gateways, controllers, power, labels, and service records. The location needs adequate space, ventilation, and accessibility. A small panel may suit a few data runs; a rack may be more appropriate for multiple switches, a recorder, automation controller, and future expansion.

Power and line-voltage work should be priced separately. Low-voltage prewire does not automatically include new receptacles, branch circuits, surge protection, or an electrical panel. Coordinate the location with the electrical contractor and builder.

Cameras and access points

Camera and access-point locations should be chosen for the intended view or coverage, not only for architectural symmetry. Include cable route, mounting backing, weather exposure, service access, and future device replacement.

A PoE device may require a suitable switch and power budget later. The prewire can reserve the route, but it does not guarantee that a future camera or access point is compatible. Document endpoint labels and leave a workable service loop where the installer’s standard permits it.

Testing and documentation

Testing is part of the value of prewire. Ask whether the installer will verify continuity, pinout, cable qualification or certification, labels, and any pathway or conduit. Request a room-by-room map, central termination schedule, photos before drywall, cable type, unused pathway record, and test results.

Without documentation, the homeowner may pay again to identify a cable after the walls close. A clean handoff also reduces the cost of future camera, network, alarm, and automation installation.

What to decide before walls close

Before approval, resolve:

  • which rooms and exterior locations need a data or control path;
  • where the central panel or rack will live;
  • how future cameras, access points, and door-entry devices will be reached;
  • whether a detached building needs conduit, fiber, or a wireless option;
  • which routes need exterior protection;
  • what spare conduit or pathways are valuable;
  • who owns labels, test results, and photos;
  • what changes are allowed after rough-in.

The plan should identify assumptions and exclusions. “Smart-home ready” is too vague to compare between builders.

Coordinating the prewire handoff

Set a date for a rough-in walk-through before insulation and drywall. Confirm the location of every outlet, access point, camera, doorbell, intercom, alarm keypad, controller, and central termination. Mark changes on the plan and photograph routes while they are visible. If a pathway is omitted, the owner should know before finishes close.

The final handoff should include labels at both ends, cable types, test results, central port map, conduit or spare-pathway records, and the equipment or system assumptions used to choose each route. Ask who owns the documentation and whether the builder’s closeout package includes it. A prewire without a usable map can turn a future installation into a new inspection project.

Do not overbuild blindly. A smaller, well-labeled infrastructure plan with accessible pathways may be more useful than a large bundle of unidentified cable.

U.S. and Canadian budgeting

Use local U.S. or Canadian quotes in the correct currency. Labor, builder coordination, equipment channels, taxes, and construction practices vary by region. Do not convert a U.S. prewire price into a Canadian estimate.

The standards and specialist guidance support infrastructure relationships, not a universal national package price. Model the actual endpoint schedule and obtain a detailed allowance or quote.

Scope boundaries

This article addresses low-voltage pathways and infrastructure. Physical gate construction, line-voltage circuits, HVAC equipment, lighting fixtures, and high-end entertainment design may belong to other project scopes. Automation can integrate those systems without owning their physical replacement or electrical costs.

Protecting the value of prewire

The prewire should be approved as a deliverable, not as an adjective. Before drywall, photograph routes and central locations, label both ends, record cable types, confirm conduit access, and test the runs. Ask who will provide the final map and what happens if an endpoint changes during construction.

Reserve only pathways with a plausible future purpose. A spare conduit to an exterior camera, access point, gate, or outbuilding can be valuable where later access would be difficult. Unplanned cable everywhere can increase cost and create a crowded central panel. Coordinate the locations with framing, insulation, HVAC, electrical, cabinetry, and finish trades.

Avoiding change-order surprises

Put rough-in assumptions in the construction schedule. Identify who supplies boxes, brackets, conduit, labels, testing, and central equipment, and who is responsible when a route conflicts with framing or another trade. Ask whether late device selections change only the endpoint or also the pathway. A written change-order rule protects the value of prewire when the design evolves before finishes close.

Before approving the allowance

Ask the builder to identify which parts are rough-in only and which deliverables are included at closeout. A prewire quote should not leave the homeowner guessing whether jacks, cameras, switches, racks, testing, or programming are included. Put future pathways and documentation in the written scope.

Setting a useful stopping point

Prewire should stop at the point where future access, current devices, and likely expansion are reasonably served. Additional cable that has no route, endpoint, or future purpose can crowd the central location and add cost without improving the homeowner’s decisions.

Key points

  • Prewire costs more before equipment is chosen but can avoid expensive finished-wall access later.
  • Plan endpoints, central equipment, conduit, labels, testing, and documentation together.
  • Do not use a universal outlet count or “smart-ready” label as a complete scope.
  • Separate low-voltage pathways from line-voltage, physical construction, and entertainment work.
  • A useful prewire handoff includes maps, labels, test results, photos, and future-pathway records.

Final quote checkpoint

Before walls close, approve a room-and-endpoint schedule rather than an unexplained cable count. Identify camera locations, access points, door stations, alarm devices, network outlets, media locations, rack or panel location, and spare pathways. Confirm cable type, bend and separation requirements, labels at both ends, service loops, firestopping, inspection coordination, and photographs before closure. Ask which equipment and programming are deferred to the finish phase and which rough-in decisions cannot be changed later. The most valuable prewire often preserves a future route or central location even when the final device is not yet selected. Require an as-built map so the next installer can distinguish a tested cable from an unused or unknown run.
