Changing a kitchen layout is a coordination project, not just moving cabinets on a drawing. The new arrangement may require cabinet redesign, countertop changes, plumbing, electrical, gas, ventilation, flooring, wall repair, structural review, design, permits, and finish restoration.
What can move
- cabinet runs, tall storage, or a refrigerator surround;
- sink and dishwasher zone;
- range or cooktop;
- island or peninsula;
- door, opening, or circulation path.
Each move has a different route and access problem. A short distance through an accessible framed floor is not equivalent to the same distance through a slab or finished ceiling.
Cost-risk hierarchy
| Change | Common added decisions |
|---|---|
| Cabinet run | New sizes, fillers, panels, counter, flooring, and wall finishes |
| Sink zone | Water, drain, vent, cabinet, counter cutout, and dishwasher |
| Cooking zone | Circuit or gas, counter cutout, clearances, and ventilation |
| Island | Cabinet, counter support, circulation, floor access, and possible services |
| Wall or doorway | Structural review, permits, finishes, and adjacent-room work |
These are cost drivers, not universal line-item prices. Independent system projects retain their own category ownership.
Build a useful quote
Ask for two options with identical cabinet, countertop, appliance, and finish assumptions: retained layout and proposed layout. Require the relocation path, access conditions, opening and patching, design, permit, inspection, trade, and restoration costs to be visible. Do not accept a generic “relocation allowance” without a stated assumption.
Price one specific move from end to end
For each proposed move, trace the work from the old location to the new one. A sink estimate should identify cabinet and counter changes, disconnects, supply and drainage path, access, patching, and reconnection. A cooking-zone estimate should identify equipment type, capacity or fuel connection, hood/duct implications, cutouts, and affected cabinetry. An island estimate should account for circulation, finish panels, flooring, counter support, and any route for added services.
The lowest-detail bid often leaves the most room for later exclusions. Ask whether design, exploratory openings, permits, inspections, protection, disposal, finish restoration, and corrections are included. If a route is unknown, ask what information would resolve it and how that investigation will be priced before approving the build scope.

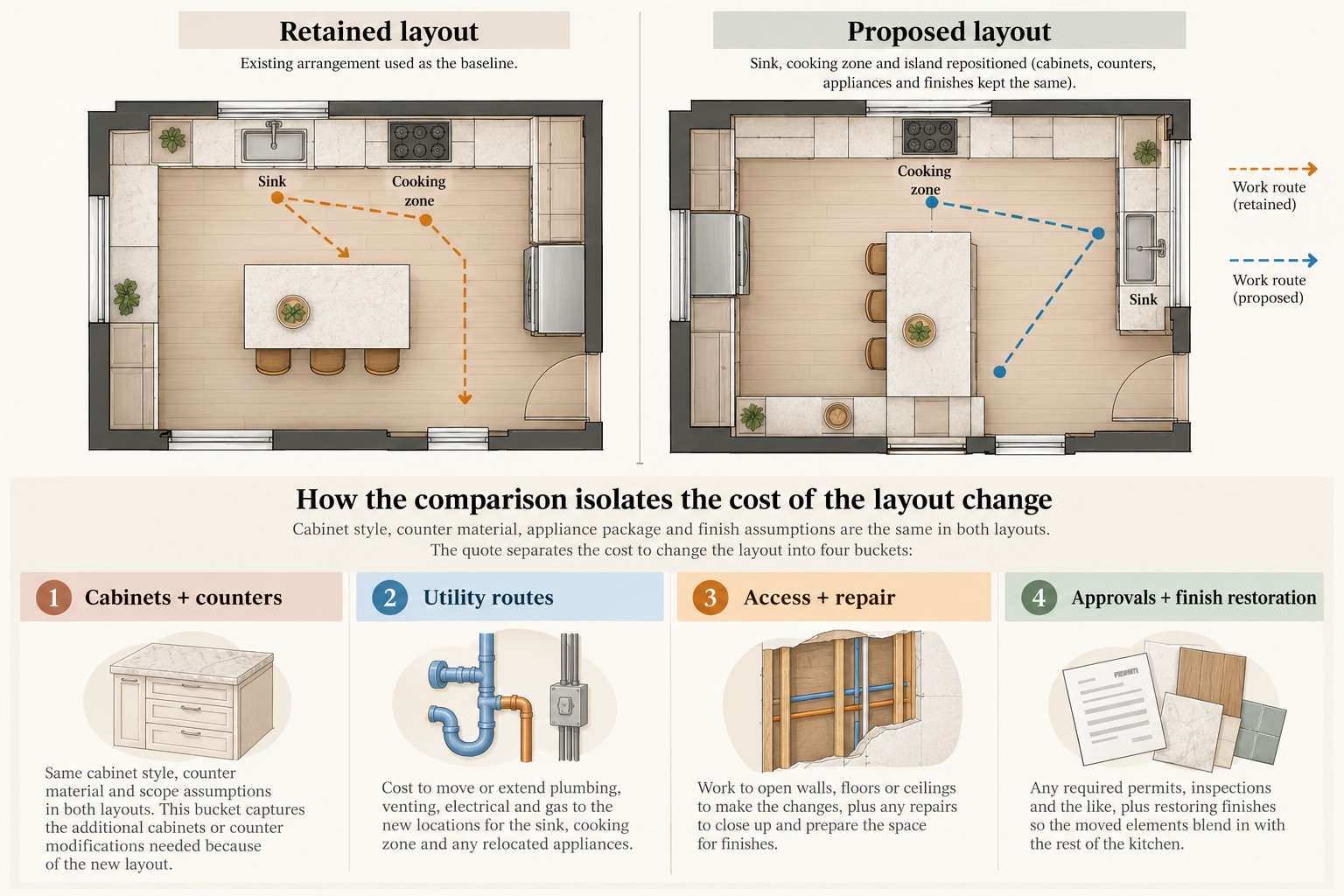

Compare alternatives with a shared baseline
Prepare a current-layout drawing and a proposed-layout drawing. Hold the cabinet level, counter, appliance selection, and finish quality constant, then compare the added lines that appear only in the new arrangement. If two bids assume different retained appliances or different amounts of flooring and backsplash replacement, have them rebased before comparing totals.
Make the benefit explicit as well. A new layout may be worth additional work when it improves usable storage, circulation, landing areas, or access for the household. It is harder to justify when the new arrangement changes appearance without solving a recurring functional problem. Compare the smallest change that fixes the issue with the more complete design and include the disruption and future work each leaves behind.
Use a quote worksheet for the access route
For each relocated function, record the old and new location, distance, wall or floor construction, access below, surface to open, surface to restore, connected cabinet/counter work, permit responsibility, and inspection or testing. Note which path is confirmed and which is only an allowance. A route through an accessible floor and a route through a slab are different bids even if the fixtures move the same distance.
If the plan includes both a moved sink and a new island, ask whether the plumbing route is priced once or has been included in both the island and relocation line. If a contractor shows one broad “layout allowance,” ask for its assumptions and excluded services. That makes it possible to compare a shorter route, alternate cabinet plan, or retained zone without relying on a general layout premium.
Is the change worth it?
Layout change can create value by fixing blocked circulation, poor work zones, inaccessible storage, appliance conflicts, or a room that no longer fits the household. It may not justify its cost when the move is primarily cosmetic or when the same function can be gained with a cabinet, organizer, or finish change.
The 2026 U.S. Houzz study shows that homeowner projects span source-defined minor and major scopes, but it does not establish a universal layout premium. Canadian market guidance is separately defined and must be quoted in CAD.
Make the estimate explain each added line
The scope can be compared in four groups: the new cabinet and countertop arrangement; services moved to support it; access and restoration needed to run those services; and approval or inspection work required for the project. Have each bidder mark which items apply to the retained layout and which exist only in the changed layout. This separates the cost of the chosen design from the base remodel.
If the quote includes an allowance for a future opening or utility route, ask what information would convert it to a fixed price. If a trade quote excludes patching, add that line from the general contractor or finish professional. If permits are required, record who applies, pays, and schedules inspection. These boundaries help reveal both missing work and duplicate charges across a general contractor and trade proposals.
Approvals and professional boundaries
Electrical, gas, plumbing, ventilation, structural, and permit rules vary by jurisdiction and adopted code. Confirm them before demolition or ordering cabinets. If structural alteration or whole-home reconfiguration becomes the dominant decision, compare major remodeling.
Bottom line
Price a layout change from the full path between the old and new arrangement: design, cabinets, counters, utilities, access, openings, finishes, approvals, and restoration. Approve the move only when the functional benefit is clear against that complete scope.
