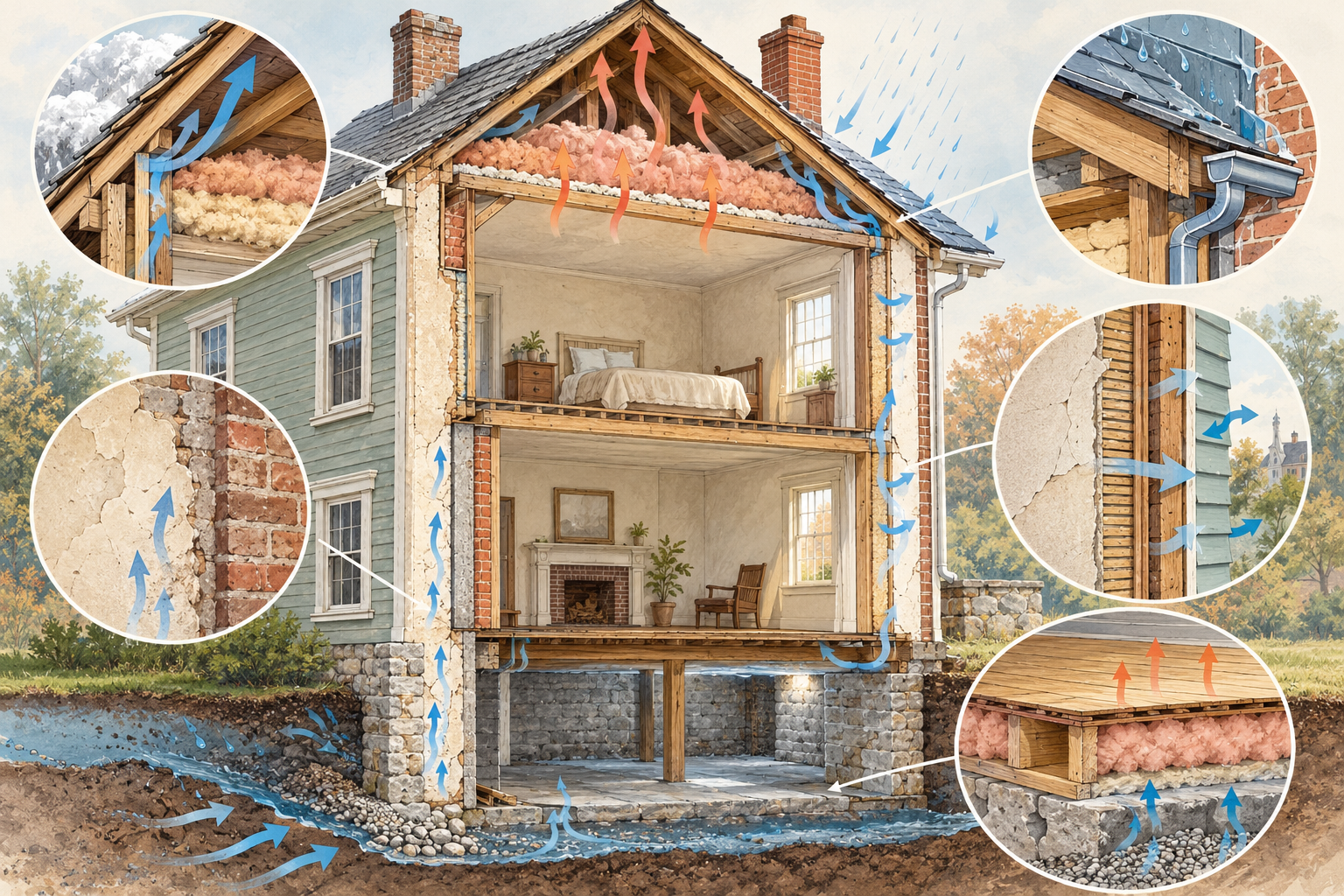

Insulating an Old or Historic House Without Creating New Moisture Problems

Insulation changes heat flow and can change where air and moisture move. In a traditional wall, roof, attic, basement, or floor assembly, a product common in new construction may not be appropriate without understanding the existing materials, climate, exposure, ventilation, and drying paths. There is no universal old-house wall recipe.

Fix water and identify the assembly first

Document the layers, finishes, cavities, previous repairs, air paths, and signs of dampness. Correct roof, drainage, plumbing, foundation, and condensation problems before adding insulation. An insulation contractor should explain how the proposed work interacts with masonry, wood, plaster, siding, roofing, and existing ventilation.

Separate air leakage from conductive heat loss. Some accessible air-sealing or attic work may offer useful performance with limited fabric impact, while a wall intervention may disturb finishes, conceal moisture, or change drying behavior. Interior and exterior approaches have different consequences for trim, siding, masonry, vapor movement, and future inspection.

Screen materials before disturbance

Older insulation, pipe or tank insulation, plaster, tiles, roofing products, and surface treatments may contain asbestos or other hazards. Health Canada advises professional testing before renovating or remodelling where suspect asbestos materials may be disturbed and says vermiculite insulation should not be disturbed or removed by a homeowner. U.S. and Canadian rules and screening examples differ. Build testing and qualified removal into the scope when relevant rather than assuming a material is safe by appearance.

Specify evaluation and monitoring

Ask the designer or building-science professional to state the climate and assembly assumptions, the moisture risks considered, the locations treated, the areas left accessible, and how performance will be monitored. Avoid guarantees based only on a generic R-value or a single payback estimate. Monitor humidity, staining, odors, surface temperatures, and seasonal changes after the work; unexpected behavior is a reason to investigate, not to add another layer.

The cost comparison should include investigation, testing, access, protection, insulation, air sealing, ventilation changes, trim or siding removal, finish restoration, and monitoring. A smaller, lower-risk improvement can be better value than a more aggressive retrofit that creates an expensive concealed failure.

Compare common locations carefully

Attic and roof work may be comparatively accessible, but the proposal still needs to address roof leaks, ventilation, moisture, electrical clearances, and any existing insulation or pipe material that could be disturbed. Basement, crawl-space, and floor work may affect foundation moisture, rim areas, combustion equipment, plumbing, and access to historic floors. Wall work can affect both sides of the enclosure and is often the most restoration-intensive choice.

Interior and exterior insulation are not interchangeable. Interior work can change room dimensions, trim, plaster, electrical boxes, and drying paths. Exterior work can change siding, masonry, roof edges, openings, and the appearance of the building. A designer should identify what is removed, what remains inspectable, how water is managed, and what happens at transitions before a product is selected.

Use a decision gate before closing the assembly

Require the proposal to state the existing assembly, the suspected moisture sources, the climate and exposure assumptions, the location of air and vapor control, the expected drying paths, and the areas that will remain visible or accessible. If those facts are unknown, price investigation or a limited opening before the full retrofit.

After installation, monitor humidity, surface temperature, staining, odor, condensation, and seasonal changes. A new symptom is not proof that insulation caused a problem, but it is a reason to stop and investigate. Do not respond to uncertain moisture by automatically adding another impermeable layer.

Budget for the building, not just the insulation

Compare material cost with testing, design, protection, access, removal, air sealing, ventilation changes, trim or siding work, hazard controls, disposal, finish restoration, and monitoring. Include the cost of returning to a concealed area if a future repair is needed. Keep any projected energy savings tied to the actual climate, utility rates, occupancy, and baseline rather than presenting a universal percentage.

Require an assembly description

Before approving insulation, ask for a written description of the existing layers, the proposed layers, the air and vapor control assumptions, the direction of drying, ventilation, water management, and the interfaces with windows, roofs, floors, and utilities. The description need not promise that an old building behaves like new construction; it should make the designer’s assumptions reviewable.

If a layer is concealed or its condition is unknown, identify the observation or limited opening that would change the design. Price that investigation and its restoration separately. A product label or nominal thermal rating cannot establish that the assembly will remain dry, inspectable, and compatible with retained historic fabric.

Compare intervention levels

Compare maintenance and air-sealing, accessible attic or floor work, localized assembly repair, and a more invasive wall or roof intervention when each is technically feasible. For every level, show the material disturbed, the moisture uncertainty, access and restoration, expected performance, and future service path. The least invasive option may be the best first phase even if it does not maximize modeled insulation value.

Interior and exterior strategies should be compared as building changes, not as competing products. Interior work can affect room dimensions, trim, plaster, and electrical boxes. Exterior work can affect siding, masonry, roof edges, openings, and views. A qualified designer should state how transitions and retained materials will be protected.

Treat uncertainty as a staged decision

Use a decision gate before closing the assembly: confirm the observed condition, the moisture assumptions, the selected material and location, the interface details, and the monitoring plan. If the evidence is not adequate, stop at assessment or a limited test area rather than committing the entire wall or roof.

After installation, record humidity, surface temperature, staining, odor, condensation, and seasonal behavior. Define who reviews the result and what change triggers a follow-up. Monitoring is not a substitute for design, but it can keep a small uncertainty from becoming a concealed whole-house failure.

Make transitions the center of the review

Inspect windows, doors, corners, floors, roofs, chimneys, foundations, vents, wiring, pipes, and retained finishes where the insulation begins or ends. Many old-house problems are not in the open field of an assembly but at an edge or penetration. Ask how the proposed work maintains drainage, drying, access, and protection at each transition.

Do not approve a wall or roof package from a product name alone. The professional scope should state the treatment area, adjacent materials, expected finish, and what happens if the assembly is different from the assumed condition. A limited test area or staged phase can be more informative than a full installation that conceals the evidence.

Plan the owner handoff

Record the layers added or removed, areas left untreated, access points, monitoring measurements, maintenance needs, and signs that warrant professional review. Include the location of any retained or suspect material and do not represent the record as a safety clearance. Future work should begin from the documented assembly rather than another round of blind opening.

Make the assembly reviewable later

Keep photographs, drawings or notes of the layers, test areas, materials, interfaces, areas left untreated, and monitoring observations. Record who made the design decision and what future work must trigger another review. This is especially important when a later contractor cannot see the original wall or roof assembly.

The handoff should distinguish the installed insulation from air sealing, ventilation changes, moisture correction, hazard work, and finish restoration. Those scopes can interact, but they are not interchangeable. A clear record helps the owner maintain the building without assuming that a successful installation is a universal old-house solution.

Make the monitoring decision explicit

State who will review humidity, staining, odor, condensation, and seasonal behavior; when the review occurs; and what finding requires a qualified reassessment. Keep the assembly record with that monitoring plan so future work does not add a layer without understanding the existing one.

Record what the retrofit did not prove

The handoff should distinguish installed insulation from a verified energy saving, a moisture-free assembly, a hazard clearance, or a universal maintenance recommendation. Those conclusions require their own evidence and, where relevant, qualified professional review.

Build a local estimate

No reliable national USD or CAD range applies to this specialized historic-home work. Request a dated local proposal that separates investigation, access, protection, materials, specialist labor, permits or review, restoration, and future maintenance. State the condition, area, and assumptions covered by each option.

Compare complete scopes in the market where the work will occur. Keep confirmed work, allowances, and owner-selected upgrades separate, and do not convert a price mechanically between U.S. and Canadian markets.
