Sagging Roof Structural Repair Cost
US planning allowances range from $1,000–$5,000 for inspection and a limited framing repair, $5,000–$20,000 for localized rafter or truss work with access, and $15,000–$60,000+ when roofing removal, widespread framing, supports, or finish restoration are involved. These bands exclude ordinary roof-covering replacement unless the quote states otherwise. Canadian homeowners should obtain local CAD pricing.
A sagging roof is a symptom

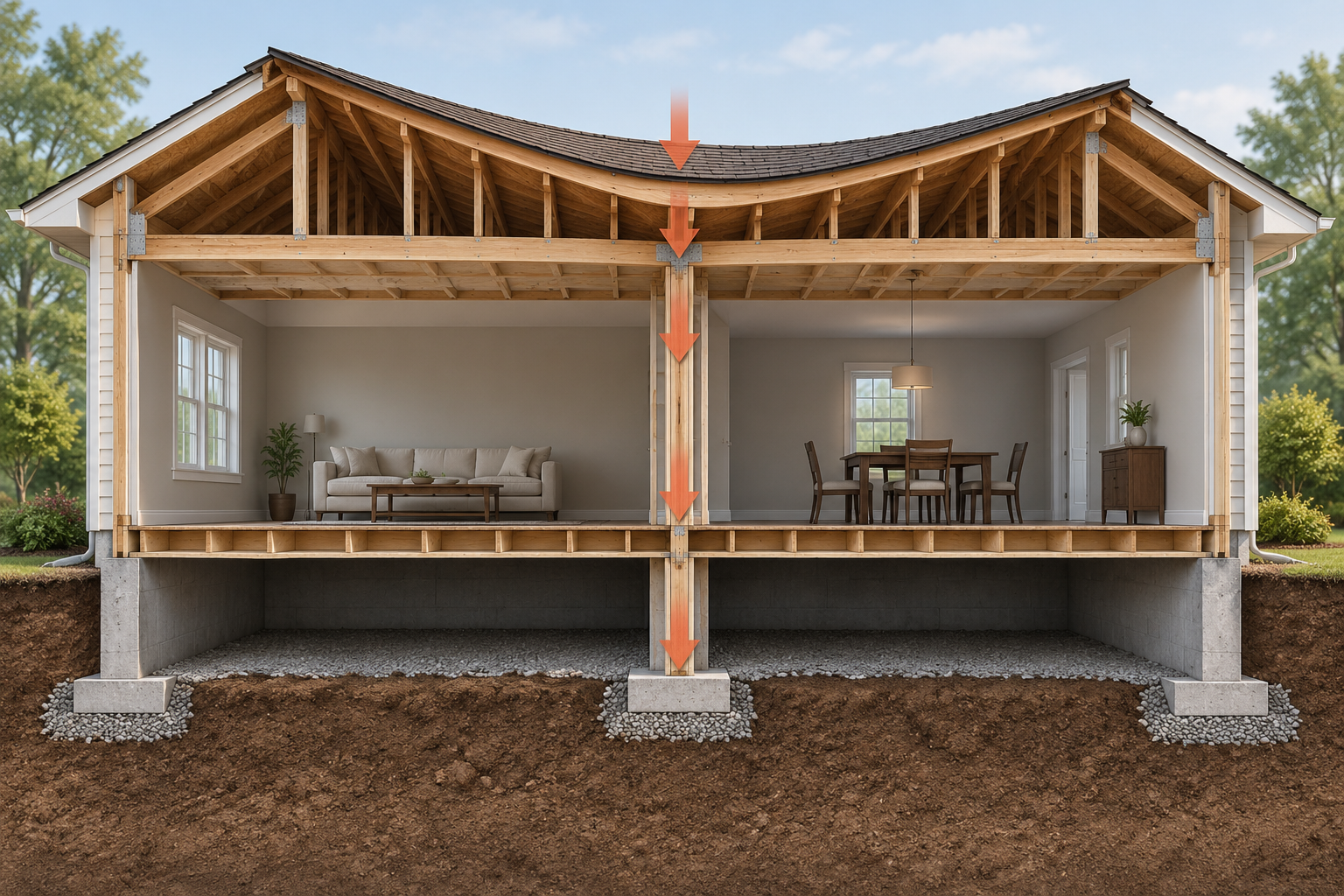

A sag may involve rafters, trusses, ridge or wall supports, spread, overloaded or altered framing, water-damaged members, roof covering weight, or movement lower in the structure. HUD roof and structural inspection guidance supports keeping framing separate from the covering and treating the cause as a project-specific assessment.
Visible sag does not by itself establish imminent failure, but it does make a covering-only quote incomplete until the framing question is addressed. Roof access and temporary support are high-consequence work; this article does not provide inspection or shoring instructions.
Cost pathways
A localized rafter or connection repair may need attic access and limited finish work. Truss repair can require design or manufacturer involvement. Widespread sag may require opening the roof, replacing framing, correcting a support wall or foundation, removing and replacing roof covering, and restoring ceilings or insulation.
Roof covering, deck, flashing, and leak repair belong to the roofing category. They can be related costs when the structural repair opens the assembly, but they should not be silently combined with framing.
Cost drivers
Member type, sag extent, roof geometry, height and pitch, access from attic or roof, roofing removal, deck condition, insulation and ceiling finishes, temporary support, utilities, engineering, permits, material handling, weather, and restoration matter. A small visible area may conceal a longer load-path issue.
Scenarios
Focused framing repair: One accessible rafter or connection is damaged and the covering can remain. Verify the cause and the extent inspected.
Typical structural opening: Several members need repair, requiring partial covering removal, temporary protection, design input, and finish restoration. Normalize these lines across bids.
Broad or connected movement: The roof, wall, floor, or foundation shows a related pattern. Budget for a wider structural assessment and possible support or foundation work rather than repeatedly repairing the visible roof plane.
Compare quotes
Ask what is sagging, what evidence identifies the failed layer, whether the proposal stabilizes or restores geometry, what framing and covering are included, how temporary support and weather protection are handled, who designs the repair, and how concealed damage is priced. A complete roof-framing budget makes the covering boundary clear.
Separate roof framing from lower support
If the ridge, wall, ceiling, floor, or foundation shows a related pattern, ask whether the proposal is limited to roof members or includes the supporting load path below. A roof-framing repair can be wasted effort if the supporting wall or foundation is moving. Conversely, a foundation repair quote should not silently include roof covering or attic finish replacement.
For a short horizon, a defined framing repair may be enough when the cause is bounded and the covering remains serviceable. For a long horizon, include the cost of opening the roof once, restoring insulation and finishes, and resolving any moisture or alteration source. The final scope should state what was inspected and what remains uncertain.
Before signing a structural roof quote
Record the inspected area, the framing members and connections included, the access route, temporary support, weather protection, roofing and finish restoration, engineering, permits, and the rule for concealed damage. Then write down the condition that would make the contractor stop and obtain a revised scope. This keeps a planning allowance from becoming an open-ended authorization.
Compare the cost of completing the known structural work during one opening with the cost of returning later. Keep covering replacement, drainage, insulation, and interior restoration separate unless they are required by the framing repair. The decision is ready when the expected roof result, remaining uncertainty, and adjacent work are all visible.
Budget the boundary between roof and structure
Ask whether the covering, deck, ridge, wall, ceiling, and foundation were inspected or merely assumed. If the roof must be opened, put dry-in, flashing, insulation, interior finishes, disposal, and weather delays into the same comparison. If lower supports are implicated, show that structural work separately.
A useful base case repairs the identified framing; an expected case includes limited concealed damage; a difficult case includes connected support or broad roof replacement. This gives the homeowner a decision threshold without claiming that visible sag alone identifies the cause.
Trace the load path below the visible sag
Roof framing can sag because of damaged rafters or trusses, excess load, connection failure, water damage, inadequate support, settlement below, or a changed opening. A roof-only quote is incomplete if the framing bears on a wall, beam, post, or foundation that has also moved. Ask the contractor to state what was inspected above and below the roof line and which cause is assumed.
The finished outcome also matters. Temporary weather protection, roofing removal and replacement, insulation, ceiling or drywall repair, chimney or mechanical interfaces, and exterior trim may be separate. Straightening can disturb brittle finishes even when the framing is strengthened. Compare stabilization in place, selective replacement, and broader reconstruction by the residual load path and restoration boundary. The cheapest method is not useful if it leaves the suspected lower support unresolved.
Decide how much of the roof must be opened
An attic-side inspection may confirm a limited rafter or connection issue, while a roof-side opening may be needed to assess decking, flashing, water damage, or a concealed truss. The proposal should state the inspected area, the assembly it assumes is sound, and the dry-in or weather-protection work included. A covering replacement quote is not a structural assessment, and a framing quote that excludes the roof opening may not be a complete repair budget.
Ask whether the visible sag is being stabilized in place, corrected geometrically, or reconstructed. Those outcomes can affect rigid finishes, ceilings, chimneys, walls, insulation, and the roof covering differently. If the lower wall, beam, post, or foundation is involved, the roof work should identify that dependency instead of implying that a rafter replacement alone solves the movement.
Set a discovery rule before weather and finishes are removed
Use a base scope for the identified framing, an allowance or unit price for additional members and deck, and a decision point before broad demolition. Include disposal, dry-in, temporary protection, engineering, permits, interior restoration, and weather delays where material. For a long ownership horizon, compare opening the assembly once with a focused repair followed by a likely second opening. For a short horizon, document the remaining condition and exclude optional reroofing from the structural decision.
Decide whether geometry or capacity is the goal
A proposal may strengthen framing while leaving some sag, stabilize the roof in its present geometry, or attempt to restore a line or plane. These outcomes can have different effects on ceilings, insulation, chimneys, walls, finishes, and roof coverings. Ask what the contractor measured, what result is promised, and what finish consequences are included. A cosmetic straightening target should not be confused with a structural capacity decision.
The quote should identify the roof and framing areas inspected, the lower supports considered, the temporary protection needed, and the rule for concealed damage. If the roof must be opened, compare dry-in, flashing, deck, insulation, ceiling, disposal, and weather-delay costs. If the cause is a moving wall or foundation, price that dependency separately so the roof repair is not treated as a complete correction.
For long-term ownership, include documentation, future access, and source correction. For short-term ownership, a defined framing repair may be appropriate when the remaining condition is accepted. Visible sag can justify professional assessment, but it does not establish a universal urgency, method, or price.
Separate roof framing from the supports below it
Before approving a rafter or truss repair, ask whether the roof member bears on a wall, ridge, beam, post, or other support that was inspected. A sound-looking member can continue to deflect if the bearing below has settled, while a new member can transfer a larger reaction to a weak wall or footing. The scope should identify those interfaces, the temporary support sequence, and the point at which the contractor can confirm that the proposed repair remains appropriate.
Price the work in stages when the evidence is incomplete: assessment and opening, temporary protection, structural repair, weatherproofing, and interior restoration. State what finding changes the scope and how additional work is measured. For long-term ownership, preserve the roof plan, repaired members, and source-correction records. For short-term ownership, document the geometry and remaining uncertainty rather than treating a clean ceiling or new roofing as proof that the load path is corrected.
