Cost to Enlarge or Resize a Window Opening
Changing a window opening can be much more involved than replacing a window in the same opening. Raising or lowering a sill, widening the opening, reducing it, or changing its shape may affect framing, load transfer, cladding, flashing, interior finishes, utilities, and local approvals.
The direction of the change matters
A small height change may have a different structural consequence from a width change. Widening can affect studs, posts, headers, bracing, and nearby openings. Reducing an opening still requires a durable infill, insulation or air-control transition, exterior water management, and matching interior and exterior finishes. A masonry wall has different cutting, support, dust, and restoration needs from a framed wall.
Do not infer that an existing window’s header makes any larger opening safe. Have the load path and project-specific requirements evaluated by the appropriate professional where needed.
Cost components
| Component | Why it can matter |
|---|---|
| Temporary support and framing | The wall may need support while the opening is changed; the required design is property-specific. |
| New window and installation | Size, material, operation, glazing, and product availability change the unit scope. |
| Wall and cladding work | Siding, stucco, brick, masonry, sheathing, trim, and weather barriers may be opened and restored. |
| Flashing and air sealing | The altered opening must reconnect to the wall drainage and air-control layers. |
| Interior restoration | Insulation, drywall, casing, paint, flooring, and furniture protection may be included. |
| Utilities and approvals | Wiring, plumbing, permits, inspections, design, or engineering may be relevant. |
Building America guidance treats the sill, side, and head flashing as a connected drainage detail. Reusing the old perimeter detail without checking the new geometry can leave a path for water into the wall.
Egress and local requirements
If the opening serves a bedroom or emergency escape, verify the current adopted egress requirement before changing its size. The 2021 IRC is a model-code baseline, not universal U.S. law. Canada’s National Building Code is also a model framework and local provincial or territorial adoption controls. Safety glazing, guards, opening controls, and permits can depend on the project facts.

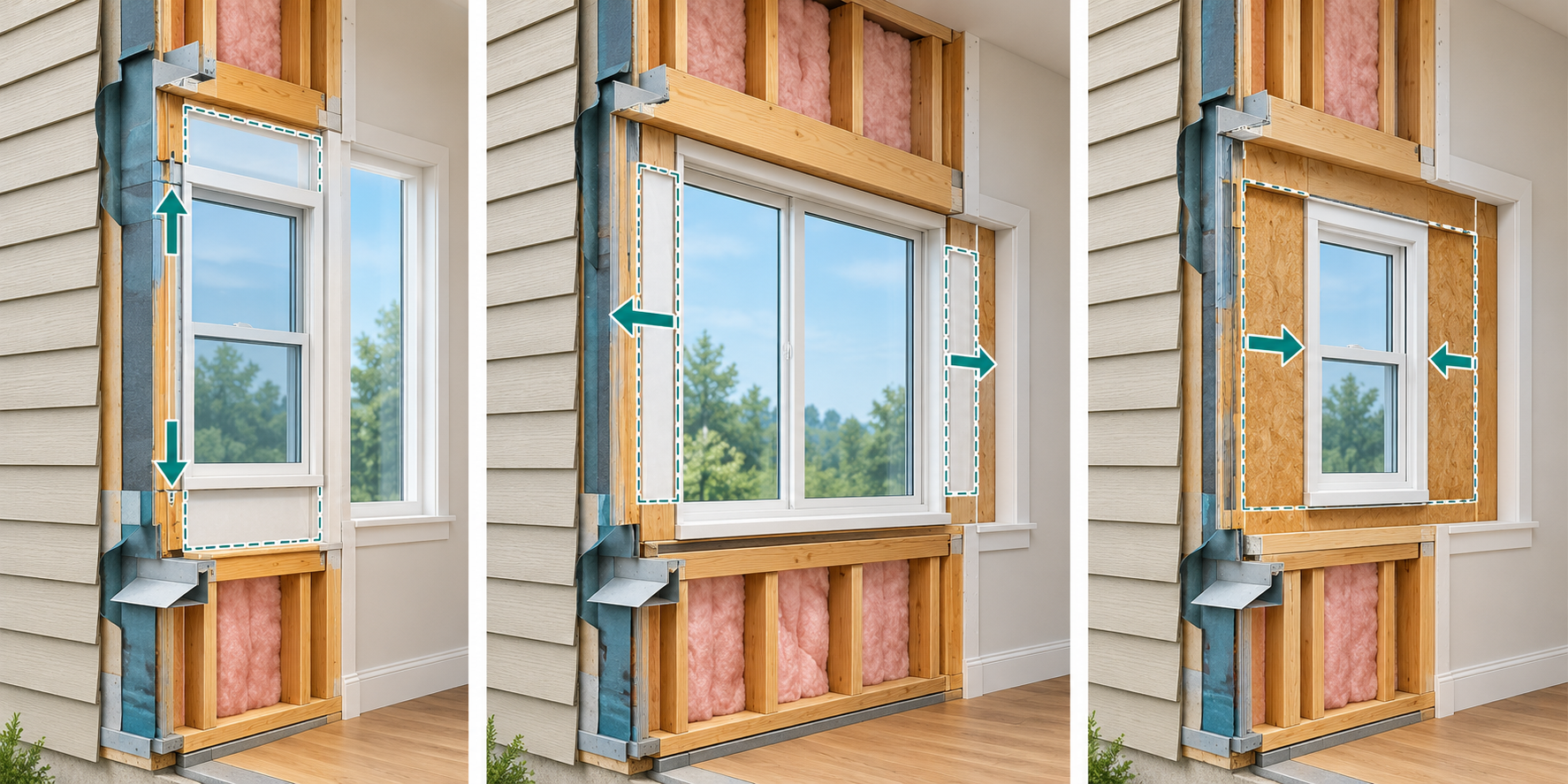

Define the geometry and wall before pricing
“Resize” can mean raising or lowering a sill, widening or narrowing the opening, changing its shape, or relocating part of the assembly. A small height change can have a different consequence from removing a wall segment across several studs. Reducing an opening still requires a durable infill, insulation, air-control transition, exterior water management, and interior and exterior finish matching.
Record the existing and proposed rough-opening dimensions, wall construction, nearby openings, floor and roof framing, cladding, utilities, room use, and access. A framed wall, masonry wall, and wall with a complex drainage or insulation assembly create different demolition and restoration work. The existing window’s header is not proof that a larger opening is safe.
Scenario-based budgeting
A straightforward vertical adjustment may include temporary protection, a new window, limited framing, flashing, cladding patching, interior finish, and disposal. A width change may require more extensive temporary support, header or post work, utility relocation, and restoration. A reduction may be structurally simpler but can demand careful air, moisture, insulation, and finish continuity. Masonry cutting adds equipment, dust control, support, and matching work.
Complexity increases with upper-floor access, unusual products, structural walls, brick or stucco, deep finishes, active water damage, older materials, and egress or accessibility goals. Separate the base product from framing, structural design, temporary support, flashing, cladding, drywall, trim, paint, utilities, access, disposal, permits, inspections, and conditional concealed work. This makes a changed-opening quote comparable with a like-for-like replacement only where the scopes actually overlap.
The opening must still manage water and air
Building America guidance treats sill or pan flashing, side flashing, head flashing, and the connection to the wall drainage plane as one water-management detail. Changing the geometry can invalidate an old perimeter detail. Ask how the new sill, jambs, head, air seal, insulation, and exterior finish will connect to the existing wall. If the contractor proposes only new perimeter sealant, ask what happens behind the trim and where water drains.
If the old opening leaked or had rot, the change is also an investigation opportunity. A new window in a resized opening can leave damaged sheathing or framing concealed unless the quote states what will be opened and repaired. Do not confuse a clean interior finish with proof that the wall transition is sound.
Egress, safety, and approvals
When a bedroom or basement escape route is affected, verify the current adopted requirement before choosing dimensions or hardware. The 2021 IRC provides model-code context for emergency escape and rescue openings, but local U.S. adoption and amendments control. Canada’s national code is a model framework; provincial, territorial, and local authorities determine application. Safety glazing, opening controls, guards, permits, and inspections can depend on project facts.
Structural and code claims require project-specific qualified review. Do not assume that a smaller opening avoids all approval or that a larger opening is allowed because a similar house has one. Ask who provides the structural design, who submits documents, who coordinates inspections, and whether those services are included or only recommended.
When another category becomes the dominant project
If the resize is one part of a major room conversion, addition, basement project, or whole-envelope repair, the opening remains an important line item but may no longer be the dominant economic decision. Coordinate the window scope with structural, cladding, remodeling, or enclosure work. Keep the cost of the actual opening visible so it is not lost inside a general construction allowance.
Older openings can contain lead paint, asbestos-suspect caulk or insulation, plaster, or other materials that require assessment before disturbance. EPA’s U.S. RRP guidance generally covers paid work disturbing paint in pre-1978 housing; Canadian guidance recommends checking older materials before renovation. Ask for the qualified work plan, containment, cleanup, and disposal responsibilities.
The best estimate shows the geometry, load-path responsibility, wall and finish assumptions, water-management detail, product, utilities, approval path, access, and discovery trigger. That is the only reliable way to compare a resized opening with a normal replacement price.
Ask for the existing and proposed rough-opening dimensions, wall construction assumption, structural scope, flashing detail, cladding and interior finish allowance, utility check, access, disposal, and approval responsibilities. Separate the base window price from conditional work discovered after demolition. A width change that requires major framing can become a remodeling or structural project; price it accordingly rather than comparing it with a replacement-window average.
