An egress window is an emergency-escape and rescue opening, not simply a large basement window. The project may include foundation cutting, temporary support, excavation, a window well, drainage, a ladder or steps where applicable, the window, waterproofing, interior finish, and inspection. Code applicability is high-consequence and must be checked locally before ordering.
Existing opening versus new basement opening
Replacing an existing opening may be comparatively narrow if the clear opening, operation, window condition, well, drainage, and surrounding foundation are already appropriate. A new or enlarged basement opening adds excavation, foundation modification, support, waterproofing, exterior restoration, and often a much broader finish scope.

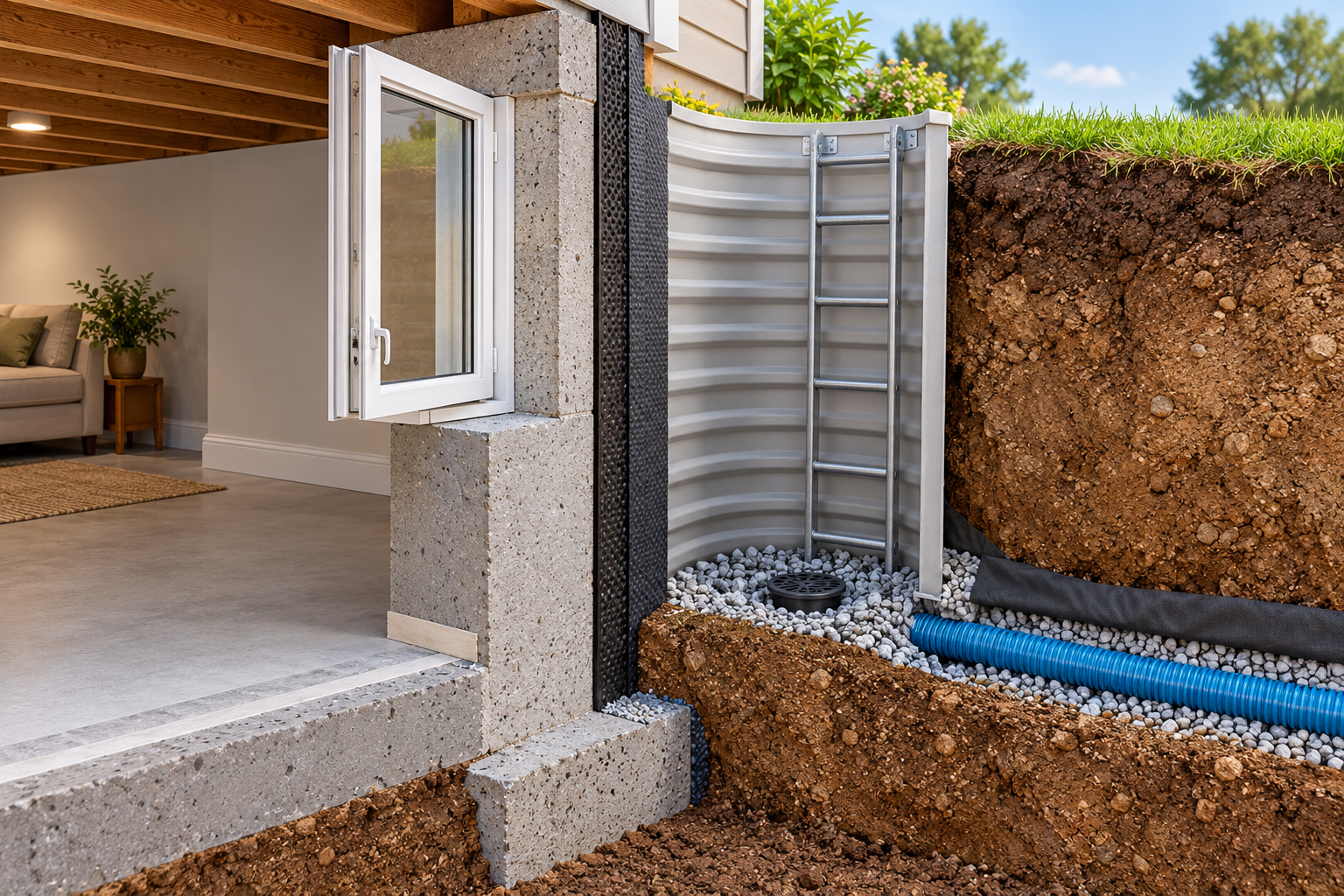

The window well is part of the escape path and the water-management system. Soil, groundwater, foundation drainage, access for equipment, retaining conditions, and the location of utilities can change the work substantially. Do not treat a well as a decorative surround that can be added after the window is selected.
Model-code context, not a universal rule
The 2021 International Residential Code model material includes requirements for emergency escape and rescue openings, including operation, clear opening, below-grade area wells, drainage, and releasable covers or grilles. Its area-well example includes 9 square feet of horizontal area with at least 36-inch projection and width, and a ladder or steps example when the well is more than 44 inches deep. These figures are model-code context only; adopted U.S. rules, amendments, existing-building provisions, and permits can differ.
Canada’s National Building Code is a national model framework. The responsible provincial or territorial authority and local building department determine what applies. A British Columbia appeal decision illustrates that an escape window can also interact with opening-control and fall-protection considerations; it is not a Canada-wide rule. Verify the current code edition, room use, building type, sprinkler status, window operation, and authority interpretation.
Cost drivers
- window, frame, glazing, and hardware;
- excavation depth, soil, equipment access, spoil removal, and weather;
- foundation cutting, temporary support, structural design, and reinforcement;
- window well, cover or ladder, drainage, waterproofing, and backfill;
- flashing, cladding, insulation, air sealing, drywall, trim, and paint;
- permit documents, applications, inspections, and possible engineering;
- older-home hazard testing, containment, or qualified work.
There is no responsible universal egress-window price. Above-grade replacement, a shallow excavation, and a deep foundation cut are different projects. Ask for each scope separately and make the trigger for concealed work explicit.
Budget the escape route, not just the window
An egress project has two connected outcomes: the opening must work as an emergency escape and rescue route, and the basement or wall must remain protected from water. A window that meets a product description may still be wrong for the room if the clear opening, operation, well, cover, ladder, drainage, or local approval does not fit the project. These are safety questions, not features to trade away for a lower quote.
Start by documenting the existing condition. Measure the opening and well, note the foundation type, soil, groundwater, exterior grade, access for excavation equipment, drainage connection, utilities, and interior finish. Identify whether the work is a replacement, enlargement, or completely new opening. The difference determines whether the main cost is a window and well or a structural foundation project.
Typical project scenarios
A replacement in an existing compliant opening may involve the window, trim, seal, well cover, drainage, and inspection. An enlargement may add foundation cutting, temporary support, waterproofing, excavation, backfill, and interior restoration. A new basement egress opening may also require structural design, utility coordination, spoil removal, retaining work, and a new landing or path outside the well.
The well can be a major cost driver. Soil that is difficult to excavate, restricted equipment access, groundwater, a deep foundation, a damaged drain, or a need for a ladder or steps can move the project out of a simple installation range. A cover may protect the well but must not prevent the required inside operation. Ask the designer or authority how the specific cover, grille, ladder, drainage, and opening interact.
Separate base work from conditional work
Ask for separate lines for:
- design, structural review, permit documents, applications, and inspections;
- excavation, equipment, soil removal, shoring or temporary support, and backfill;
- foundation cutting, framing, reinforcement, waterproofing, and drainage;
- window, glazing, frame, sill, flashing, trim, and interior finish;
- well, ladder or steps, cover, grading, and connection to drainage;
- utility relocation, access limitations, weather protection, and disposal;
- older-home material testing, containment, cleanup, or qualified work.
This breakdown shows whether a low quote assumes easy soil, no utility conflicts, no concealed foundation damage, and basic finishes. It also makes it possible to compare a replacement within an existing opening with an excavation project without pretending that they are the same job.
Budget the whole escape route
The required result is an available escape opening and route, not merely a window that can be purchased. For an existing opening, verify the clear opening with the sash fully open and consider whether a screen, stop, guard, security device, or well cover changes how a person would get out. For a new basement opening, the estimate may also need excavation, foundation cutting, a window well, drainage, ladder or steps where required, and safe access from the room to the exterior.
The work often crosses several trades. The window contractor may install the unit, while an excavation or concrete contractor handles the foundation and a drainage contractor addresses water management. Interior finishing may be separate. Ask who coordinates the sequence, protects the home from weather and debris, and confirms that the final window opens and the route remains usable. A finished product photo does not establish that the completed opening meets the local requirement for that dwelling and room.
A simple scenario might reuse an appropriate opening and need only a compatible unit and limited finish repair. A more involved job can require well excavation, foundation modification, drainage changes, utility relocation, engineering, and restored landscaping or interior surfaces. These scope differences make a single generic per-window price misleading. Ask for the base work and each conditional element separately, including what discovery would trigger a change order.
Code requirements vary by jurisdiction and may depend on the building, room, work type, and adopted code edition. U.S. model-code dimensions and Canadian model-code provisions are reference points, not universal legal requirements. Confirm local adoption and the project’s exact requirements with the responsible authority or qualified professional before ordering. If a fall-prevention guard or opening-control device is also needed, verify that it does not prevent the required escape operation.
After installation, the homeowner should receive the product and permit records, any inspection result, operating instructions, and a clear explanation of how the well drains and stays accessible. Include ongoing well clearing or cover maintenance in the ownership plan; otherwise the route can become obstructed after the construction cost has been paid.
Ask who will document final measurements and operation for the inspection or handoff. A contractor’s installation record, permit closeout, and the authority’s inspection result are different documents. Keep them with the product instructions so a later homeowner or emergency responder can understand how the opening and any well cover operate.
For a basement project, ask whether the new well’s cover can be opened from inside, how leaves or snow will be cleared, and whether a ladder or steps remain usable. These details affect the ongoing function of the route and may influence the product and excavation scope. Confirm the exact requirements with the local authority; a generic well cover or ladder is not proof of approval.
A final budget should also include excavation spoil removal, landscaping restoration, and any exterior steps or grading disturbed by the well. Ask which party restores the yard and how drainage will be protected after the work.
What happens after the quote
Before excavation, confirm the proposed finished floor, clear opening, interior operation, exterior access, well drainage, waterproofing, and finish restoration. Ask who confirms the opening after installation and who coordinates the inspection. A project that is later discovered not to meet the intended escape function can cost more to correct than it would have cost to design correctly.
If the basement is being converted to a bedroom or living area, keep the egress scope coordinated with the larger remodel. A well may affect site drainage, grading, retaining, landscaping, or a walkway. Those related scopes can be separately owned, but their interfaces belong in the project budget.
Older materials can also change demolition. Ask about lead paint, asbestos-suspect materials, and the current local requirements for testing, containment, cleanup, and disposal. Do not infer a hazard from a date alone, but do not cut or remove suspect material without appropriate assessment.
The safest cost comparison is a local, project-specific one: define the emergency-escape outcome first, document the foundation and site assumptions, and make every structural, drainage, finish, and approval allowance visible. Before paying for a window, ask the contractor or designer to confirm the proposed clear opening, inside operation, well access, drainage, foundation and utility assumptions, finish restoration, permit path, and inspection responsibility. If the opening serves a bedroom, do not rely on a product listing or generic dimension as approval.
