A heat pump or mini-split can improve comfort and efficiency, but in a shared building it may affect electrical capacity, exterior appearance, structure, condensate drainage, noise, refrigerant lines, and common property. The owner may pay for the equipment while the association retains control over the wall, balcony, roof, facade, or electrical infrastructure.
Treat the proposal as a building-system alteration, not only an appliance purchase.
Define every component

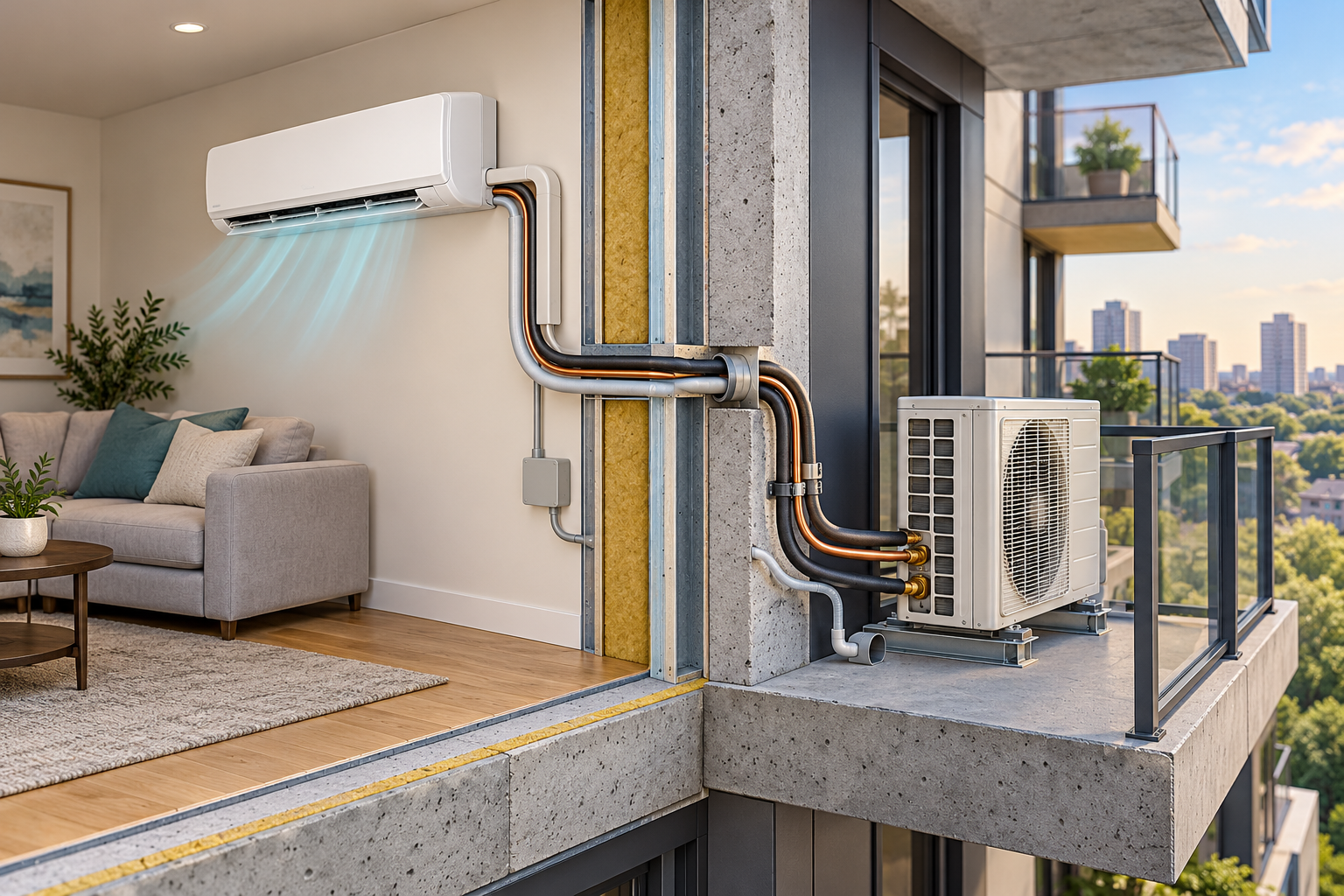

Describe the indoor unit, outdoor unit, line set, condensate route, electrical circuit, disconnect, supports, penetrations, controls, and service access. State whether equipment sits in the unit, on a balcony, in a mechanical room, on a roof, or on common exterior property.
Confirm whether the unit is a condominium, co-op, strata, or HOA townhouse and locate the declaration, bylaws, rules, architectural standards, alteration agreement, and maintenance matrix. Check the status of the balcony, roof, exterior wall, and parking or mechanical area before selecting equipment.
Review capacity and building impacts
A qualified HVAC professional and electrician should assess heating and cooling load, electrical capacity, refrigerant route, condensate disposal, drainage, vibration, and noise. The building may require an engineer to approve anchors, penetrations, waterproofing, or facade attachments.
Ask whether the system affects a shared riser, panel, meter, ventilation system, fire separation, or emergency access. A portable unit may have few approval impacts; a permanently mounted condenser can affect multiple common systems.
Approval and permit package
The association may require:
- product data and a location drawing;
- load calculations and electrical plans;
- structural or envelope details;
- sound and vibration information;
- contractor licensing and insurance;
- permits and inspection plan;
- access, shutdown, and protection plan;
- maintenance and removal agreement.
Do not order equipment or make a penetration before written approval. The approval should identify the allowed model and location, exterior finish, condensate treatment, service access, construction hours, and conditions for restoring the common element.
Allocate installation and future responsibility
Separate the budget into design, association review, permits, equipment, electrical work, line-set installation, supports, waterproofing, access, testing, and restoration. The owner may pay all dedicated work, while the association may require a shared-system review or contribution for common infrastructure.
The agreement should say who repairs the equipment, replaces it, maintains filters and drains, pays electricity, removes it for facade or roof work, and restores holes after removal. An approved alteration may remain an owner obligation even when it is attached to common property.
Condensate, water, and safety
Improper condensate drainage can damage a unit or common wall. Specify the drain route, overflow protection, testing, and maintenance access. If water appears, shut down the system if safe, notify the manager, photograph the source, and arrange qualified inspection.
Refrigerant, electrical, structural, and fire-separation work should be done by qualified professionals. Preserve permit records, test results, commissioning data, warranty terms, and photographs of concealed work.
Insurance and future work
Ask whether the association’s policy or the owner’s policy treats the unit, equipment, attachments, and resulting damage differently. A policy may cover a sudden event without covering an installation defect or ordinary maintenance.
A future facade, roof, balcony, window, or waterproofing project may require temporary removal. The approval agreement should state who pays, how much notice is given, and whether reinstatement must meet a new standard. Ask what happens if the association later adopts a centralized system.
Heat-pump checklist
- Identify ownership and the common property affected.
- Obtain HVAC, electrical, structural, and envelope advice as needed.
- Confirm approvals and public permits.
- Define location, sound, drainage, penetrations, and protection.
- Allocate installation, electricity, maintenance, repairs, removal, and reinstatement.
- Address insurance and damage.
- Preserve approval, permits, testing, warranties, and service records.
The key question is not whether a heat pump is efficient. It is whether the proposal has a complete approval, capacity, access, cost, and future-maintenance plan that protects both the unit and the shared building.
Compare designs before approval
A suitable heat pump can still conflict with a building rule if it exceeds a noise limit, blocks a walkway, overloads a circuit, or drains condensate onto common property. Before paying a deposit, compare the proposed location with the association’s approved standards and ask whether a portable unit, a different location, a shared project, or a central system is feasible. Compare the full cost of electrical work, supports, penetrations, drainage, sound control, access, maintenance, and future removal.
The application should show equipment location and clearances, line-set and condensate routes, electrical load, mounting and waterproofing details, sound information, contractor credentials, permits, and work schedule. If several owners are proposing equipment, a common specification can reduce repeated design and inconsistent exterior work while preserving each owner’s separate electricity, service, repair, and replacement duties.
Operation and closeout
The written agreement should assign filter and drain service, professional maintenance, electricity measurement, emergency shutoff access, leak or vibration response, future removal, and reinstatement. Require commissioning checks for heating and cooling, condensate drainage, controls, electrical protection, vibration, weather sealing, and penetrations. Photograph concealed insulation and fire stopping before closure.
Keep one file with the approved plans, permit and inspection records, test results, equipment model, warranty, maintenance schedule, photographs, and removal conditions. Confirm at handover that the unit operates as approved, the drain and controls work, labels are visible, and the common surface is restored. Give the file to a buyer and retain the association’s records for common penetrations and future facade or roof access.
Example: a balcony condenser
Before placing an outdoor condenser on an exclusive-use balcony, confirm whether the balcony, slab, and facade are common property and obtain qualified review of loads, vibration, electrical capacity, line routing, and condensate. A contractor quote that omits those items is not a complete project price. The approval should name the unit, location, drain, penetrations, insurance, service, and removal terms.
If approval is denied or conditioned, ask whether the concern is capacity, noise, envelope, structure, appearance, drainage, or future access. A revised proposal should address the stated concern and update cost and maintenance terms. Keep the final approval and service record with the unit so a later owner can maintain or remove the equipment safely.
