How Much Does an Above-Ground Pool Cost to Install?

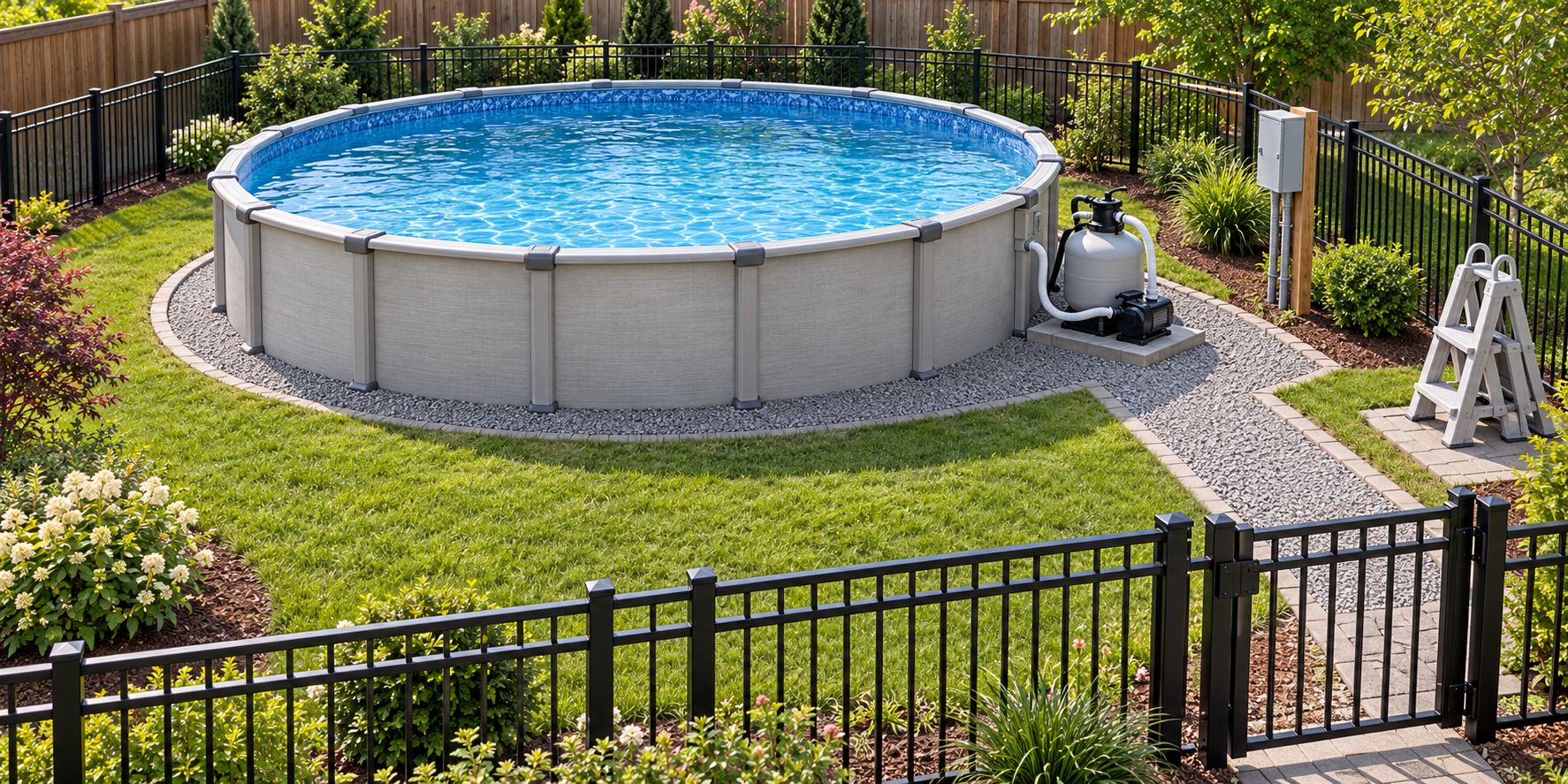

An above-ground pool can look like a product purchase, but the installed project may include base preparation, assembly, equipment, electrical work, steps, barriers, decking, and eventual removal or replacement.
Package price versus installed cost
The HomeAdvisor market observation used for this category reports a U.S. above-ground pool range of $1,000–$6,000. That is a consumer-market signal, not a guaranteed installed total. Package and installation scopes differ, and the source identifies site preparation, equipment, fencing or enclosure, and other work as potentially separate.
Budget separately for:
- a level, stable base and removal of unsuitable soil or old surfaces;
- the pool package, liner, pump, filter, fittings, ladder, or steps;
- delivery, assembly, and access to the yard;
- electrical supply and any required outdoor protection;
- a barrier, gate, or access-control arrangement;
- decking, stairs, drainage, landscaping, and restoration;
- winter storage, seasonal closing, replacement, or removal if the pool is temporary.
Why site preparation matters
An above-ground structure still needs a suitable base. Slope, drainage, soft or expansive soil, tree roots, retaining conditions, and the condition of an existing patio can change the preparation scope. Do not assume that a retailer package includes excavation, grading, base construction, or disposal.
Equipment and electrical work
The pump and filter may be included in a package, but installation still needs to match the pool, flow path, controls, and available electrical supply. Have electrical work assessed by a qualified professional. A pool article can help you budget the prerequisite; an independent service, circuit, panel, or bonding project belongs in the appropriate electrical scope.
Access and barriers
The CPSC guidance treats above-ground pool walls as a possible part of a barrier only in some configurations. Ladders and steps may need to be secured, locked, removed, or surrounded by a separate barrier. The guidance is not mandatory law by itself. Confirm the current local requirement for the pool, yard, gate, and access method before ordering equipment.
Seasonal and replacement economics
Seasonal pools may have lower initial scope but more recurring handling, storage, liner, and replacement exposure. A permanent above-ground or onground installation can add a more substantial base, deck, barrier, and equipment arrangement. Ask the installer to price the first season, seasonal service, and likely future replacement items rather than comparing only the package price.
Quote checklist
Ask whether the price includes delivery, assembly, base work, liner, pump, filter, electrical, barrier, ladder or steps, water, startup, taxes, and cleanup. Confirm who obtains permits or approvals and what happens if the base or surrounding ground is unsuitable.
Separate the project into installation patterns
The same product can produce very different budgets depending on how it will be used. A temporary seasonal pool may need delivery, leveling, assembly, a pump and filter, an access arrangement, opening and removal, and storage or disposal. A permanent above-ground or onground installation may need a more durable base, retaining or drainage work, a surrounding deck, a dedicated barrier, utility work, and a plan for winter conditions.
Ask the seller or installer to state which pattern the price assumes. “Installed” may mean assembled on an existing prepared pad; it may not mean that the contractor will correct slope, remove unsuitable material, build a retaining structure, connect a new circuit, install a barrier, or restore the landscape. Those are separate decisions with separate risk.
Site scenarios that change the quote
An open, level yard with a suitable base and short delivery route is the simplest case. A sloped yard may require excavation, a retaining solution, or a raised structural arrangement. Soft soil, roots, standing water, or an old patio can make a seemingly small base project a drainage or ground-preparation project. Do not bury those possibilities in an unexplained contingency; ask what condition would trigger extra work and how it would be priced.
Access matters after purchase as well as at delivery. The installer may need room for the pool package, base material, equipment, and a way to remove spoils or an old structure. Fences, gates, landscaping, overhead lines, and neighboring property can control the route. If a crane, lift, or temporary removal is possible, price it before committing to a model.
Equipment, water, and utility questions
Confirm whether the pump, filter, liner, ladder, steps, hoses, fittings, and controls are included and whether they are appropriate for the selected pool. A package that includes equipment is not necessarily a complete equipment installation. Ask about the outlet or circuit, weather protection, bonding or grounding where applicable, and the professional responsible for the electrical work. Do not treat a household extension-cord arrangement as a substitute for a compliant pool installation.
Water and startup are easy to overlook. Identify who supplies the initial water, who handles testing and startup, and whether cleanup or initial treatment is included. If the pool will be closed seasonally, ask what must be removed, protected, stored, or replaced each year. A lower purchase price may be offset by repeated handling, liner exposure, base repairs, or earlier replacement.
Compare ownership choices, not only package prices
Use a short comparison that includes the first-season delivered and operating cost; base, drainage, access, and barrier work; equipment, water, startup, and seasonal service; likely removal, storage, liner, or replacement obligations; and the cost and disruption of changing to a permanent installation later.
An above-ground pool can be a sensible fit when the owner wants a smaller initial commitment or a seasonal option. It may be a poor fit when the site needs substantial retaining, the owner expects permanent decking and utility upgrades, or local safety requirements make the installation much more involved than the package suggests.
What to document before approval
Have the installer mark the pool location, base limits, equipment location, access route, drainage assumptions, barrier arrangement, and restoration responsibility. Request model information and warranty terms, including what happens if the base settles or the liner is damaged during installation. Confirm permit or approval responsibility with the local authority, because the CPSC material is safety guidance and does not decide local law.
Decide whether the installation is seasonal or permanent
The most important budget distinction is often not the pool brand but the intended installation pattern. A temporary seasonal pool may be removed or protected each year, while a permanent above-ground or onground pool may need a durable base, retaining work, a deck, a dedicated barrier, equipment protection, and a longer-term drainage plan. Ask the installer to describe the pattern assumed by the price and which elements will be reused or replaced each season.
Base work deserves a measured scope. Confirm how level is established, what material is removed or added, how water drains away, whether roots or soft soil are present, and whether a retaining or structural solution is needed. A package price that assumes an existing level pad should not be compared with an installed quote that includes grading and disposal. If the base settles or the liner is damaged, ask which warranty covers the condition and what documentation is required.
Safety access should be reviewed with the complete yard. Identify doors, gates, ladders, steps, decks, neighboring fences, and the route a child could use to reach the water. CPSC guidance is reference material, not a substitute for local requirements. Confirm the current rule with the authority having jurisdiction and put the intended barrier, gate, cover, alarm, or removable-access arrangement in the plan.
Equipment and seasonal operation add recurring decisions. State who supplies water, startup testing, opening, closing, storage, winter protection, filter or liner replacement, and removal. If a new circuit, grounding or bonding review, or other electrical work is needed, identify the qualified professional and local approval responsibility. Do not treat a package’s included pump as proof that the complete utility installation is included.
Before approval, compare delivery, assembly, base, equipment, access, barrier, water, startup, seasonal service, removal, restoration, and warranty on the same basis. Keep Canadian pricing local and in CAD.
Plan the first season and the next one
The delivered installation should include a clear handoff for startup, water, equipment, liner, ladder or steps, cover or barrier, opening, closing, storage, and winter protection. Retain the base and drainage assumptions, delivery route, model and warranty, and any photographs of the prepared site. If the pool is seasonal, record how it will be removed or protected and which parts are expected to be replaced over time.
If settling, liner movement, drainage, or equipment problems appear, the original installation record helps identify whether the issue relates to the base, product, weather, or later maintenance. It does not replace a qualified assessment. Keep local safety and electrical requirements tied to the jurisdiction and retain Canadian prices in CAD.
Key points
- A pool package is not the same as a complete installed project.
- Leveling, drainage, access, electrical work, and barriers can dominate the add-on cost.
- CPSC guidance is useful safety context, not a substitute for local rules.
- Compare permanent and seasonal ownership costs before choosing the lowest package price.
