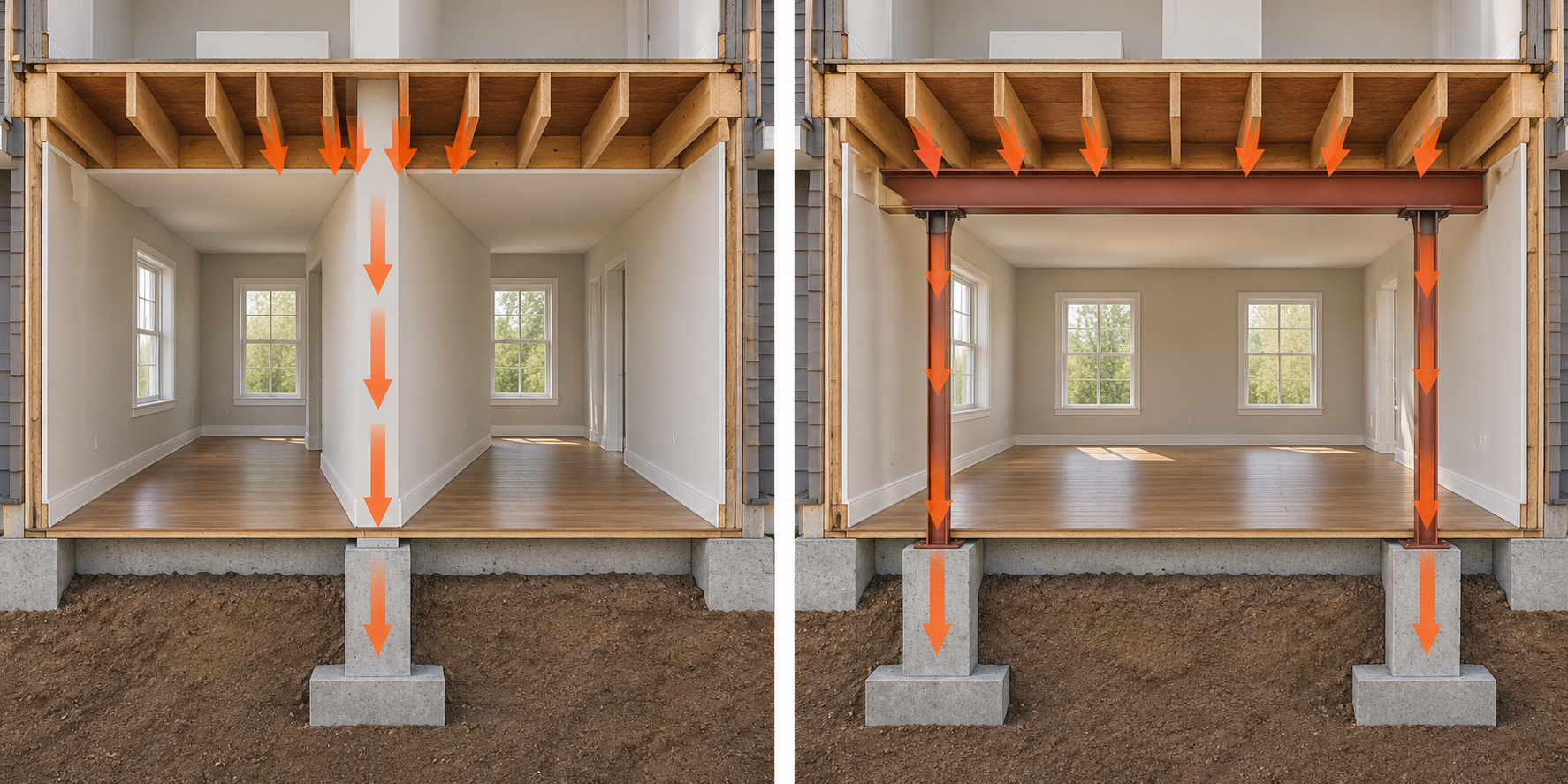

Budget a structural opening by including temporary support, replacement beams, bearing points, utilities, engineering, permits, and finish work.

On this page

Load-Bearing Wall Removal Cost

US planning budgets are often $5,000–$15,000 for a straightforward opening, $10,000–$30,000 for a typical beam-and-post project, and $25,000–$60,000+ when new footings, utilities, difficult access, engineering, permits, or extensive finish restoration are involved. These are broad project allowances. Canadian owners should obtain local CAD quotes and confirm local requirements.

Demolition is only one line

Removing a load-bearing wall changes the load path. The project may require temporary support, a replacement beam, posts or columns, new bearing or footings, utility relocation, demolition, engineering, permits and inspections, drywall, flooring, trim, electrical, plumbing, HVAC, painting, disposal, and cleanup.

The wall’s role should be confirmed by a qualified professional. This article does not provide DIY demolition or temporary-support instructions. A wall that looks like a partition may support framing above, and an opening can affect the supports below.

Cost drivers

Span, floor and roof loads, beam material and depth, bearing-point location, post and footing requirements, access for handling, finished surfaces, utilities, floor levels, adjacent walls, engineering, permits, disposal, and restoration matter. A beam is not interchangeable with a wall; it may be deeper, exposed, or require a new post in a location that affects the room.

Scenarios

Short opening: Existing bearing points are suitable, utilities are limited, and finishes are straightforward. The price still needs design and temporary-support responsibility.

Typical open-plan project: A longer beam, posts, utility relocation, and finish buildback are included. Normalize the beam, bearings, utilities, permits, and restoration across bids.

Complex alteration: New footings, multiple floors, an upper wall, masonry, constrained access, or broad remodeling is involved. Use the remodeling category for the larger project while preserving the structural scope as a separate budget.

Quote checklist

Ask who verifies the wall, provides the design, handles temporary support, supplies the beam, prepares bearing points and footings, relocates utilities, obtains permits, restores finishes, and prices concealed conditions. “Wall removal” should never be compared with “beam installation” unless both include the same access and buildback.

Decide whether the opening is a structural project or a remodel package

If the goal is a single opening, isolate the beam, bearing, utility, permit, and finish scope. If the wall removal is one step in a kitchen, addition, or whole-floor remodel, the broader remodeling category may be the better project context, but the structural package should remain identifiable. This prevents a low demolition quote from being mistaken for a complete opening budget.

Compare the cost of a shorter opening, a post location change, or retaining part of the wall only if the design supports those alternatives. The best savings usually come from resolving utilities, access, and finish decisions before demolition—not from omitting temporary support or bearing work.

The proposal should follow the load path

Read the scope from the roof or floor above down to the new bearing points. Confirm whether the beam bears on existing framing, posts, columns, or new footings, and whether those points are included. Ask who protects the building while the wall is opened and who verifies the final connections. These are design and construction responsibilities, not steps for a homeowner to improvise.

Keep a base opening, expected utility work, and difficult-case allowance separate. A quote may rise when a drain, duct, electrical route, or finish cannot be moved as assumed. Decide in advance which changes require written approval. Over a longer ownership horizon, include future access to the beam, posts, and utilities; a low-cost opening that blocks service access can create repeat work.

Before signing a wall-removal quote

Normalize the opening width, beam and bearing design, posts or footings, temporary support, utilities, demolition, engineering, permits, disposal, and finish level. Ask what the floor or foundation below must do after the load is transferred. A proposal that ends at demolition is not a complete structural-opening budget.

If this is part of a larger remodel, keep the structural package identifiable while coordinating trades to avoid duplicate demolition. For a short horizon, a smaller opening may reduce disruption; for a long horizon, compare future access to the beam, posts, utilities, and finishes.

Budget the boundary between structure and remodeling

Ask whether the floor or roof above, supports below, utilities, and finishes are included. Separate engineering, temporary support, beam and bearings, posts or footings, demolition, utilities, and buildback. A lower demolition price is not a lower opening price if it leaves the new load path unpriced.

Compare opening size and post placement only after the structural design establishes viable options. This can reduce disruption and preserve usable space, but it should not be achieved by omitting support or permitting work.

A practical quote comparison

Put the opening size, loads above, beam, bearing points, posts, footings, temporary support, utilities, demolition, engineering, permits, disposal, and finish buildback into a common scope. Ask what the lower floor or foundation must receive after the wall is removed. This is where a seemingly simple opening often changes price.

If the opening is part of a renovation, coordinate trades but keep the structural total identifiable. A smaller opening or different post location can reduce cost only if the design and intended room use remain acceptable. Savings should come from scope coordination, not omitted support.

The opening creates several smaller projects

Removing a load-bearing wall may require a new beam, posts, point-load support, temporary shoring, footing work, utility relocation, permits, and restoration on both sides. The opening width and the loads above matter, but access and the desired finished opening can change the total just as much. A flush beam, dropped beam, or post arrangement can have different framing and finish consequences.

Before comparing bids, mark the exact wall length, opening, ceiling condition, floor below, plumbing and electrical routes, and finishes to be retained. Ask whether the price includes design, permit handling, shoring, beam delivery, posts, footings, drywall, flooring, trim, paint, and final inspection. If a quote excludes remodeling, compare structural totals separately from the finished-room package. The economic choice is often a layout and disruption decision as much as a demolition price.

Decide the finished opening before pricing the beam

The structural design may allow more than one usable arrangement: a shorter opening, a beam below the ceiling, a flush condition, posts at different locations, or a retained section of wall. Those choices can change beam depth, bearing, footings, utilities, headroom, sight lines, and finish work. Do not treat them as interchangeable cost options until the responsible design establishes which are viable for the actual loads and supports.

The quote should identify the exact opening, what remains above and below it, and which surfaces are being restored. A beam installation may be structurally complete while the room still needs drywall, flooring, trim, paint, electrical relocation, or HVAC work. If the opening is part of a kitchen or whole-floor remodel, coordinate the trades but keep the structural package identifiable so demolition and finish allowances are not counted twice or omitted.

Use approval thresholds for hidden utilities and bearing

Before demolition, agree on how the contractor will document utilities, concealed framing, support below, and discovered conditions. A drain, duct, cable, or post location can alter the design and schedule. A measurable allowance and written approval threshold protect the budget better than an unexplained contingency. For long-term ownership, include future access to the beam, posts, and services; for short-term ownership, compare disruption and residual finish work without reducing the structural scope.

Price the opening as a finished load path

The wall removal is complete only when loads are transferred to the new beam, posts, bearings, footings, or retained wall and the room is restored to its intended use. Ask whether the proposal includes temporary support, beam handling, connections, lower-floor support, utilities, permits, inspections, drywall, flooring, trim, paint, and cleanup. A demolition-only line is not comparable with a finished structural opening.

The design may allow choices about opening width, beam depth, flush or dropped placement, post locations, or retaining a short wall segment. Those choices can change headroom, circulation, cabinets, utilities, and finish work. Compare only options that the responsible design accepts, and keep the finished-room consequences visible. A lower structural price may create a higher remodeling cost if it forces a different layout.

For long-term ownership, include access to the beam, posts, and services and preserve the design and inspection record. For short-term ownership, compare disruption and residual finish work without omitting temporary support or bearing. The homeowner is approving a changed load path, not simply paying for wall demolition.

Set approval points before the wall is opened

The discovery process can reveal hidden posts, doubled framing, utilities, an unexpected beam, or a lower support that does not match the assumed layout. Ask for a pre-demolition verification, a temporary-support plan, and a written rule for changing the beam, post, footing, or opening size. A measured change process is more useful than a broad “as needed” allowance because it connects added cost to a specific load-path finding.

The finished result should also state what is not included. Cabinets, flooring, ceilings, sprinklers, electrical, plumbing, HVAC, paint, and architectural redesign may sit outside the structural contract. For long-term ownership, keep the approved design and inspection record accessible. For short-term ownership, document the finished support and residual remodeling work. This keeps a lower demolition number from disguising an incomplete opening project.
