Bowing Foundation Wall Repair Cost
US planning allowances often fall around $3,000–$15,000 for limited reinforcement, $8,000–$30,000 for a longer wall with anchors or tiebacks, and $20,000–$75,000+ for straightening, excavation, shoring, or reconstruction. Masonry, access, finish removal, and drainage can move the total outside those bands. Canadian homeowners need independent local CAD quotes.
Why lateral movement has its own cost model
A wall that bows, leans, bulges, or develops a lateral crack is responding to loads from soil, water, frost, framing, or another condition. The repair decision is not simply “fill the crack.” It is whether to stabilize the wall in its current position, pull it closer to a desired line, or rebuild enough of it to restore the system.
Poured concrete and block or masonry walls behave differently, and the accessible side matters. A basement wall finished on the inside may require demolition. An exterior repair may require excavation, protection of utilities, backfill, and landscape or hardscape restoration. The structural assessment—not the product label—sets the relevant path.

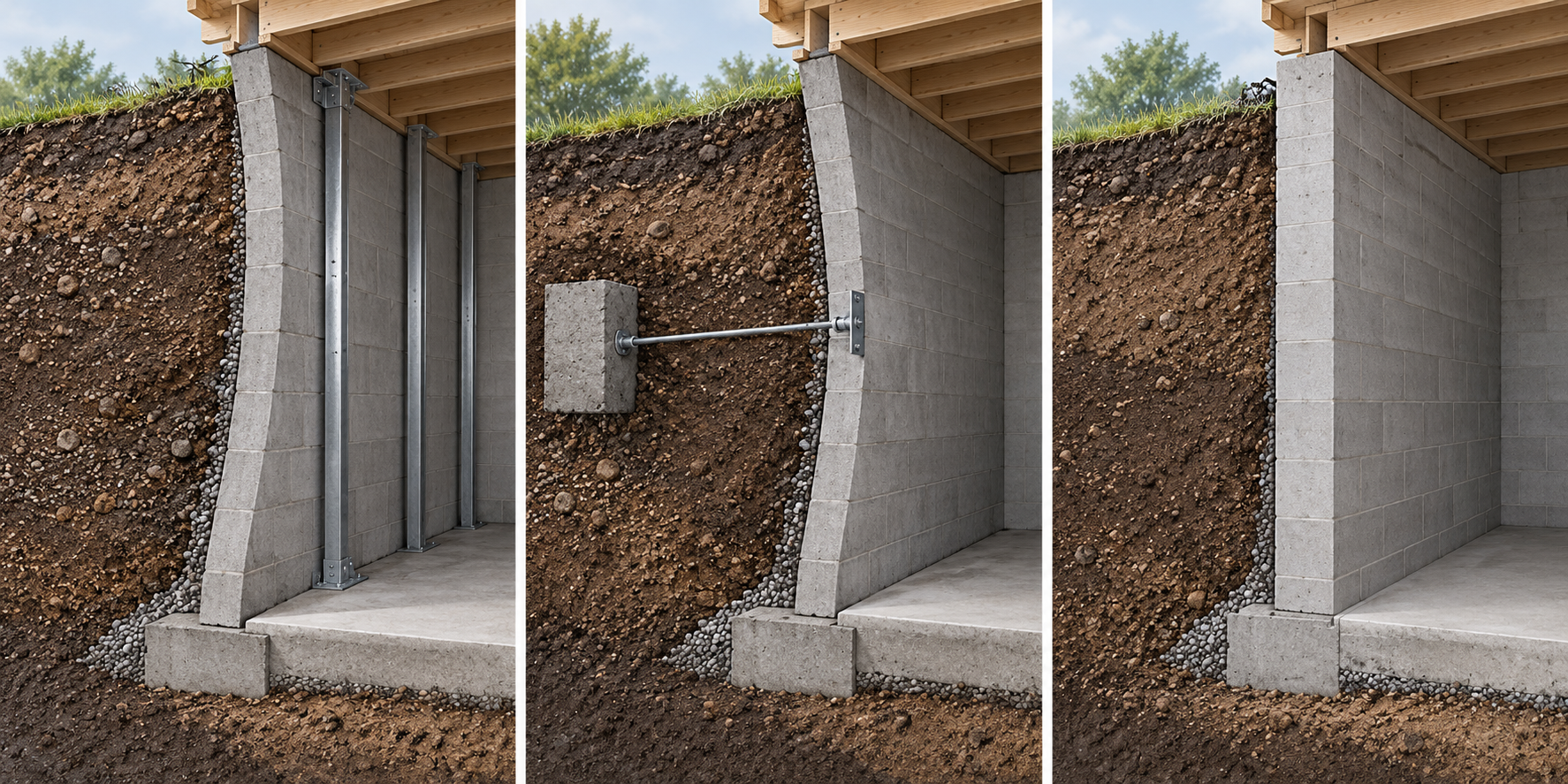

Reinforce, anchor, straighten, or rebuild
Reinforcement adds resistance while generally leaving the wall where it is. Carbon-fiber-type systems, steel members, or other reinforcement may have different preparation, finish, and design requirements. Anchors or tiebacks transfer lateral forces into soil or another resisting system and may require exterior access or suitable ground.
Straightening adds jacking, excavation, temporary support, and a controlled movement objective. It can increase disruption and the risk of cracking finishes or connected elements. Reconstruction is the largest scope and may include demolition, shoring, removal, new wall work, waterproofing or drainage coordination, and restoration.
Price drivers
Wall length and displacement matter, but the expensive interactions are usually access, excavation, soil, groundwater, bracing, wall material, utilities, and finishes. A short wall behind a finished basement can be harder than a longer exposed wall. A proposal that includes drainage correction is solving a different scope from one that only reinforces concrete.
Engineering, permits, inspections, disposal, temporary support, and post-repair monitoring may be separate. Ask whether the quote is for one wall face, a corner, an entire elevation, or connected walls. A corner or return can change the load path and the amount of work.
Scenario budget
Focused stabilization: The wall is accessible, movement is bounded, and a defined reinforcement system is appropriate. Budget for preparation and finish repair, not just the reinforcing material.
Typical lateral repair: Several reinforcement points or anchors, interior opening, exterior access, and a root-cause allowance are involved. Compare included wall length and the treatment of concealed deterioration.
Difficult wall: The wall is significantly displaced, connected framing is affected, excavation is constrained, or the repair includes straightening or rebuilding. Stabilization and reconstruction should be priced as separate options where both are viable.
Read the proposal carefully
Ask for the observed movement, proposed outcome, wall length and material, system count, excavation and shoring, engineering, permits, drainage exclusions, waterproofing, finish restoration, monitoring, warranty, and concealed-condition unit prices. Do not treat a manufacturer’s system description as proof that it applies to this wall or is categorically better.
External drainage and grading belong to site and below-grade-water scopes, although they may be prerequisites. If the quote says “water pressure” or “soil pressure,” ask what corrective work is included and what remains outside the contract.
The economically meaningful comparison is stabilize versus straighten versus rebuild, with the residual condition and recurrence risk made visible. The lowest first price may not be the lowest project cost if it leaves the wall displaced or the pressure source unresolved.
Separate the visible wall from the pressure source
Ask whether soil pressure, groundwater, frost, a grading condition, or movement at a connected foundation is included in the diagnosis. If the proposal calls for exterior excavation, compare the cost of access, backfill, drainage, and surface restoration with an interior reinforcement option. Neither option should quietly assume that the other contractor will correct the cause.
For a longer ownership horizon, include inspection or monitoring, future access to the wall, and the cost of repairing finishes after a later intervention. For a short horizon, a documented stabilization may be rational even when straightening would improve geometry, provided the remaining condition and exclusions are understood. The decision is not resolved by comparing product prices alone.
Evaluate stabilization as an ownership choice
A wall reinforcement may preserve the wall’s position, while straightening may change geometry and disturb more finishes. Ask what each option leaves in place, how water or soil pressure is addressed, and how the result is monitored. If a proposal excludes excavation or drainage, record that the structural price is not a complete site correction.
Use the same wall length, corners, access assumptions, system count, engineering, temporary support, finish restoration, and hidden-condition rule when comparing bids. A short-term budget may favor a bounded stabilization, while a long-term budget may favor a correction that reduces repeat access. Neither conclusion can be based on the material name alone.
Measure the wall condition before choosing a system
Height, length, displacement, cracking, moisture, soil pressure, access, and the presence of floors or framing bearing on the wall all change the repair. Interior reinforcement can avoid excavation but may reduce usable space; exterior work can address drainage or pressure but adds excavation, landscaping, shoring, and restoration. Straightening adds a different level of intervention from stabilizing the wall in its current position.
Have the proposal identify the wall face, measured displacement or observed distress, support points, anchors or reinforcement, and the pressure or water conditions that remain. If the wall is part of a broader settlement or slope problem, a wall-only price may not be the project price. A credible quote explains which evidence would move the work from reinforcement to excavation, straightening, or reconstruction.
Wall material and location change the repair pathway
Poured concrete, concrete block, brick, and mixed foundation walls do not present the same repair surface or connection problem. A reinforcement system that fits one wall material may not transfer load in the same way on another. The height and length of the wall, corners and returns, openings, floors or framing bearing on it, and the condition of the footing can matter as much as the visible bow. Ask the bidder to identify those conditions rather than describing the wall only as “bowed.”
Access also changes the economic comparison. Interior reinforcement can reduce excavation and landscaping restoration but may consume basement space or leave the pressure source outside the contract. Exterior anchors or tiebacks may require drilling, easements, neighboring access, excavation, and restoration. Straightening adds temporary support and finish risk; rebuilding adds demolition and a new connection to the retained structure. Price those outcomes separately where they are viable.
Set a decision point for concealed wall conditions
Before work starts, agree on what will be documented if finishes are removed or soil is excavated: wall material and thickness, crack and displacement pattern, footing condition, groundwater, drainage, connected framing, utilities, and any inaccessible areas. A base scope can cover the confirmed wall length, while a unit price or approval threshold controls additional excavation, reinforcement points, masonry replacement, or finish restoration.
For a short ownership horizon, stabilization may be acceptable when the wall’s remaining position, drainage boundary, and monitoring expectations are clear. For a long horizon, a more disruptive correction may be worth considering if it reduces repeated access or leaves the wall easier to inspect. The choice should be tied to the condition left behind and the pressure source that remains, not to the brand or material name alone.
Ask how the proposed system interacts with the house
A foundation wall may support floor joists, bear a sill, retain soil beside a finished basement, or connect to a slab and exterior grade. Reinforcement, anchors, tiebacks, straightening, and reconstruction can affect those interfaces differently. Ask whether the proposal includes connected framing, wall openings, corners and returns, footing or bearing conditions, and the finish or waterproofing work needed after access. A wall-only price may be appropriate for a bounded scope, but it should not be mistaken for a whole-foundation correction.
The proposal should also identify the pressure or movement condition it assumes. Soil pressure, water, frost, drainage, slope, settlement, and construction defects can require different follow-on work. If the structural contractor is not correcting that cause, record who is and when the correction occurs. A warranty that excludes continuing movement can be honest while still changing the value of the reinforcement.
Use the ownership horizon to compare disruption with residual risk. A lower-disruption stabilization may preserve finishes and occupancy while leaving the wall displaced. A straighter or rebuilt wall may require more excavation and restoration while reducing the need for repeated access. The right budget is the option whose structural result, site dependencies, and remaining uncertainty are understandable.
