Project cost and decision guide

Compare vented and sealed or conditioned crawl-space approaches by moisture logic, drainage, ground-vapor control, equipment, climate, code review, and retrofit cost.

On this page

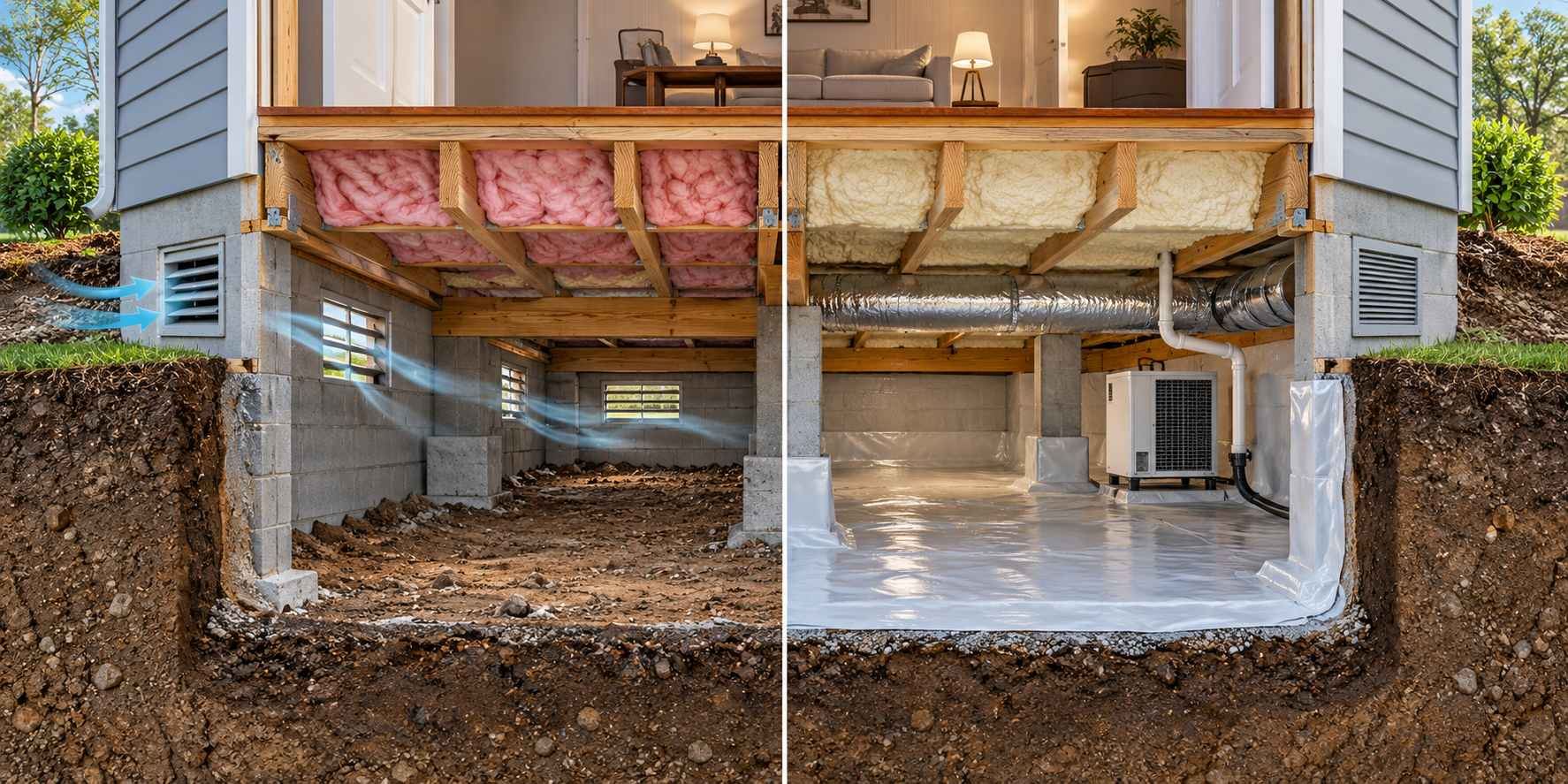

Vented vs. Sealed Crawl Space Retrofit Cost

Converting a crawl space from vented to sealed or conditioned changes the moisture and thermal strategy. It is not simply a matter of closing vents. The project may require ground-vapor control, air-sealing, drainage, conditioning or dehumidification, insulation coordination, and a local code review.

What the research shows—and does not show

DOE Building America reports 15%–18% lower heating and cooling energy use and more than 20% lower humidity for the conditioned crawl spaces in its research context. It also explains that humid outdoor air can worsen condensation in some vented spaces. Those findings are not a universal retrofit savings guarantee, a Canadian code rule, or a requirement to seal every crawl space.

Natural Resources Canada notes that exterior vents can increase summer condensation in some heated crawl spaces and that whole-house ventilation or dehumidification may be alternatives in the described context. Climate, existing insulation, ducts, plumbing, pests, and the proposed thermal boundary matter.

Cost layers

  • moisture diagnosis and standing-water correction;
  • ground cover, seams, wall and pier sealing;
  • vent, penetration, and air-sealing work;
  • dehumidifier, conditioning, condensate, controls, and power;
  • insulation changes and removal of wet material;
  • access, cleanup, structural, pest, mold, radon, or restoration work.

No comparable universal retrofit range is established. Ask the contractor to state the target configuration, moisture source, thermal boundary, equipment, code assumptions, and operating cost.

Decide what is changing

“Vented” and “sealed” are configuration descriptions, not complete project scopes. A retrofit may change the ground cover, wall and pier detailing, vents, air leakage, insulation, humidity control, ducts, plumbing protection, access door, or mechanical conditioning. Ask the contractor to draw the intended boundary and identify which existing materials will be removed, retained, or covered.

Begin with water. Standing water, groundwater, plumbing leakage, and exterior foundation entry should be investigated before changing the air strategy. DOE guidance describes soil as a source of liquid water or vapor and recommends continuous ground-cover detailing in relevant crawl-space configurations. NRCan discusses climate- and assembly-dependent choices and advises correcting leaks before crawl-space insulation. Neither source selects a universal retrofit for every property.

How the choices can affect the budget

A vented space may need ground-vapor control, drainage, insulation changes, pest or debris removal, and a strategy for humidity in the local climate. A sealed or conditioned space may add wall and pier attachment, vent treatment, access-door work, dehumidification, condensate, power, monitoring, and ongoing service. Neither option should be priced as one square-foot product.

The thermal boundary also matters. Moving insulation from the floor to the foundation walls can change ducts, pipes, access, air sealing, and future service. Wet insulation may need removal before any retrofit. If the space includes combustion equipment, mechanical systems, wiring, or plumbing, obtain the appropriate professional review rather than treating a general enclosure article as design instructions.

Compare by intended outcome

  • Control soil vapor: continuous ground cover and edge or penetration detailing address soil contact; they do not solve bulk water.
  • Control liquid water: grading, drainage, foundation work, collection, sump, and discharge address the water path.
  • Control air humidity: dehumidification or conditioning manages air moisture after the configuration supports it.
  • Improve energy or comfort: insulation and air-sealing work must fit the thermal boundary and building systems.

Ask what evidence will show that the outcome was achieved. A lower humidity reading does not prove that a wet joist, plumbing leak, or standing-water condition is corrected. A sealed liner does not prove that the space is ready for insulation. A vent change does not correct exterior water.

Retrofit scenarios

  • Limited ground-vapor work: clean, accessible space; no standing water; barrier and edge details are the main scope.
  • Moisture correction before enclosure: drainage, sump, discharge, wet-material removal, or exterior work precedes the air-strategy decision.
  • Full enclosure and conditioning: ground, walls, piers, vents, penetrations, access, equipment, controls, and maintenance are priced together.
  • Thermal-boundary retrofit: insulation, air sealing, ducts, pipes, wiring, and access are coordinated after moisture conditions are suitable.

Ask which scenario the quote represents, which items are optional, and what later work would require opening the enclosure.

Protect the long-term budget

Record the proposed configuration, equipment models, humidity target, power and condensate assumptions, maintenance, and service clearances. Keep pumps, alarms, cleanouts, valves, electrical equipment, and structural observations accessible. The most useful comparison is the one that explains the intended assembly, its operating cost, and the evidence needed before the next layer is installed.

How to compare a retrofit proposal

Ask the contractor to identify the existing air and thermal boundaries before describing the new one. Note whether insulation is at the floor or foundation walls, whether ducts and pipes are inside the intended conditioned space, and whether the access door, vents, and penetrations are part of the enclosure. A proposal that changes one component can affect several others.

Price removal and preparation separately. Wet insulation, debris, pests, damaged wood, sharp soil, inaccessible areas, and old liners can require labor before a new barrier or enclosure can be installed. Ask who disposes of material and what happens if a hidden condition is found. A low installation price can omit the preparation that makes the retrofit possible.

Sequence the work

Correct standing water and active leaks first. Then install ground-vapor control or drainage, establish the intended air strategy, and address humidity or conditioning equipment. Only after that should the final insulation or air-sealing scope be closed in. The sequence may be different for a specific assembly, so obtain the appropriate professional review when the thermal boundary or mechanical systems change.

Define a handoff between stages. It may require a functioning sump and discharge, dry or removed insulation, accessible utilities, a humidity observation, or a review after a wet event. If the evidence does not support a permanent decision, a documented temporary condition is safer than an enclosure that hides the uncertainty.

Long-term comparison

Compare not only installation totals but also electricity, maintenance, filters, condensate, pump testing, access, future repairs, and the cost of reopening the space. A sealed configuration may reduce some humidity exposure while adding equipment responsibility. A vented configuration may avoid equipment while leaving a climate-sensitive moisture question. The right choice is the complete assembly that fits the property and can be serviced.

Questions that make the choice specific

Ask what the retrofit is expected to improve, what condition must exist before it begins, and how the result will be checked. Ask whether the proposal changes the air boundary, thermal boundary, or both. Ask what happens to existing floor insulation, ducts, pipes, wiring, access, and combustion or mechanical equipment. These answers determine more of the budget than the word sealed or vented.

If the proposal depends on a dehumidifier, sump, or new drainage, list the equipment, power, condensate, discharge, testing, maintenance, and replacement cost. If it depends on insulation, list removal, preparation, installation, air sealing, and later service. The final decision should state which moisture conditions remain outside the retrofit.

The contractor should also state whether the proposed configuration depends on climate, season, soil condition, or an operating system. A sealed space that requires a dehumidifier has a continuing cost and a failure mode; a vented space that relies on outdoor air may have a different seasonal moisture risk. Ask how the choice fits the existing building rather than using a universal rule.

If the quote recommends both enclosure and insulation, make the order explicit. Correct leaks and bulk water first, complete ground and wall details, establish the air strategy, then install the thermal work when the space is ready. The handoff should include photographs and a statement of what remains outside scope.

Ask what the retrofit is expected to improve, what condition must exist before it begins, and how the result will be checked. The final comparison should include removal, preparation, equipment, operating cost, maintenance, and the cost of reopening the space if the source returns.

Record the selected configuration and the reason for rejecting the alternatives. That makes future changes to insulation, ventilation, drainage, or humidity equipment easier to evaluate. A retrofit is most defensible when its assumptions remain visible.

Include the operating and maintenance responsibility in that record. A later owner should be able to tell which equipment must run, which access must remain open, and what observation means the configuration needs review.
