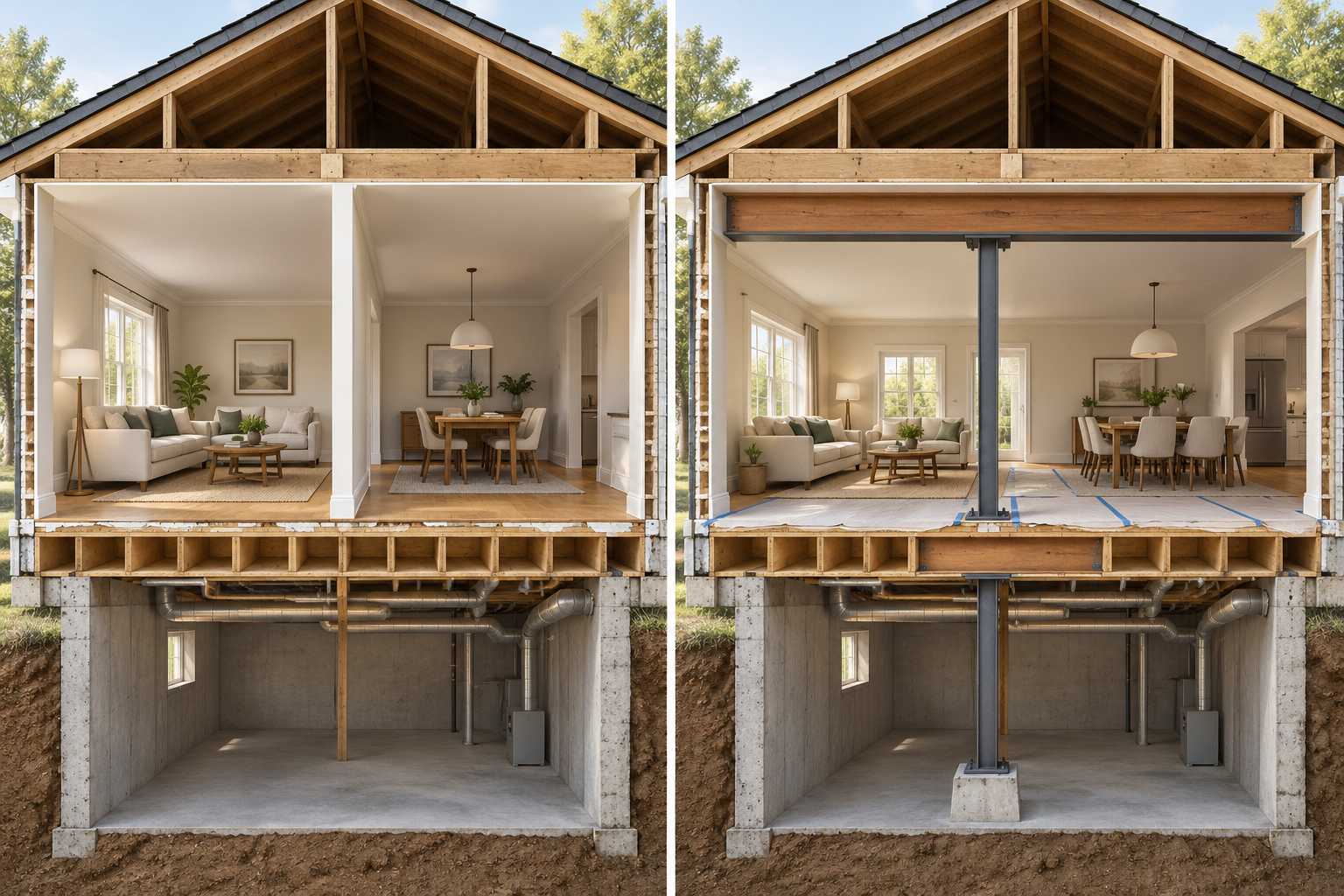

Load-Bearing Wall Removal for a Major Remodel: Cost and Scope
Removing or substantially opening a load-bearing wall changes how the building carries forces. The project budget is therefore not a demolition price. It can include assessment, design, temporary support, replacement structure, posts and loads below, foundation implications, utility relocation, finish restoration, engineering, permits, and inspections.
A cost worksheet, not a structural prescription
For illustration only, a homeowner might compare a $6,000 assessment and design allowance, $12,000 for controlled removal and temporary support, $18,000 for engineered replacement support, $8,000 for utility relocation, $12,000 for finish restoration, and $7,000 for professional, permit, and protection costs: $63,000 before concealed conditions. These are not market rates and do not size a beam, post, footing, or temporary support. The qualified designer and contractor must replace the allowances with a site-specific scope.
Why the span is not the answer
The required support depends on loads, spans, stories above, roof or floor framing, posts, bearing below, foundation, connections, and the existing building. Wall length alone cannot establish a safe design. Do not use this article to size a beam, post, footing, or temporary support.
The cost layers
Assessment and design: A qualified structural professional reviews the particular house and produces the necessary design. FEMA’s existing-building guidance is a reminder that age, configuration, site, and construction vary.
Temporary support and demolition: Contractor planning, temporary support, controlled removal, disposal, protection, and access. Temporary support is a professional construction operation, not a homeowner procedure.
Replacement support: Beam or other engineered system, posts, connections, fire or finish enclosure, and any load path or foundation work below. An apparently simple beam can create a point-load problem at the floor or foundation.
Utilities and finishes: Wiring, plumbing, ducts, gas, and ventilation may need rerouting. Finish work can include ceilings, floors, drywall, trim, paint, cabinets, and flooring continuity.
Approval: Permit and inspection requirements vary. In Canada, NRC explains that model codes require adoption and may be amended by the authority; model-code text is not proof of local law.
Smaller alternatives
Compare a partial opening, cased opening, or layout change if it solves the homeowner’s objective. The lower structural scope may also reduce utility and finish restoration, but it is not automatically suitable.
Quote checklist
Require the assessment and design scope, temporary support plan, replacement support, posts and below-support assumptions, utilities, demolition, finishes, engineering, permits, inspections, protection, and exclusions. Ask who is responsible for verifying conditions concealed before the wall is opened.
This is a high-consequence project. A complete quote and qualified design are more important than a confident number based on wall length.
What a credible proposal explains
The proposal should identify the existing wall, what it supports, the proposed opening, where forces transfer below, and which elements remain. It should distinguish assessment from design, and design from construction. If a contractor gives a beam-only price without describing posts, connections, below-support conditions, utilities, protection, and finishes, it is not a complete project price.
The quote should also state whether engineering or permit drawings are included, who submits them, and what happens if the authority requests a change. Local requirements differ, and a model code or a consumer cost guide cannot confirm the process in a particular city, state, province, or territory.
Why posts and foundations matter
A replacement support may concentrate forces at one or more points. Those points can land over a crawl space, basement, slab, beam, or foundation that was not designed for the new arrangement. The resulting work may include a new support, access opening, or structural correction below the room. This is why two openings of the same width can have very different budgets.
Utilities can create a second layer of uncertainty. Electrical wiring, plumbing, ducts, and fuel lines may need to be relocated before the wall is removed. Their routes may be concealed, and finish restoration may extend beyond the opening. Ask the contractor to distinguish confirmed routes from allowances.
Narrow opening versus full removal
A cased opening or partial opening can preserve some support and reduce finish disruption. It may also fail to deliver the intended sight line, circulation, or furniture layout. Price it as a real alternative, not as a presumed shortcut. A structural professional must still assess any remaining wall and the proposed support.
Repair and finish scope
Include demolition, disposal, dust protection, temporary partitions, structural enclosure, drywall, ceiling texture, flooring, trim, paint, cabinets, and electrical or lighting restoration. If the house has older plaster, tile, or continuous flooring, matching may be impossible; state whether the proposal replaces a larger connected area.
A decision test
Removal is easier to justify when it solves a defined circulation or functional problem and the structural and utility scope is known. It is harder to justify when the goal is only a larger visual opening, the existing layout can be improved without structural work, or the project would require extensive restoration in rooms that otherwise work well.
Do not approve work from an internet diagram or a quote that treats temporary support as an optional homeowner task. The safe economic comparison is a professionally assessed opening, a smaller opening, and a nonstructural layout alternative, each with complete restoration and approval assumptions.
What cannot be priced from a photograph
A photograph cannot show the full load path, concealed services, foundation condition, connection details, or local approval requirements. A contractor may provide an early planning allowance, but detailed pricing should follow assessment and design. Treat unusually confident promises based only on wall length as a reason to ask more questions.
After the wall is gone
The finished room may need new lighting, flooring, ceiling work, trim, paint, cabinetry, or HVAC balancing. Ask how the new support will be enclosed and maintained, and whether the remaining layout still provides practical circulation. The structural intervention is successful only when the complete room works.
Compare the opening with the support it creates
The apparent opening width is only one input. Posts, beams, bearing points, footings, ceiling depth, mechanical routes, and the ability to install temporary support can control the scope. Ask for the proposed load path and the locations that remain visible or need enclosure. The owner does not need to design the structure, but should be able to see what the proposal is carrying and restoring.
If a post remains, test whether it can align with cabinetry, a half-wall, or a useful furniture boundary. A smaller opening may preserve more ceiling and floor finish while delivering the desired connection. Price that alternative before treating full removal as the only meaningful option.
Treat the assessment as part of the project
The first paid step should establish what the wall supports and what must support the replacement. That may involve framing above, roof or floor loads, posts, beams, bearing points, lower floors, foundations, connections, and services. The purpose is to define the project, not to let a homeowner calculate a beam or temporary support. Existing-building guidance from FEMA is useful context for variability, but it does not design this opening.
Ask the professional to identify the assessed load path, the assumptions about what is above and below, and the conditions that require further investigation. If the design depends on opening a ceiling, exposing a foundation, relocating a duct, or moving plumbing, put those steps into the scope. A support that cannot reach a suitable bearing point may change the layout or the cost class.
Compare full removal with useful alternatives
Price a smaller opening, a widened doorway, a pass-through, a post-integrated opening, and complete removal only when the alternatives can satisfy the desired function. Use the same sight line, circulation, storage, lighting, and furniture goals. A smaller opening can preserve finishes and reduce support work; it can also fail if the household needs a truly connected route. Decide from the function rather than a preference for a particular opening width.
For every option, include assessment, design, temporary support, replacement structure, posts, foundation or lower-load work, utility relocation, demolition, disposal, ceiling and floor repair, cabinetry, trim, paint, engineering, permits, inspections, protection, and temporary living. A structural opening’s price is usually a bundle of support and restoration, not a wall-removal line.
Ask how the work will affect the lived-in home
Sequence the work around the home’s critical functions. Identify how the kitchen, bathroom, heating, electrical service, and main circulation will remain available, even if temporarily. The support solution may require a temporary wall, a staged opening, dust control, or moving furniture and appliances. Those measures are part of a realistic cost and schedule, not optional polish added after the structural price.
Before approving the opening, compare the finished sightline with the finished support. Posts, beams, dropped ceilings, and relocated ducts can change the room more than the removed wall did. A smaller opening or a carefully placed post may deliver most of the connection while preserving a cleaner service route and reducing the amount of work that must be hidden.
Identify where occupants will walk, cook, sleep, and store belongings while the opening is made. Temporary support, dust, noise, loss of a kitchen or room, and protection of floors and furniture may be material. Ask how the new support is enclosed or left visible, how maintenance access is retained, and how the finished ceiling and floor will be matched.
Proceed when the load path, professional design, approval path, utility conflicts, household disruption, and restoration are clear enough to request comparable bids. If those items remain unknown, a low price is only a price for an imagined opening. The safe economic decision is to resolve the structural question before choosing finishes or authorizing demolition.
