Additions, Conversions, ADUs and Major Remodeling Costs

Project cost and decision guide

Compare adding square footage with reorganizing existing rooms by weighing shell and site costs against structural, utility, finish, circulation, and disruption work.

On this page

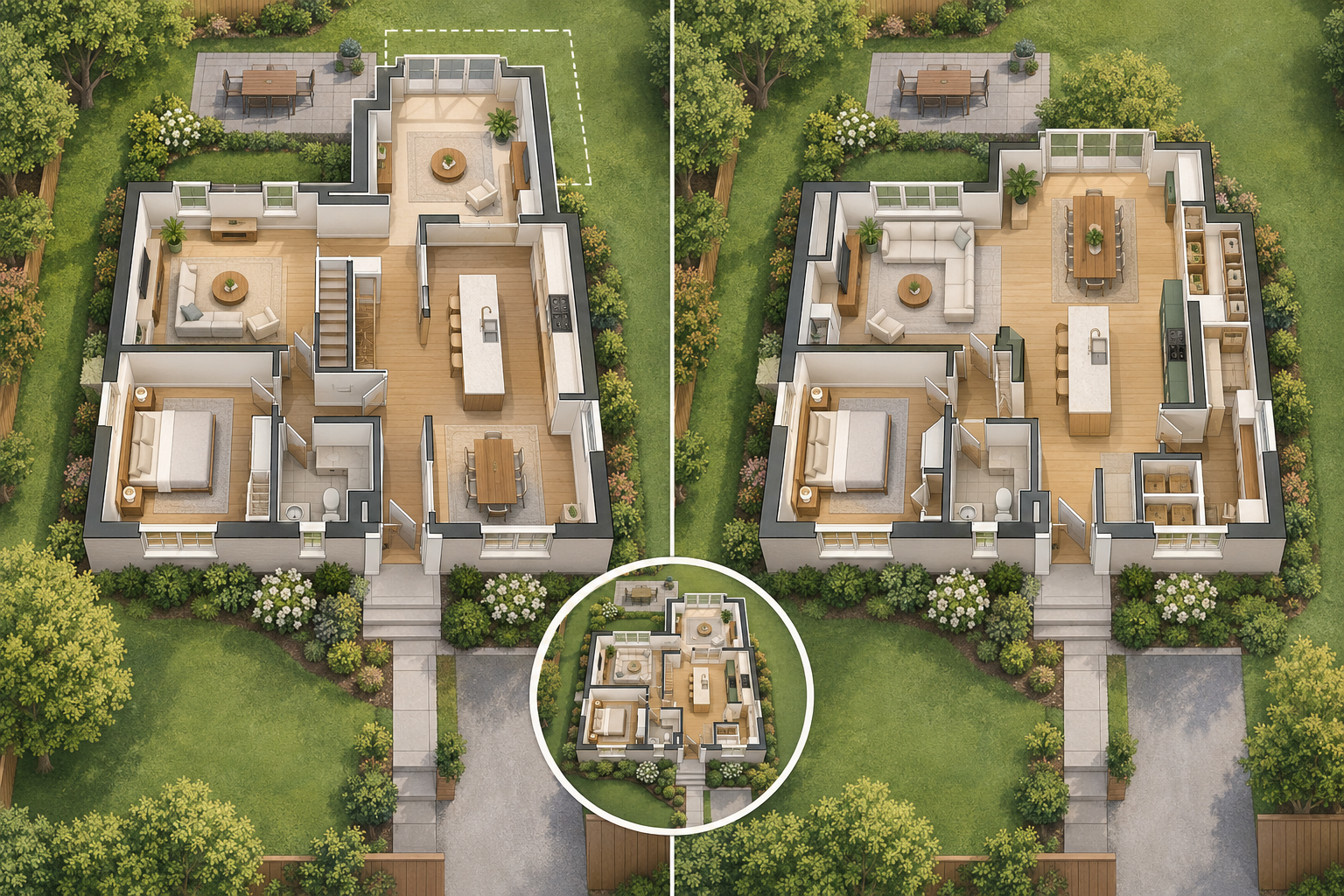

Home Addition vs. Major Interior Reconfiguration

If the house feels too small, it may need more area—or a better arrangement. An addition buys new shell and floor area. Interior reconfiguration can improve circulation, storage, and room relationships without expanding the footprint, but structural and utility work can make it more than a finish remodel.

Diagnose the space problem

Map underused rooms, bottlenecks, storage, privacy, daylight, kitchen and bathroom locations, stairs, furniture, and household changes. Ask whether the missing function is square footage or a better relationship between spaces.

Addition economics

Additions may include site preparation, foundation, framing, roof and wall tie-ins, windows, insulation, utilities, finishes, design, approvals, access, restoration, and contingency. Angi reports a 2026 US average of $50,997 and a broad range of $21,891–$83,356, but those are variable market observations, not a prediction. They are not Canadian prices.

Reconfiguration economics

Price partitions, structural assessment and support, plumbing relocation, electrical, HVAC, stairs, doorways, flooring, ceilings, drywall, cabinets, paint, design, permits, protection, disposal, and temporary living. A kitchen or bathroom moved across the plan can cost more than the unchanged floor area suggests.

For a transparent illustration, a multi-room reconfiguration might include $10,000 for design and assessment, $20,000 for partitions and openings, $22,000 for utility relocation, $18,000 for finish restoration, and $10,000 for protection and temporary living: $80,000 before concealed conditions. This is a worksheet, not a universal interior-remodel range. Compare it with the addition’s site, foundation, and shell scope on the same functional brief.

What the addition avoids—and creates

An addition may preserve existing rooms and avoid a broad interior teardown, but it adds new envelope, foundation, site, and utility work. It may be limited by setbacks, lot coverage, drainage, access, or approvals.

What reconfiguration avoids—and creates

Reconfiguration avoids exterior shell and site work and can make a small home more functional. It may disrupt many occupied rooms, expose structure and services, and require finish matching across a large area. Structural decisions require a qualified assessment; wall appearance is not enough.

Compare three scenarios

Price the minimum reconfiguration, a more complete reconfiguration, and the addition using the same finish quality and professional scope. Record usable area gained, storage, circulation, site impact, disruption, remaining defects, and unknowns. Do not use resale claims without local evidence.

Add space when the household genuinely needs space and the site supports it. Reconfigure when the footprint contains the needed functions but the layout wastes them. The best answer is the one that solves the physical problem with visible scope and acceptable uncertainty.

Interactions to price early

An interior plan can appear inexpensive until it moves the kitchen, bathroom, laundry, stairs, or mechanical equipment. Supply and drain routes, ventilation, electrical circuits, ducts, structural supports, flooring, ceilings, and trim may all follow. An addition can appear expensive until the reconfiguration requires nearly every room to be opened and restored. Put these interactions into both scenarios.

Three scenario questions

Is area actually missing? If storage, circulation, daylight, or privacy is the issue, reconfiguration may produce more value than adding a room. If the household lacks a bedroom, accessible level space, or a work area that cannot be carved from existing rooms, an addition may be justified.

What can remain usable? An addition can isolate much of the work outside the home. Reconfiguration may affect kitchens, bathrooms, and routes that the household uses daily. Temporary living and protection costs can change the comparison.

What does the site allow? Reconfiguration can avoid setbacks, lot coverage, drainage, and foundation work. An addition can preserve the existing plan but may be limited by those same site conditions. Check feasibility before treating either concept as a price option.

A transparent bid request

Give contractors the same existing and proposed plans, finish schedule, appliance locations, service assumptions, and occupancy constraints. For the addition, require site, foundation, enclosure, and utility lines. For the reconfiguration, require structural, plumbing, electrical, HVAC, demolition, and restoration lines. For both, show design, engineering, permits, protection, disposal, temporary housing, contingency, and exclusions.

When the answer is hybrid

The strongest solution may be a modest addition plus a focused reconfiguration—for example, adding a small area while correcting a circulation bottleneck—or a reconfiguration now with a future addition planned. Price the interfaces and avoid assuming that a future phase will have the same access or finish availability.

The decision is complete when the household can explain which functions are gained, which work is avoided, which uncertainty remains, and why the selected scope is worth the disruption.

Do not confuse area with usefulness

An addition may add square footage while leaving circulation, storage, or the original bottleneck unchanged. A reconfiguration may add no area but make the existing footprint work better. Show the furniture, routes, doors, and storage on both concepts before comparing costs.

Coordinate the chosen path

If the decision is an addition, make the connection and existing-house restoration explicit. If it is a reconfiguration, identify structural and utility interfaces before demolition. In either case, ask for a defined contingency and a list of work that remains in related categories, such as specialized water, hazard, or accessibility work.

Use a constraint ledger

Record each constraint, its effect on the addition and reconfiguration options, the investigation needed, and the decision it could change. Include lot limits, structure, plumbing and HVAC routes, stairs, access, storage, privacy, disruption, and the household’s actual function. A ledger keeps an apparently cheaper interior option from hiding a utility or finish dependency.

Compare the same functional brief

Give both options the same brief: people and activities to accommodate, storage, privacy, daylight, furniture, accessibility, number of rooms, kitchen or bathroom needs, and what must remain usable during construction. An addition may create more area but leave the original circulation or storage problem. A reconfiguration may improve the layout without adding area but require extensive structural and service work.

Mark each requirement as delivered, preserved, changed, or unresolved by each concept. This keeps a lower price from winning by delivering less. It also helps identify a hybrid path where a small addition and a focused interior change solve separate parts of the problem.

Price the interfaces that area hides

For the addition, include site, foundation, structure, envelope, roof and wall connections, utilities, finishes, design, approvals, access, protection, restoration, and contingency. For the reconfiguration, include structural assessment and support, partitions, demolition, plumbing, electrical, HVAC, stairs, doors, flooring, ceilings, cabinetry, finishes, protection, temporary living, and permits. Shared systems should be shown once and coordinated with both concepts.

If a kitchen, bathroom, laundry, service panel, duct, stair, or structural support moves, follow its route through the plan. Similar-looking layouts can have different budgets because one keeps services near existing runs and the other opens multiple rooms. Do not mechanically add component averages; show the integrated sequence and the restoration it causes.

Test the home during and after construction

Record which kitchen, bathroom, entrance, bedroom, heating, water, and electrical functions remain available in each option. A reconfiguration may affect the whole floor at once. An addition may isolate much of the work outside while disturbing the connection and yard. Include temporary protection, storage, relocation, dust, access, and finish matching.

After completion, compare maintenance access, circulation, privacy, storage, daylight, energy or comfort assumptions, and future adaptability. A new area that is hard to reach or poorly connected may deliver less value than a smaller layout change. A reconfiguration that hides equipment or removes a service route can create future costs that do not appear in the initial estimate.

Use a decision gate before detailed drawings

Require one measurable success condition for the chosen path, such as a usable room count, a shorter circulation route, a defined storage capacity, or a workable daylight and privacy arrangement. That condition gives later design and pricing decisions a reference point and makes it easier to reject attractive but unrelated upgrades.

Set the gate around the problem the household is paying to solve. If reconfiguration can deliver the required rooms, storage, circulation, light, and privacy without unacceptable structural or service work, it may be the more contained path. If the brief still lacks area or a workable relationship to the yard, an addition may earn the extra envelope and site cost. Neither option should receive credit for rooms or finishes that the other does not provide.

Once a path is chosen, preserve the rejected option’s useful evidence. Keep the constraint ledger, service locations, and functional measurements with the project record. If bids or discoveries change the economics, the household can revisit the decision from a known baseline rather than starting the comparison again.

Obtain a concept-level site and structural review, map major utilities, and confirm local planning or approval questions. Then request comparable budgets with the same finish standard and professional scope. Reconsider the preferred path if the addition needs major site or structural correction, if the reconfiguration opens nearly every finished room, or if the hybrid creates interfaces that neither proposal explains.

The best choice is not the one with the least construction area. It is the one that resolves the household’s actual spatial problem, preserves useful functions, and makes the structural, service, site, disruption, and remaining-risk trade-offs visible.

List the constraints that both options must respect: lot limits, daylight, privacy, storage, structure, stairs, plumbing routes, HVAC capacity, electrical service, drainage, and the household’s tolerance for disruption. Mark each as avoided, shared, or newly created by each option. This often reveals that an addition solves an area constraint while reconfiguration solves a circulation constraint, or that both need the same service upgrade.

The ledger also helps explain a hybrid choice. A small addition may remove the pressure to move a load-bearing wall, while an interior change may make the new area useful. Price the hybrid as its own scope rather than assuming it is automatically the sum of the cheapest pieces.

Research notes

Sources used for this guide
