Major Floor-Plan Reconfiguration Cost
A major floor-plan reconfiguration changes several rooms, partitions, doorways, or circulation paths at once. It is broader than one wall removal and narrower than a whole-house remodel. Two plans with the same finished area can have very different costs if one moves a kitchen, bathroom, stair, or structural support.
A transparent integrated example
For illustration only, a multi-room reconfiguration might model $10,000 for design and structural assessment, $20,000 for partitions and openings, $22,000 for utility relocation, $18,000 for flooring, ceilings, and finish restoration, and $10,000 for protection, permits, and temporary living: $80,000 before concealed conditions. This is not a market quote or a sum to reuse unchanged; the point is to show the interfaces that a coordinated bid must explain.

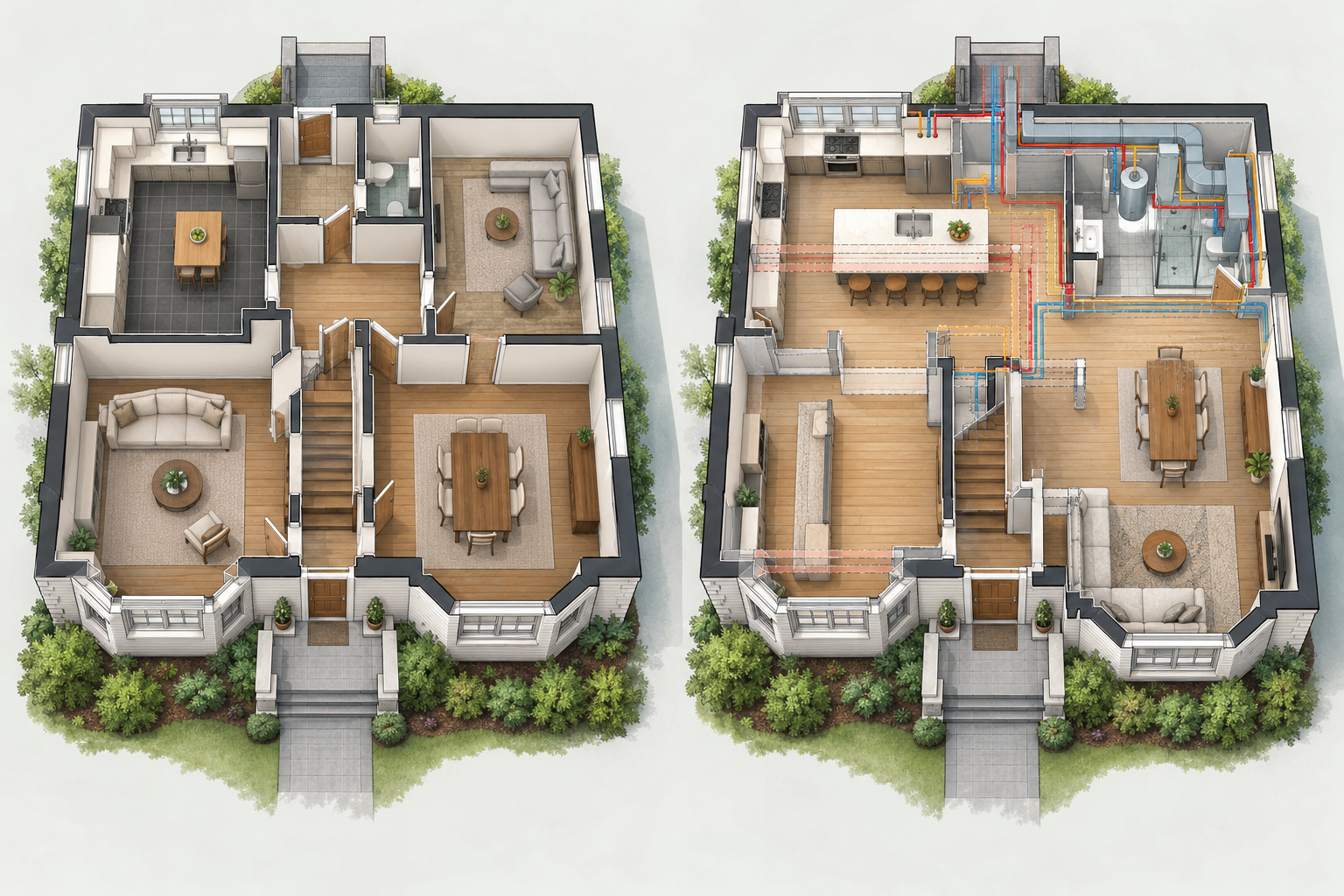

Define the new plan
Show existing and proposed walls, doors, stairs, kitchens, bathrooms, storage, circulation, windows, mechanical equipment, and furniture clearances. Identify which rooms remain usable during construction and which finishes must match.
The cost layers
Partitions and structure: New and removed walls, openings, structural assessment, temporary support, replacement supports, posts, and loads below. A professional must determine structural scope; visual rules are not enough.
Plumbing: Moving a kitchen, bathroom, laundry, or water heater can require longer supply and drain routes, venting, pumps, slab work, or service coordination. A small plan change can become expensive when wet areas move far from existing infrastructure.
Electrical and HVAC: Circuits, lighting, switches, panels, ducts, registers, controls, ventilation, and equipment relocation may be affected. Include capacity and access assumptions.
Restoration: Ceilings, flooring, drywall, trim, doors, paint, cabinets, counters, stairs, and fire or finish details. Matching can make the restoration broader than the new construction.
Professional and carrying costs: Design, engineering, permits, inspections, access, protection, disposal, temporary living, and contingency. Houzz’s market research is project-observation context rather than a universal rate.
Reconfigure or add space?
Reconfiguration may avoid foundation, site, and new-envelope work, but it can disrupt more of the existing home and consume budget in utility relocation and restoration. An addition may deliver genuinely new area while preserving the old plan, but it adds shell, site, and approval costs. Compare both using the same finish and professional assumptions.
Quote checklist
Ask for existing-condition assumptions; structural and utility scope; new partitions; stairs; plumbing; electrical; HVAC; finishes; design and engineering; permits; protection; temporary living; allowances; and exclusions. Do not sum separate trade averages without accounting for coordination and shared access.
The best layout budget shows where the plan changes the building, not just how many rooms appear on the final drawing.
Interactions that make costs multiply
Moving a wall can change the location of outlets, switches, lights, vents, doors, baseboards, flooring, and furniture. Moving a wet room can add drain length, venting, pumps, slab access, or water-heater coordination. Changing a stair can affect structure, headroom, handrails, and several floors. These are interacting scopes, not independent shopping-list items.
Ask for a proposed plan that marks every retained and relocated service. A contractor who prices only new partitions may be assuming the existing electrical, plumbing, and HVAC remain untouched. That assumption can be reasonable for one plan and impossible for another.
Three reconfiguration levels
Partition-level: New nonstructural walls, doors, paint, and flooring or trim repair. This can be relatively contained when services remain accessible.
Structural-room level: One or more load-bearing openings, support design, utility relocation, and broader finish restoration. This is the zone where a structural assessment controls the budget.
Multi-system level: Kitchen or bathroom relocation, stair change, several structural openings, service upgrades, and a coordinated finish reset. This may approach a whole-house remodel even if the square footage is unchanged.
Occupancy and sequencing
Decide which bathroom, kitchen, bedroom, and access route must remain available. A project that looks short on paper can require temporary cooking, bathing, storage, or sleeping arrangements. Sequence rough services, inspections, structural work, enclosure, and finishes so one phase does not reopen a completed area.
Evaluate the proposed value
Count the functions gained: better circulation, storage, privacy, daylight, work-from-home space, or a more usable kitchen. Compare those gains with area lost to new partitions, temporary conditions, and remaining defects. If the reconfiguration still leaves the home too small, price an addition as a separate scenario. If it solves the problem without new floor area, the avoided foundation and exterior work may be valuable.
A better bid request
Give bidders the same dimensioned plan, finish schedule, appliance locations, service assumptions, and occupancy constraints. Require them to list investigation, design, structural work, plumbing, electrical, HVAC, demolition, protection, restoration, permits, inspections, allowances, and exclusions. This exposes whether a low proposal is simply postponing the work that makes the plan function.
Plan for the interfaces
Mark temporary walls, appliance moves, service shutoffs, inspection points, and the order of work. An opening that is structurally complete may still be unusable until electrical, plumbing, HVAC, flooring, and finishes are restored. Request a schedule that explains those interfaces and the household’s temporary arrangements.
A decision checkpoint
Before construction, ask whether each expensive change improves a named function. If a wall move does not improve circulation, storage, privacy, or serviceability, remove it from the scope. This protects the budget from scope creep while preserving the changes that make the new plan materially better.
Do not forget the unaltered rooms
Dust protection, temporary routes, floor transitions, paint matching, and service interruptions can extend beyond the rooms being redesigned. Show how the work reaches the electrical panel, mechanical equipment, plumbing stack, exterior wall, or attic. A small plan change can create restoration in an adjacent room even when that room is not part of the finished layout.
Also identify what the existing plan does well. If a wall move loses a useful closet, quiet work area, or furniture location, record that tradeoff. A good reconfiguration budget measures net function, not only the number of walls removed.
Map the complete proposed layout
Show existing and proposed walls, doors, stairs, windows, kitchens, bathrooms, storage, furniture, mechanical equipment, and circulation. Mark which rooms remain usable during the work and which finishes must connect to adjacent rooms. This reveals whether the project is a focused layout change or a broader whole-house remodel.
Classify each change as retain, repair, remove, relocate, add, or unknown. A relocated kitchen or bathroom may require longer supply, drain, vent, electrical, and ventilation routes. A moved stair can affect structure and several floors. A new doorway can require lintels, finish matching, and changes to lighting or heating. The floor area is only the starting point for the budget.
Price interfaces before finishes
Ask the designer and contractor to identify all work that crosses the proposed room boundaries: structural supports, plumbing stacks, HVAC ducts, electrical panels and circuits, insulation, flooring, ceilings, cabinetry, trim, and exterior openings. If a service must be moved, show the route and the rooms or finishes it disturbs. If a room stays unchanged, show how it is protected and how its systems remain accessible.
Use allowances only for conditions that are genuinely unresolved, and state what investigation would refine them. A low proposal may exclude the ceiling and floor restoration, temporary support, protection, or service capacity required to make the new plan work. A higher proposal may be pricing the interfaces explicitly. Compare like with like before choosing.
Compare three levels of change
When useful, price a minimum reconfiguration, the preferred multi-room plan, and an addition or hybrid alternative. Keep the intended functions, finish quality, professional services, approvals, temporary living, and contingency assumptions consistent. The minimum plan may preserve more existing work but solve less of the circulation or storage problem. The preferred plan may deliver more function but trigger utilities and restoration. An addition may avoid some demolition while adding foundation, enclosure, site, and tie-in work.
Do not mechanically add individual trade averages. The interactions are the project: moving one wall can alter a floor, ceiling, cabinet run, duct, outlet, and doorway. The estimate should state those dependencies and identify which decisions must be made before demolition.
Test the lived result
Use a temporary layout or a scaled plan to test the change at daily speed. Mark where people enter, turn, queue, carry groceries, open doors, and reach storage. Check the views and daylight that will remain after new partitions or openings are built. This often exposes a problem that an area total misses: the new plan may technically fit while making circulation longer or reducing useful wall space.
Finish the comparison with a disruption map. Identify which rooms lose access, which utilities must stay live, and which surfaces will be repaired after the work. If a reconfiguration requires moving several systems at once, price it as an integrated project instead of adding isolated room allowances. The best plan is the one that improves the daily pattern and has a controllable sequence.
Place furniture and daily routes on the proposed plan. Check privacy, daylight, storage, sound, doors, stairs, kitchen work zones, bathroom access, and maintenance routes. Ask what the household will lose while gaining the new arrangement. If the new plan works only by sacrificing a useful closet, accessible route, service panel, or future maintenance path, include that trade-off before approving it.
Proceed when the intended function, structural scope, service routes, finish restoration, occupancy strategy, and approval questions are clear enough for comparable bids. Reconfiguration is worthwhile when it improves the actual use of the footprint; it is not worthwhile merely because fewer new square feet appear on the estimate.
