Is Your Basement Ready to Finish? Hidden Costs Before a Conversion
A basement can look dry and usable during one visit while still carrying seasonal moisture, low height, poor access, or service conflicts. The readiness check comes before finishes because hidden prerequisites can consume the budget and change the project’s purpose.
Moisture first
Look for water entry, dampness, staining, efflorescence, drainage concerns, and conditions that change after heavy rain or snowmelt. DOE guidance puts moisture control and air sealing before insulation and finish work, and recommends radon testing before relevant below-grade work. This is technical guidance, not a diagnosis or a substitute for a qualified assessment.
Waterproofing, footing drains, sump systems, and groundwater correction belong to the below-grade-water decision. A finishing quote may identify them as prerequisites, but should not hide them inside a finish allowance.

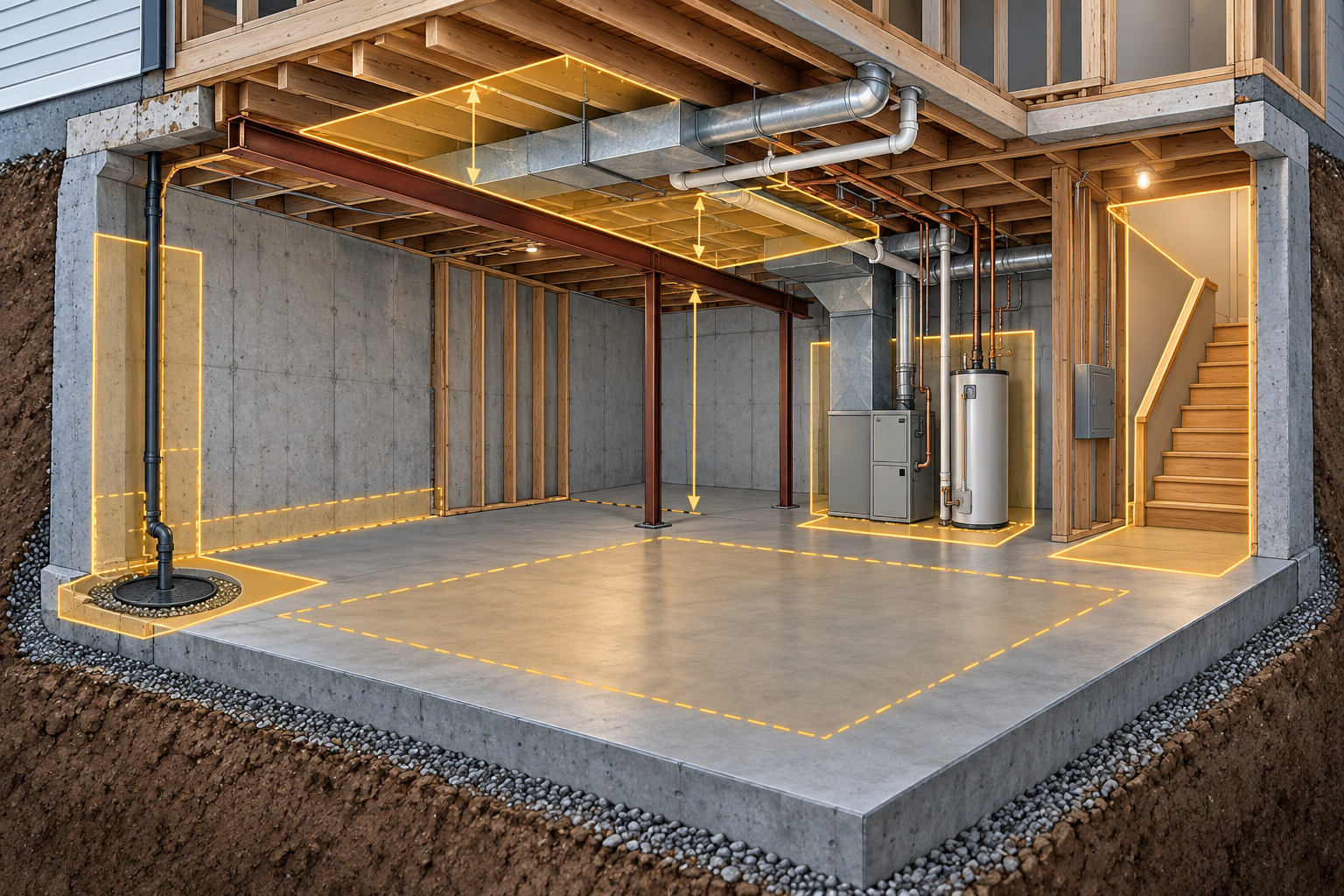

Height, structure, and slab
Measure the actual usable areas after beams, ducts, pipes, stairs, and floor build-up. If the design depends on lowering the floor or underpinning, the project has become a structural foundation decision. HomeStars reports CAD 20,000–80,000 as one Canadian market example for underpinning or bench footing; actual cost depends on the building and design.
Do not infer structural suitability or legal room dimensions from a generic rule. Have the intended use and local requirements reviewed before committing to a layout.
Egress and mechanical conflicts
Windows, doors, stairs, furnaces, water heaters, ductwork, drain lines, electrical panels, and shutoffs can affect rooms and routes. A room intended as a bedroom may have different exit expectations than storage or a family room. The authority and qualified designer must determine current applicable requirements.
Utilities and hazards
Plan electrical circuits, HVAC, ventilation, plumbing, and lighting before framing. If older materials may contain hazards, do not disturb them to “see what is behind the wall.” Testing and abatement are specialized work. A major project may need a separate hazard allowance and qualified handling.
Build a prerequisite budget
Ask for separate allowances or scopes for moisture, structural or slab work, height correction, egress, mechanical relocation, electrical, plumbing, insulation, hazards, access, and restoration. Label each as verified, estimated, or unresolved. This is more useful than one contingency percentage applied to an undefined finish total.
When the conversion still makes sense
The project is easier to justify when the basement is dry, the height and structure are suitable, services are accessible, and the household needs the resulting rooms. If the prerequisite work becomes nearly a new foundation, major service relocation, and complete reconstruction, compare an addition or a different layout.
Readiness is not a promise that the basement can be finished. It is the budget checkpoint that prevents a finish quote from being mistaken for the price of a safe, durable, usable conversion.
A room-by-room readiness walk
Mark every proposed room and note the lowest ceiling, beams, ducts, pipes, posts, panels, equipment, windows, doors, drains, and access route. A plan that fits on a sketch may fail after insulation, drywall, flooring, and required clearances are added. Record seasonal observations rather than assuming one dry day represents the year.
Ask which conditions are confirmed, which are only visually observed, and which require testing or opening. This distinction makes an allowance meaningful. “No water seen” is not the same as “moisture risk assessed.”
Budget the sequence
- Confirm water and moisture conditions and address source problems.
- Review structure, slab, height, and intended room use.
- Check access, egress, mechanical conflicts, and service capacity.
- Investigate hazards with appropriate professionals where the building age or materials warrant it.
- Design insulation, air sealing, HVAC, electrical, plumbing, and finishes together.
DOE guidance supports moisture control, air sealing, and appropriate conditioning before a basement is closed in. It is technical guidance for a durable sequence, not a DIY remediation manual.
When the lowest quote is not the best quote
A finish-only quote may be attractive because it assumes the basement is dry, level, tall enough, accessible, and already serviced. A higher proposal may include investigation, correction, and restoration. Compare assumptions and exclusions before comparing totals.
If the prerequisite budget grows into foundation alteration, major water control, complete service relocation, or hazard abatement, use the related specialist categories and reconsider whether finishing this space is still the best route to the household’s goal.
Separate unknowns from repairs
Use three columns in the early budget: conditions already observed, conditions that need testing or limited opening, and corrective work that is only an allowance. For example, a visible crack, a suspected moisture path, and a designed repair are different facts. Keeping them separate helps the owner decide whether to fund more investigation or compare another use of the space.
The readiness decision is not “finished or unfinished.” It can be staged: investigate first, correct the building, then finish only the rooms that remain suitable. This protects new flooring, insulation, and drywall from being treated as a solution to an unresolved basement problem.
Triage the unknowns by consequence
Start with conditions that can make the conversion unsafe, undurable, or impossible: active water entry, structural movement, unsuitable height, blocked exits, combustion or ventilation conflicts, and suspected hazardous materials. Next review conditions that materially change the budget, such as slab level, long service routes, electrical capacity, HVAC distribution, stair geometry, access, storage, and finish removal. Decorative selections come last.
This order does not diagnose the basement. It tells the homeowner where professional investigation has the highest decision value. A moisture assessment, structural review, local use or egress review, utility check, or hazard evaluation may be more valuable than a detailed finish estimate if the result could eliminate the preferred layout.
Turn readiness into three budget scenarios
Prepare a finish-only scenario only when the starting conditions are verified. Prepare a prerequisite-plus-finish scenario when known corrective work is likely. Prepare an alternative-use or addition scenario when the basement may need extensive structural, water, access, or service reconstruction. Keep the same intended function and finish quality where the comparison is meaningful.
For each scenario, distinguish confirmed conditions, investigation allowances, corrective work, and owner decisions. If a contractor proposes an allowance for moisture or structure, ask what observation or test would refine it and when that decision must be made. An allowance should have a scope and a decision point; otherwise it can become an unbounded change order.
Check interactions before closing the ceiling
Basement systems compete for the same limited space. Floor build-up can reduce headroom. Insulation and air sealing can change the location of services. Ducts, pipes, beams, posts, panels, cleanouts, pumps, and water heaters can control room layout. A bedroom plan can fail because the route to an exit is blocked; a bathroom can fail economically because the drain route requires extensive demolition; a finished ceiling can make future service work expensive.
Ask for a coordinated plan showing room boundaries, stairs, exits, equipment, services, and access panels before framing is closed. The exact technical solution belongs to qualified professionals, but the budget should show which systems are being moved, protected, or left exposed.
Know when readiness is not worth pursuing
Give every unresolved condition an owner and a next test. A moisture question may need observation or a specialist assessment; an egress question may need a measured opening; a service-clearance question may need a revised plan. The point is to convert a vague allowance into a decision with a date and a consequence.
Use a written readiness gate when the unknowns begin to dominate the estimate. The gate can ask: Is there a credible moisture-control path? Can the planned rooms achieve the needed egress and ceiling conditions? Can equipment remain serviceable? Can materials reach the work area without unacceptable disruption? If several answers are “not yet,” pause finish selections and fund only the investigation needed to answer those questions.
It is also reasonable to leave part of the basement unfinished. A clean utility zone, storage area, or future-ready stub can protect access while preserving the option to finish later. That choice is not a project failure when it avoids enclosing a known problem. Price the boundary carefully: include safe separation, lighting, required protection, and a plan for future connections so the unfinished area does not become an unsafe or inaccessible remainder.
When the basement is ready, document the assumptions that made it ready. Keep moisture observations, equipment locations, service clearances, and the basis for any allowance with the project records. Future work will then begin from known conditions instead of reopening the same questions.
Reconsider the conversion when the property needs extensive underpinning, active water correction, broad structural repair, major hazard work, replacement of most services, or a layout that leaves little usable room. That does not prove an addition is cheaper. It means the homeowner should compare the total prerequisite burden with another path before purchasing finishes.
Readiness is a decision about the building and the intended use. Once the major gates are addressed, the owner can price finishes with more confidence. Until then, a low finish estimate is only a partial answer.
