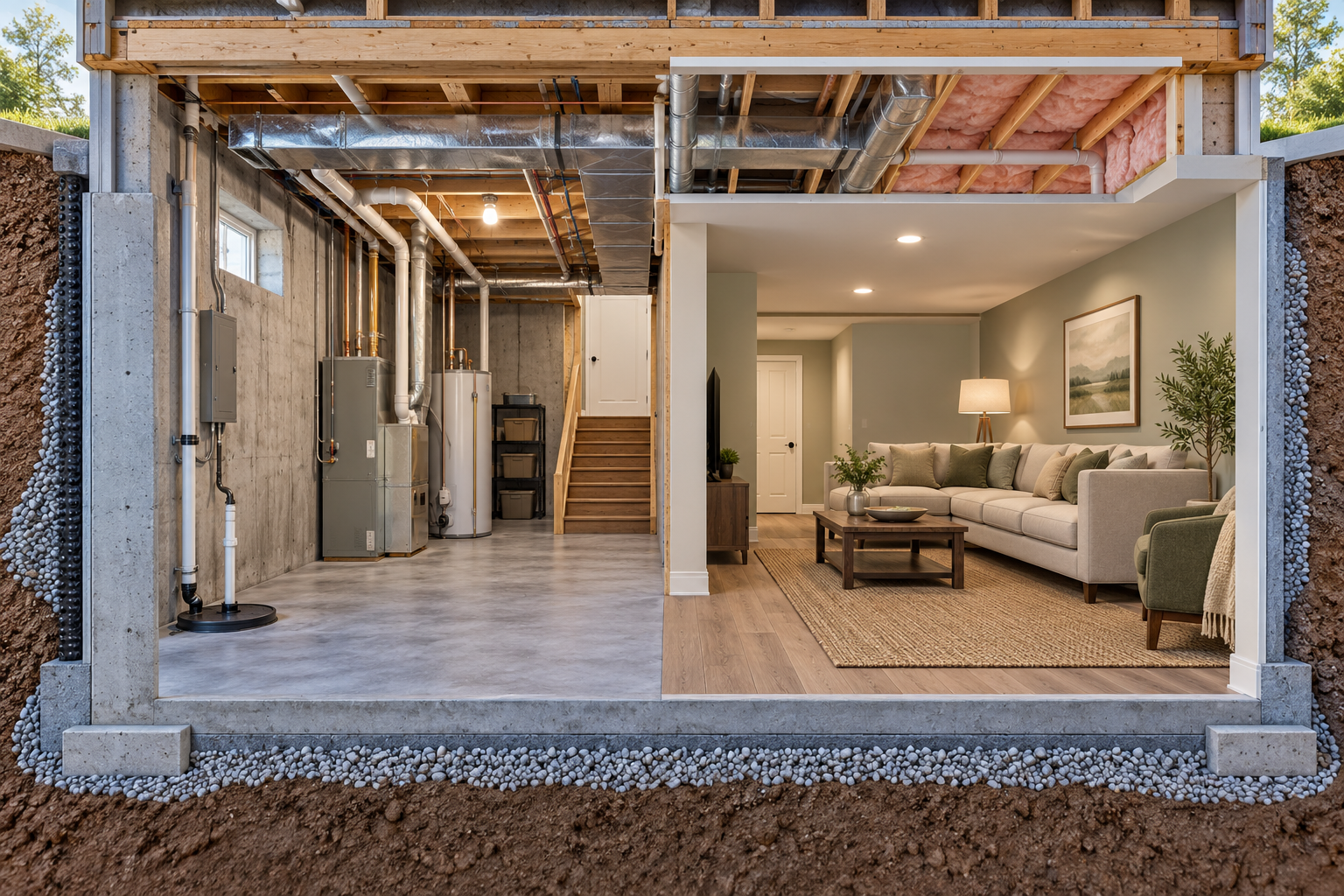

Finishing a basement converts unfinished or lightly finished space into owner-occupied living area. The starting condition matters more than a generic square-foot number. A dry, accessible basement with suitable height and nearby services is a different project from one needing water correction, underpinning, new egress, or major utility routing.
A Canadian readiness cost anchor
HomeStars reports CAD 20,000–80,000 for underpinning or bench footing in the examples it presents for low basement ceilings. That is an added prerequisite, not the cost of finishing the basement. For an illustration only, if a dry basement has a hypothetical CAD 55,000 finish bid, the same plan with a CAD 20,000–80,000 ceiling correction would expose CAD 75,000–135,000 before other site, service, or approval changes. Use the property’s investigation and bid—not this arithmetic—as the budget.
Define the finish
List rooms, partitions, ceiling, flooring, insulation, drywall, lighting, outlets, HVAC, storage, stairs, bathroom, wet bar, bedroom use, and finish level. An independent kitchen and entrance may turn the project into a secondary suite or ADU with additional approval and life-safety questions; do not use an ordinary finishing budget for that use.
Cost layers
Readiness: Moisture investigation and correction, foundation or slab work, drainage, radon assessment where relevant, access, and any structural or height correction come before finishes. If ceiling correction is being considered, have the relevant structural or foundation work scoped before comparing finish bids; the Canadian example above is one readiness input, not a standard allowance.
Enclosure: Framing, insulation, air sealing, drywall, ceiling treatment, and fire or sound details. DOE guidance says moisture control and air sealing should precede insulation; a finished wall should not conceal a known water problem.
Services: Electrical circuits, lighting, heating and cooling, ventilation, plumbing, water heating, and controls. A bathroom adds supply, drainage, waterproofing, fixtures, and ventilation.
Finishes: Flooring, paint, trim, doors, cabinets, stairs, storage, and transitions to the existing home. Matching an older floor or stair finish can cost more than finishing a new open room.
US and Canadian evidence
Market sources use different populations, scopes, and currencies. Keep Canadian observations in CAD and US observations in USD; do not use exchange rates to manufacture one blended range. A quote should state whether it includes professional design, permits, demolition, moisture work, electrical service, plumbing, and restoration.
Bedrooms and egress
Whether a basement room can be used as a bedroom, how an exit works, and what separation or alarm provisions apply depend on the adopted local requirements. Ontario’s guidance contains Ontario-specific examples; they are not universal North American dimensions. Ask the authority or qualified designer before labeling a room a bedroom in plans or a listing.
Establish the starting condition
Describe the basement before comparing area or finishes. An unfinished concrete space, a framed but unheated basement, and a partly finished area with damaged work contain different scopes. Record moisture history, slab and floor level, ceiling height after the new assembly, stairs, windows, equipment, electrical service, plumbing rough-ins, insulation, access, and work that must be removed.
Treat active water correction, structural work, hazardous-material testing or abatement, and major service changes as prerequisites rather than quietly adding them to a finish contract. DOE guidance supports controlling moisture and air leakage before insulation; it does not diagnose a particular basement. Pause if moisture, structure, height, egress, or required service routes remain unresolved.
Price the package for its intended use
A basic living area may need framing, insulation and air sealing, drywall, a ceiling, durable flooring, lighting, outlets, HVAC connection, trim, and paint, assuming the basement is already suitable. Multiple rooms add partitions, doors, storage, circuits, and coordination. An office may need quiet and data; a family room may prioritize circulation and durable finishes; a bedroom brings local egress and privacy requirements. A bathroom or wet bar adds plumbing, drainage, ventilation, waterproofing, fixtures, and service access. An independent suite is a separate classification and approval decision.
Ask for the baseline use and optional upgrades separately. Premium flooring, custom cabinets, or extra fixtures should not hide required moisture, electrical, or structural work. The package descriptions are scope comparisons, not fixed prices or universal rates. Keep U.S. and Canadian observations in source-native currencies and treat local examples as local.
Normalize proposals and ownership effects
Give each bidder the same room plan, starting-condition notes, finish schedule, bathroom or wet-bar assumptions, and known constraints. Ask the proposal to show investigation and readiness, demolition, framing, insulation and air sealing, electrical, HVAC and ventilation, plumbing, stairs, finishes, permits and inspections, protection, disposal, cleanup, allowances, exclusions, and responsibility for repairing existing conditions. State whether the contractor will level the slab or address cracks, or whether those require separate work.
Plan storage, furniture, lighting, sound separation, service access, and the route through the house. Keep panels, shutoffs, cleanouts, ducts, pumps, and equipment accessible. A raised floor may reduce headroom or change thresholds; a dropped ceiling may simplify access while reducing height. Include temporary protection and the household’s ability to use the basement and stairs during construction.
Make the contract decision in sequence
First confirm that moisture, structure, height, egress, and services support the intended use. Then select a finish package and compare proposals with the same assumptions. Verify local bedroom, suite, and approval requirements before relying on those labels. Resolve responsibility for moisture boundaries, penetrations, inspections, service access, and damage during material movement before signing.
If a contractor assumes a dry, level, tall, fully serviced basement without showing how that condition was checked, pause before comparing decorative finishes. A reliable budget moves from readiness, to prerequisite correction, to finish scope, while preserving access for future repair.
