Compare interior, closed-cavity, and exterior wall-insulation retrofit approaches, including access, finishes, moisture design, and siding coordination.

On this page

Exterior Wall Insulation Retrofit Cost: Interior, Cavity, and Exterior Options

Exterior-wall insulation is not one project type. A contractor may open walls from the interior, drill and fill existing cavities, or add insulation from the exterior while siding is removed. The cheapest method on paper may be the wrong choice if it leaves unknown cavities, damages finishes, creates a moisture problem, or misses the opportunity to improve continuity.

Illustrative planning scenario

For 1,500 square feet of U.S. wall area, a preliminary planning model might allow $4,000–$12,000 for accessible cavity work, $8,000–$20,000 for an exterior retrofit coordinated with re-siding, or $12,000–$30,000 for substantial interior opening and restoration. The ranges are scenario boundaries, not comparable bids; Canadian projects need separate local CAD pricing.

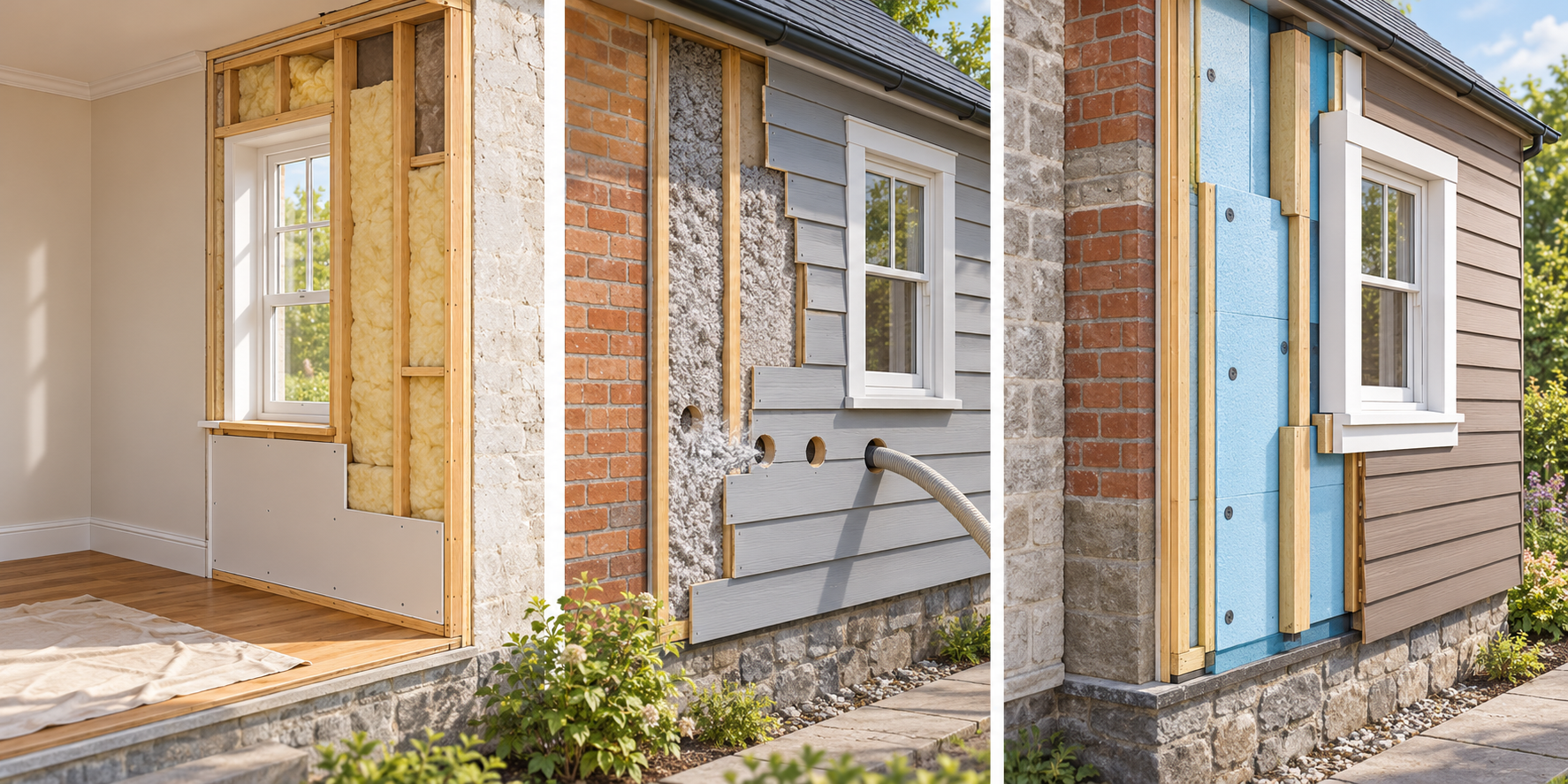

Three broad retrofit paths

Interior access can expose the framing and make the existing assembly easier to inspect, but it adds demolition, dust, temporary relocation, drywall or plaster repair, painting, trim work, and disruption. It can be sensible during an interior renovation or where the exterior finish must remain.

Closed-cavity work uses holes from the interior or exterior to fill an existing cavity. It can reduce demolition, but the installer may not know the cavity condition, obstructions, wiring, plumbing, fire blocking, or the quality of the fill until exploratory work is done. Patching and exterior finish repair can also become part of the price.

Exterior insulation is often considered during siding replacement. It can improve continuity and reduce framing-related heat flow, but it affects wall thickness, windows, doors, trim, flashing, fastening, weather-resistive barriers, and cladding. The siding project remains a separate scope even when the work is coordinated.

How to think about cost

The available evidence does not establish a dependable national U.S. or Canadian installed range for all wall methods. Build the budget from cost layers: investigation, access, demolition, insulation, air and moisture control, opening details, finish restoration, and inspection. A small closed-cavity fill may be dominated by mobilization and patching. A full exterior approach may be dominated by siding removal, trim, flashing, and scaffold or access.

Ask for a low-disruption cavity option, an interior-open-wall option, and an exterior-during-re-siding option when each is plausible. Do not compare a bare insulation line to a complete wall assembly.

Existing conditions matter more than the label

Older walls may have multiple layers, sheathing, masonry, paper, air spaces, additions, or previous repairs. Wall construction can vary from room to room. Moisture history, wind exposure, cladding, and drying potential affect whether a method is suitable. A quote should state what was inspected and what remains unknown.

Electrical boxes, plumbing, ducts, fire blocking, and structural elements can interrupt cavities. A dense-pack or injection proposal should describe how fill will be checked and how obstructions or incomplete cavities are handled. Do not assume that a product can be installed everywhere because it works in one wall section.

Air, vapor, and water control

Insulation slows heat transfer, but it does not by itself create a continuous air barrier or weather barrier. A wall retrofit needs a clear explanation of how airflow, vapor diffusion, bulk water, and drainage are handled. A housewrap or membrane may serve a weather or drainage function and may contribute to air control only when its seams, edges, openings, and flashing are properly detailed.

Climate and assembly determine whether a vapor retarder is appropriate and where it belongs. Do not turn a general building-science principle into a universal code instruction. Verify current local requirements and the exact wall assembly with a qualified designer or contractor.

Bundling with other work

Exterior insulation can become more economical when siding is already being removed, because access, protection, and some restoration are shared. Interior insulation can be less disruptive during a planned gut renovation. Wall work may also coordinate with window replacement, but discrete opening work remains a separate decision. The useful question is whether the adjacent project exposes the control layer that needs improvement, not whether the contractor can add another line item.

U.S. and Canadian context

ENERGY STAR gives U.S. retrofit examples for added sheathing in certain climate zones when siding is removed. Those examples are not Canadian targets or a complete code table. Canadian wall practices, labor, materials, and local requirements vary by region. Keep each market’s quote and design assumptions separate; do not convert a U.S. allowance into Canadian dollars.

Comparing proposals

Ask each bidder to state wall area, access method, exploratory work, insulation type, air-control strategy, vapor-control assumptions, water-management details, opening and trim effects, patching, cladding coordination, permits, and exclusions. Ask what happens if cavities are already full, wet, inaccessible, or obstructed.

Exterior-wall insulation can improve comfort and energy performance, but it is rarely a simple fill operation. A responsible budget pays for knowing the wall, protecting its drying potential, and restoring the layers that make the enclosure durable.

Choosing among the three broad paths

Interior opening may provide the most direct inspection and allow the contractor to correct cavities, air leakage, wiring or plumbing conflicts, and finish details. It can be disruptive in an occupied home and may require drywall, plaster, cabinets, flooring, or painting work. Closed-cavity filling limits demolition but leaves more uncertainty about the construction and the completeness of the fill. Exterior work can improve continuity and coordinate with siding, but it adds cladding, flashing, trim, and opening consequences.

The least expensive method on a unit-price sheet is not necessarily the least expensive complete project. Ask what the homeowner must restore after each method and how much of the wall can actually be treated. A method that reaches only selected bays may still be rational, but its limited coverage should be stated rather than described as a whole-wall solution.

Moisture and control-layer questions

Before adding insulation, identify water entry, existing sheathing condition, air-control continuity, vapor-control assumptions, and drying direction. A wall that is dry today may still depend on a particular drying path. Adding an exterior layer can change temperature and moisture behavior; adding an interior layer can reduce drying toward the room. Specific code and compatibility conclusions require local, assembly-specific review.

Ask whether the proposed work includes WRB repair, window and door flashing, penetrations, electrical and plumbing, and transitions to the roof, foundation, and floor. These interfaces often determine whether the project is durable. A quote that includes only cavity fill or boards does not price the complete enclosure.

Renovation timing and decision value

Wall insulation is often more economical when siding, interior finishes, an addition, or a major remodel already exposes the assembly. That opportunity can reduce demolition, but it can also tempt an owner to add work without a clear performance goal. Compare a priority wall scope with a coordinated whole-house option and state what comfort, moisture, or energy problem each is intended to improve.

U.S. and Canadian costs should remain separate. The market evidence is directional and assembly-specific; it is not a national price list. The best proposal makes the hidden conditions, finish consequences, and control-layer design visible before the wall is closed.

A decision that can be tested

Before work begins, ask what observable condition the retrofit is intended to change: uneven insulation, cold interior surfaces, drafts, high energy use, moisture risk, or an opportunity created by re-siding. Ask how the contractor will inspect the work before finishes return. If the goal is comfort, identify the rooms and surfaces; if the goal is energy, identify the assumptions; if the goal is moisture durability, identify the water source and drying strategy.

This avoids treating “wall insulation” as one commodity project. A cavity-fill quote, an interior demolition quote, and an exterior re-siding quote may each be valid for a different home. Compare the complete installed system and the disruption required to reach it. The most economical method is the one that solves the defined wall problem without creating an unpriced opening or moisture problem.

Verify the wall before filling it

Wall insulation estimates depend on the existing cavity, sheathing, cladding, wiring, plumbing, fire blocking, and moisture history. Ask how the contractor will confirm the cavity condition and whether small openings, probes, or existing renovation access are enough. If the wall has a leak, rot, pest damage, or an uncertain drainage plane, the repair and investigation should be priced before insulation is treated as the solution.

The scope should show how the new work connects at the foundation, rim joist, roof line, windows, doors, corners, and interior partitions. It should identify finish restoration and describe how the owner will verify that the intended areas were treated. A marked elevation, cavity map, and product record make future drilling and remodeling safer and prevent a later contractor from assuming that every bay contains the same material.

Research notes

Sources used for this guide
