Bump-Out Addition Cost: When a Small Addition Makes Economic Sense
A bump-out expands one part of an existing room rather than adding a full new wing. The term is used inconsistently, so define the project before discussing price: how far it projects, whether it needs a foundation, whether it adds a roof, and whether the wall carries utilities or structure.
A scoped cost check
Angi reports a 2026 U.S. home-addition average of $50,997 and a broad range of $21,891–$83,356. Those are directional observations for additions generally, not a bump-out quote. They are useful context for the fixed-cost problem, but they should not be presented as a portable bump-out range or as Canadian pricing.
For an illustration only, compare a $48,000 bid for 100 square feet with a $62,000 bid for 180 square feet. The first is $480 per square foot and the second is about $344 per square foot, even though the second project costs more overall. Compare the foundation, opening, roof, utilities, and restoration included in each bid instead of judging a small addition by unit price alone.
Why small additions can have high unit costs
Design, mobilization, permits, site protection, demolition, wall opening, structural tie-in, roofing, and finish restoration are partly fixed costs. They do not shrink in proportion to the new floor area. A small bump-out can therefore cost less in total than a large addition while costing more per square foot.
The cost question is not only “How many feet are added?” It is “Which fixed layers are being triggered?” A tiny projection that needs a new foundation and roof may be more complex than a larger change using an accessible existing structure.

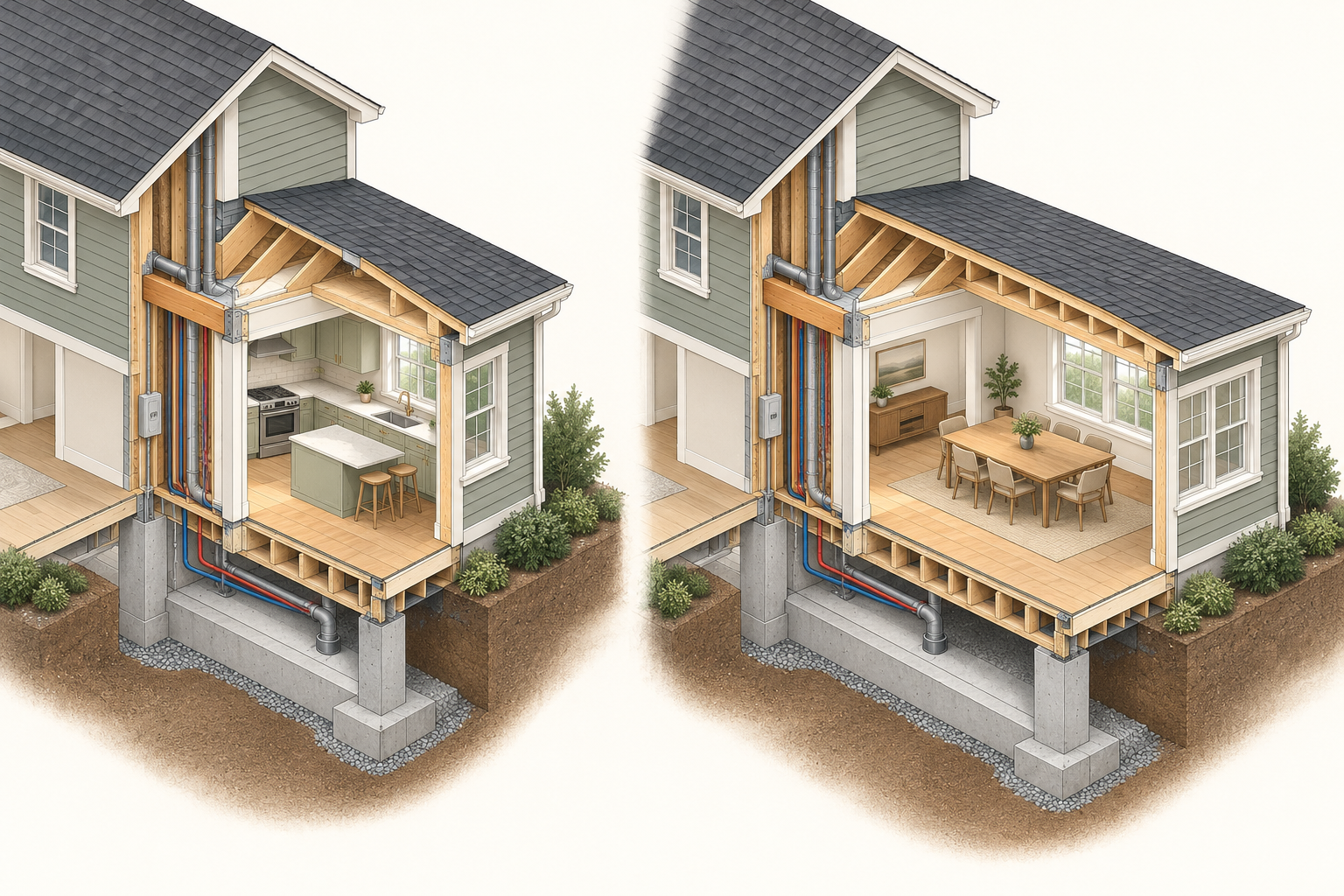

The main cost layers
Support: A foundation-supported bump-out may need excavation, footings, a slab or crawl-space interface, drainage, and connection to the existing structure. An engineered alternative may reduce excavation but cannot be selected from a generic consumer rule or span assumption.
Opening and structure: The existing exterior wall may contain wiring, plumbing, ducts, windows, or structural supports. The quote should explain temporary support, headers or other engineered support, and how the new load is transferred.
Roof and enclosure: Even a small projection needs weather protection. Include roof framing, flashing, cladding, windows, insulation, air sealing, and interior ceiling or floor transitions.
Services and finishes: Extending a circuit or relocating a register may be modest; moving plumbing, adding a sink, or matching old flooring can change the scope. Cabinetry and countertops can make a kitchen bump-out a room-remodel project as well as an addition.
Low, mixed, and difficult scopes
Lower-complexity: A dry room, direct exterior access, an uncomplicated support strategy, nearby electrical, and finishes that can be replaced rather than matched.
Mixed: A foundation or engineered support, a roof tie-in, several affected utilities, and partial flooring, drywall, or siding restoration.
Difficult: Poor access, drainage or soil concerns, a structural wall, plumbing below the work, historic materials, or a requirement to keep the room fully usable throughout construction.
Bump-out or reconfiguration?
If the problem is a crowded kitchen, narrow circulation path, or missing storage, compare the bump-out with rearranging the existing footprint. A reconfiguration may avoid new foundation and exterior work but can require structural opening, utility relocation, and broad finish repair. A bump-out may preserve the existing layout but add shell cost and site constraints.
How to compare quotes
Ask how the contractor will protect the existing room, maintain access, handle weather, and restore the exterior and interior connection. Include a written allowance for concealed utilities only when the allowance has a defined unit or decision process. If the proposal depends on a structural assumption, have that assumption confirmed before treating the number as firm.
The useful comparison is between the function gained and the fixed work triggered. A bump-out that solves a genuine circulation or service problem can be worthwhile; one that adds a little area while triggering a complex foundation and roof may not be.
Ask bidders to state the assumed dimensions and support method, excavation and drainage assumptions, wall-opening and temporary-support scope, roof and flashing details, windows and insulation, electrical/HVAC/plumbing work, finishes and matching, permits, engineering, protection, disposal, and exclusions.
Do not use the consumer label “bump-out” as a scope guarantee. Put the actual construction layers in writing. The project makes economic sense when the added function is worth the fixed cost and the design solves a real space problem that a simpler interior change cannot solve.
Decide what “small” means
Use the proposed footprint and work layers instead of the word “bump-out.” A shallow projection that adds a window seat is not the same project as a foundation-supported expansion that adds dining space, a bathroom, or a new roof. State whether the floor is conditioned, whether the roof changes, and how the new work connects to the existing structure.
Fixed costs versus variable costs
Design, mobilization, protection, demolition, inspection, and finish setup are largely fixed. Area, cabinets, windows, flooring, and some framing are more variable. A small project carries a larger share of fixed cost per square foot. This is why a bump-out should be compared with the function it creates, not with a national unit-rate promise.
Construction and living impacts
The wall opening may remove a kitchen cabinet, window, appliance, duct, or electrical route. Outside, excavation or a new roof can affect drainage, landscaping, and access. Inside, dust, temporary support, floor transitions, and finish matching can make the room unusable. Ask for a sequence and protection plan.
Three quote options
Request a base bump-out, a smaller interior reconfiguration, and—when the site allows it—a larger addition concept. Give all three the same finish level and intended function. Ask each proposal to show the fixed work that remains even if the footprint changes, plus the investigation or allowance that would be removed if an existing-condition question is resolved.
Measure the useful gain
Show the existing and proposed furniture, circulation, doors, windows, and storage. A projection that adds only a narrow strip may not create a usable dining, kitchen, or bathroom layout after wall thickness and insulation are included. Conversely, a modest bump-out can be valuable if it removes a specific bottleneck and lets the rest of the floor plan work.
Ask the designer to identify the new area that is actually conditioned and usable, the area consumed by structure or circulation, and the existing finishes that must be repaired. That makes a small-project comparison more honest than dividing the quote by the gross projection.
Request a complete bump-out, a smaller opening or interior reconfiguration, and—where useful—a larger addition concept. Use the same finish standard and show which costs do not scale with area. If the bump-out needs a bathroom, kitchen work, underpinning, or extensive structural correction, flag those as independent cost layers rather than burying them in a small-project average.
The best bump-out is not the smallest addition. It is the smallest scope that solves the problem without creating a disproportionate foundation, utility, or restoration burden.
Build a small-project scope matrix
Before accepting a bump-out concept, write down the function the extra area must provide. A dining-table extension, a wider kitchen, a bathroom enlargement, and a new bedroom do not trigger the same work. Record the usable area, the wall being opened, the foundation or support concept, roof shape, windows, heating and cooling, electrical and plumbing routes, finishes to be matched, and the access available to the crew.
Then ask which costs are fixed and which scale with area. Design, site protection, mobilization, demolition, the opening in the existing wall, and the final tie-in may occur whether the bump-out is small or slightly larger. Framing, insulation, flooring, paint, and some utility runs may scale more directly. This matrix helps explain why adding a little more area can sometimes improve value, while a smaller projection can still be the better choice if it avoids a foundation or complicated roof.
Compare support options without designing them yourself
A bump-out may be supported by a foundation or by another engineered arrangement, but the safe choice depends on loads, soil, frost, drainage, the existing wall, and local requirements. Do not select a configuration from an internet span rule or a contractor’s verbal assumption. Ask the qualified designer to state what has been assessed and what remains an allowance.
If a support option changes the floor height, roof line, or drainage, price the connection and restoration as part of the option. A support method that looks inexpensive can create a step, a difficult threshold, a water-management problem, or a service relocation. The relevant comparison is the completed room, not the support component in isolation.
Know when the bump-out has changed category
Recheck the classification if the small addition needs a new foundation system, a large roof rebuild, a major service relocation, or substantial interior reconstruction. Those items do not automatically make the project wrong, but they mean the budget should be compared with a fuller addition or a reconfiguration rather than with a simple area-based bump-out. State the change plainly so a compact footprint does not create a falsely compact expectation.
For a final go/no-go, compare the complete usable result with the area and disruption given up elsewhere. Include the room connection, exterior drainage, finishes disturbed at the seam, and the time the affected room will be unavailable. A bump-out earns its place when it solves a specific bottleneck with a proportionate set of interfaces.
The project may no longer be a simple small expansion if it needs a bathroom or kitchen, substantial underpinning, several structural openings, a new service, or broad restoration of the existing room. That does not make the project wrong; it means the scope should be compared with an interior reconfiguration, a larger addition, or a conversion using the same intended function.
At the quote stage, request a base scope and a clearly priced option for each known upgrade. Include allowances for unresolved structure or soil, but identify the investigation that could reduce them. The best decision is the smallest defensible project that solves the bottleneck, preserves durable connections, and leaves no major prerequisite hidden behind a low unit price.
